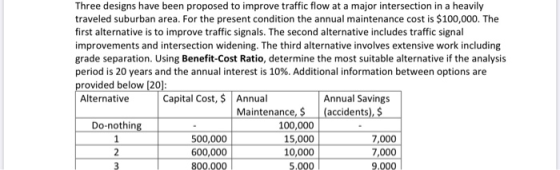

Three designs have been proposed to improve traffic flow at a major intersection in a heavily traveled suburban area. For the
0 0
Add a comment Improve this question Transcribed image text
Answer #1

Given, Annual maintenance cost = 100,000

Doing nothing - For 20 yrs total cost for doing nothing= 100,000*20=2,000,000

BCR=0/2000000= 0

1st alternative-

capital cost =600,000

maintenance cost= 15,000*20= 300,000

savings = 7000/ yr

total savings for 20 years = 422,323

( since annual interest is of 10% compounded annually on savings, first yrs saving compounded annually for 20 yrs, second years for 19 years, third yrs saving compounded for 18 yrs.. and so on..)

Benefit = 422,323, cost = 600000+300000= 900,000,

therefore BCR = 422,323/900000=0.469

Alternative Cost maintenance savings savings for 20 yrs BCR

2nd 600,000 10000*20 7,000 422,323 0.528

3rd 800,000 5000*20 9,000 542,990 0.6033

Thus, constructing a Grade separator will cost initially highest amount but considering the low maintenance cost and savings by safety by accident prevention will yield highest benefit to cost ratio therefore being a better option for 20 years.

Add a comment
Know the answer?
Add Answer to:
Three designs have been proposed to improve traffic flow at a major intersection in a heavily...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • 3. An engineering company has presented three designs to improve traffic flow at a major intersection...

    3. An engineering company has presented three designs to improve traffic flow at a major intersection in a heavily traveled suburban area. The first alternative involves traffic signaling. The second alternative includes traffic signal improvement and intersection widening for exclusive left turns. The third alternative includes extensive reconstruction, including a grade separation structure. The construction costs, as well as annual maintenance and user costs are listed in the following table for each alternative. Determine which alternative is preferred based on...

  • Three alternative designs have been created by engi- neers for a new machine that inspects solar...

    Three alternative designs have been created by engi- neers for a new machine that inspects solar power photovoltaic cells for home use. The costs for the three designs (where x is the annual production rate) follow: 2-19 Design Fixed Cost Variable Cost(S/x) A $100,000 350,000 600,000 20.5x 0.5x 8.0x (a) Management is interested in the production inter- val of 0-150,000 cells per year. Mathematically determine the production volume over which each design (A or B or C) would be chosen....

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
