Question

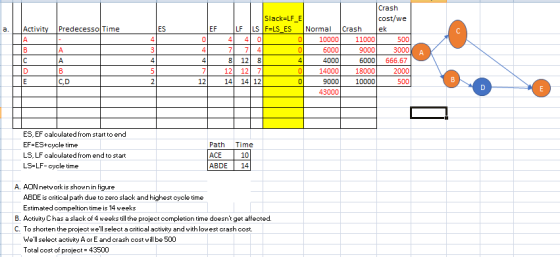

e and then forecast demand 3 3. Here are the precedence requirements, normal and crash times and costs fo ti Preceding Time (weeks) Cos( Activity Activity Normal Crash Normal Cras 4 2 10,000 11,000 000 9,000 A 41 4000 6000 5 3 14,000 18,000 2 9,000 10,000 the AON network, find the critical path and the estimated completion time C 0b) How much slack time does Activity Chave without delaying the projet (CİToshorten the project by one week, which (2 points) fina oal project coot be be shortened and what would the
0 0
Add a comment Improve this question Transcribed image text
Know the answer?
Add Answer to:
e and then forecast demand 3 3. Here are the precedence requirements, normal and crash times...
Your Answer:

Post as a guest
