Question

Your Assignment is to Create a Project Schedule in MS Project. You are to Create a...

Your Assignment is to Create a Project Schedule in MS Project.

  1. You are to Create a Project Schedule using the durations, including Predecessors and Names on each activity
  2. Amir’s Sheds is a successful franchise in the home building industry. Amir’s Sheds build specific purpose sheds for home gardens, farms and industrial storage facilities.

    The project starts on Monday, June 3, 2019

    WBS for Building a Shed

    Task ID

    Task Description

    Predecessor

    Time

    Resources (people and materials required to complete the task)

    2

    Preparation phase

    3

    Design Shed

    3 days

    Designer

    4

    Obtain council approvals

    3

    14 days

    Project manager to submit engineering, design specifications and construction certificates

    5

    Sign Contract

    4\

    1 days

    Project manager

    6

    Construction Phase

    7

    Check existing boundaries

    5

    1 day

    Surveyor,

    8

    Check underground cable locations

    5

    1 day

    Project manager to contact utilities

    9

    Establish site services and amenities

    5

    2 days

    Fence construction team (2), electrician, plumber, require hired toilet, fencing materials

    10

    Excavate site

    7,8,9

    3 days

    Excavation team

    11

    Pour Concrete and wait for it to set

    10

    2 days day

    Construction team

    12

    Install Shed

    11

    2 days

    Construction team

    13

    Completion Phase

    14

    Connect utilities to shed

    12

    2 days

    Electrician, Plumber

    15

    Clean up site

    12

    3 days

    Construction team

    16

    Hand over keys and warranties

    14,15

    1 day

    Project Manager

    17

    Final Payment

    16

    0 days

0 0
Add a comment Improve this question Transcribed image text
Answer #1

Amir’s Sheds is a successful franchise in the home building industry. Amir’s Sheds build specific purpose sheds for home gardens, farms and industrial storage facilities.

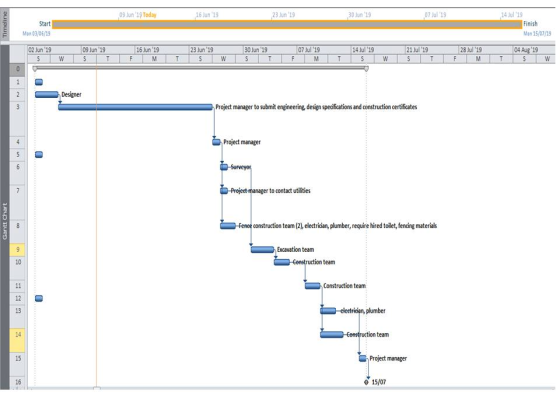

Project schedule-Gantt Chart

Wed 05 Jun Sat 08 Jun Today Fri 14 Jun Mon 17 Jun Thu 20 Jun Sun 23 Jun Wed 26 Jun Tue 02 Jul Fri 05 Jul Mon 08 Jul Thu 11 Ju09 Jun 19 Today 16 Jun 19 30 Jun 19 07 Jul 19 14 Jul 19 Finish 23 Jun 19 Start Man 15/07/19 Mon 03/06/19 07 Jul 19 21 Jul 19

Add a comment
Know the answer?
Add Answer to:
Your Assignment is to Create a Project Schedule in MS Project. You are to Create a...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • Project Schedules and Scheduling Tools In this assignment, you will create a schedule for the month...

    Project Schedules and Scheduling Tools In this assignment, you will create a schedule for the month of December of this year for your team members—John, Sally, Pedro, and Eunice. While creating the schedule, keep in mind the following conditions: Every employee in the company needs to work for 45 hours per week. John works from Saturdays to Wednesdays in the 6:00 a.m. to 4:00 p.m. shift, with a 1-hour lunch break. Sally works from Mondays to Thursdays in the 3:00...

  • 2. Prepare a project schedule for Infotech software company. Assign the relevant resource Name and project...

    2. Prepare a project schedule for Infotech software company. Assign the relevant resource Name and project Starts Calculate the total duration of the project: InfoTech software development company to develop the software by the following task and subtask all the events are linear form. 5/7/2019 on 2. System Design 1.Software Requirement Specification Database Design (3 days) Detailed Design (2 days) Architectural Design (2 days) Requirement gathering (1 day) (3 days) (2 days) (2 days) Data collection Cost Analysis Risk Analysis...

  • (----Project Management----) Node diagram and an estimated cost The project consists of a 10-story building with...

    (----Project Management----) Node diagram and an estimated cost The project consists of a 10-story building with 100 lamps per floor. The floors are completed in ascending order, and only when the floor is completed can the next one begin. Its brigade consists of experts and electrical assistants with the following characteristics: 1) Costs: Electrician expert ($ 16 / hour) 2)Electrician expert assistant ($ 10 / hour) Production: An electrician expert with an electrician expert assistant can install: Perito installs 16...

  • You just completed developing the schedule for your project and got the approval from stakeholders and...

    You just completed developing the schedule for your project and got the approval from stakeholders and the sponsor. One of the team members assigned to work on a critical component informs you that she needs additional time to complete her activities as several relevant pieces were missed during planning. Her updated estimate would have no impact on the critical path; thus, the project duration would be the same. The best approach the project manager may take in this situation will...

  • Your schedule has a critical path of tasks A-D-E-F. A team member tells you that task B, which was originally planned to take 6 days with 5 days of float, has been re-estimated to take 9 days. What ef...

    Your schedule has a critical path of tasks A-D-E-F. A team member tells you that task B, which was originally planned to take 6 days with 5 days of float, has been re-estimated to take 9 days. What effect would you expect this to have on the schedule? Select one: a. Task B would have 1 day of lag b. The project completion date would be increased by 3 days. c. Task B is now part of the critical path...

  • Create a Gantt Chart for the following project, and show the Gantt Chart below. Set a...

    Create a Gantt Chart for the following project, and show the Gantt Chart below. Set a start date of January 6, 2020. Assume that work can be done 5 days per week. Identify the Critical Path. When will the project be completed? Create a Gantt Chart for the following project, and show the Gantt Chart below. Set a start date of January 6, 2020. Assume that work can be done 5 days per week. Identify the Critical Path. When will...

  • You are the project manager's assistant on a construction site. The project manager is off site...

    You are the project manager's assistant on a construction site. The project manager is off site for the day and you are responsible for the ongoing progress of the site in her absence. Two similar beams are delivered to a construction site. Each beam is a hollow box beam, constructed of A36 structural steel, (E=29.0 x 10ʻpsi, density of 490 1bm/ft), each beam having outside dimensions of 16" base and 18" height, 18 feet long. Beam A has top and...

  • You are the project manager's assistant on a construction site. The project manager is off site...

    You are the project manager's assistant on a construction site. The project manager is off site for the day and you are responsible for the ongoing progress of the site in her absence. Two similar beams are delivered to a construction site. Each beam is a hollow box beam, constructed of A36 structural steel, (E=29.0 x 106 psi, density of 490 lbm/ft?), each beam having outside dimensions of 16" base and 18" height, 18 feet long. Beam A has top...

  • You are the project manager's assistant on a construction site. The project manager is off site...

    You are the project manager's assistant on a construction site. The project manager is off site for the day and you are responsible for the ongoing progress of the site in her absence. Two similar beams are delivered to a construction site. Each beam is a hollow box beam, constructed of A36 structural steel, (E=29.0 x 106 psi, density of 490 lbm/ft?), each beam having outside dimensions of 16" base and 18" height, 18 feet long. Beam A has top...

  • Module Three covers refining your project schedule and fine-tuning resources. Table 1-1: Project ...

    Table 1.1 Module Three covers refining your project schedule and fine-tuning resources. Table 1-1: Project Management Process Group and Knowledge Area Mapping (PMBOK Guide® on page 556) provides you with a very specific guideline concerning what task is due for each knowledge area throughout the five projec management process groups. As you can determine from Table 1-1, a large majority of the tasks are complete during the planning process group Describe and explain how sound industry standards or best practices...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
