a)
| Part : | Period | ||||||
| Lot for lot strategy | 0 | 1 | 2 | 3 | 4 | 5 | 6 |
| Gross requirements | 90 | 160 | 170 | 130 | 0 | 110 | |
| Scheduled receipts | |||||||
| Projected available (beg.) | 160 | 160 | 70 | 0 | 0 | 0 | 0 |
| Inv. On hand (End of period) | 70 | 0 | 0 | 0 | 0 | 0 | |
| Net requirements | 90 | 170 | 130 | 0 | 110 | ||
| Planned order receipts | 90 | 170 | 130 | 0 | 110 | ||
| Planned order releases | 90 | 170 | 130 | 0 | 110 | ||
| Lead time | 1 wk | Lot size | lot for lot |
Holding cost = 70*1 = 70
Ordering cost = 4*200 = 800 [As there has been 4 orders]
Total cost = 70+800 = 870
b)
| Part : | Period | ||||||
| EOQ lot sizing (EOQ=200) | 0 | 1 | 2 | 3 | 4 | 5 | 6 |
| Gross requirements | 90 | 160 | 170 | 130 | 0 | 110 | |
| Scheduled receipts | |||||||
| Projected available (beg.) | 160 | 160 | 70 | 110 | 140 | 10 | 10 |
| Inv. On hand (End of period) | 70 | 110 | 140 | 10 | 10 | 100 | |
| Net requirements | 90 | 60 | 100 | ||||
| Planned order receipts | 200 | 200 | 200 | ||||
| Planned order releases | 200 | 200 | 200 | ||||
| Lead time | 1 wk | Lot size | 200 |
Holding cost = (70+110+140+10+10+100)*1 = 440
Ordering cost = 3*200 = 600
Total cost = 440+600 = 1040
c)
| Part : | Period | ||||||
| POQ lot sizing | 0 | 1 | 2 | 3 | 4 | 5 | 6 |
| Gross requirements | 90 | 160 | 170 | 130 | 0 | 110 | |
| Scheduled receipts | |||||||
| Projected available (beg.) | 160 | 160 | 70 | 240 | 70 | 70 | 70 |
| Inv. On hand (End of period) | 70 | 240 | 70 | 70 | 70 | 70 | |
| Net requirements | 90 | 60 | 40 | ||||
| Planned order receipts | 330 | 130 | 110 | ||||
| Planned order releases | 330 | 130 | 110 | ||||
| Lead time | 1 wk | Lot size | POQ |
Holding cost = (70+240+70+70+70+70) = 590
Ordering cost = 3*200 = 600
Total cost = 590+600 = 1190
d) Lot sizing is best as it costs least

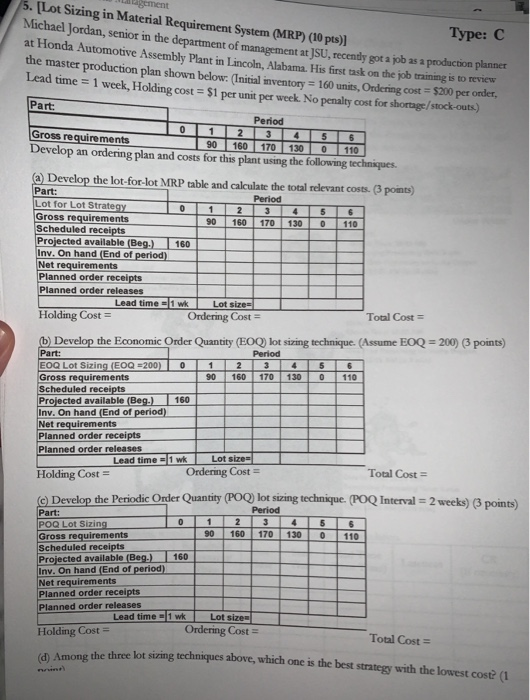

sement 5. [Lot Sizing in Material Requirement System (MRP) (10 pts) Type: C Michael Jordan, senior...
