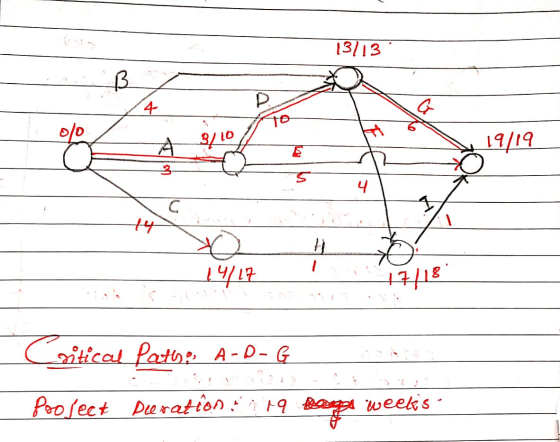

| Activity | Duration | Es | EF | LS | LF | TF |
| A | 3 | 0 | 3 | 0 | 3 | 0 |
| B | 4 | 0 | 4 | 9 | 13 | 9 |
| C | 14 | 0 | 14 | 3 | 17 | 3 |
| D | 10 | 3 | 13 | 3 | 13 | 0 |
| E | 5 | 3 | 8 | 14 | 19 | 11 |
| F | 4 | 13 | 17 | 14 | 18 | 1 |
| G | 6 | 13 | 19 | 13 | 19 | 0 |
| H | 1 | 14 | 15 | 17 | 18 | 3 |
| I | 1 | 17 | 18 | 18 | 19 | 1 |
Q5: A construction project consists of activities, immediate predecessors (IPA) and duration in weeks are as...
Consider the following project where times are in weeks. Activity Duration Immediate Predecessors A B с D E F G H A.B B A с E,F 8 12 7 4 2 3 7 3 DF a) Determine the activity schedule (ES, EF, LS, and LF) as well as slack using the information from the table above (11 marks) b) Determine all the possible paths of this project and determine the shortest possible time this project can be completed? (4 marks)...
The estimated times and immediate predecessors for the activities in a project at ABC Retinal Scanning Company are given in the following table. Assume that the activity times are independent. Activity Immediate Predecessor a (time weeks) m (time weeks) b (time weeks) A - 9 10 11 B - 4 10 16 C A 9 10 11 D B 5 8 11 Calculate the expected time (mean) and variance for each activity, then answer the following: a. What is the...
please
help!!
The estimated times and immediate predecessors for the activities in a project at Howard Umrah's retinal scanning company are given in the following table. Assu that the activity times are independent. Time (weeks) Immediate Time (weeks) Immediate Activity a bPredecessor(s)Activitya bPredecessor(s) 12 10 12 8 17 This exercise contains only parts a, b, c, d, and e a) Based on the activity time estimates, the expected times and variance for each of the activities are (round your response...
Question 8-10, CHAPTER 18: A home-remodeling project consists of eight activities. The immediate predecessors and activity times in weeks are shown below. Activity Predecessor(s) Normal Time Crash Time Normal Cost $400 Crash Cost $700 1600 2000 800 1100 1000 NNW 600 1200 1450 800 800 500 650 400 600 900 1300 F G H1 1000 650 8. Draw the network for this project. (10 points) 9. Please indicate the Earliest Start, Earliest Finish, Latest Start, and Latest Finish on the...
HW Score: 62.5%,5 of The estimated times and immediate predecessors for the activities in a projects Howard Urinalarning company are given in the following assume that the activity times are independent Question Help Activity . Immediate Predecessor) А 8 Time (weeksi . Predecessors Activity b 8 10 С 7 19 13 4 10 18 D 6 10 14 This exercise contains only parts , bedande a) Based on the activity time estimate the expected times and variance for each of...
The following represent activities in Marc Massoud's Construction Company project: Activity Immediate Predecessor(s) Time (weeks) Activity Immediate Predecessor(s) Time (weeks) = C, E WLUI WNVN = n a a) Choose the correct network to represent this situation. OA. OB b) The critical path is B-E-F-H c) The length of the critical path is . weeks.
The estimated times and immediate predecessors for the activities in a project at Caesar Douglas’s screening company are given in the following table. Assume that the activity times are independent. All times are in weeks. Activity Predecessors Optimistic Time (a) Most Likely Time (m) Pessimistic Time (b) A -- 9 10 11 B -- 4 10 16 C A 9 10 11 D B 5 8 11 What is the critical path based on expected times? You may use any...
A project has the following set of activities Activity Immediate Predecessor Duration (weeks) A - 8 B - 10 C A 3 D A 7 E B, C 6 F B, C 7 G D, E 5 H F 3 Draw the AON diagram Identify all the possible paths What is the critical path? Can activity B be delayed without delaying the completion of the project? If so, by how many days?
The estimated times and immediate predecessors for the activities in a project at Howard Umrah's retinal scanning company are given in the following table. Assume that the activity times are independent This exercise contains only parts a, b, c, d, and e. a) Based on the activity time estimates, the expected times and variance for each of the activities are (round your response to two decimal places): ExpectedActivityTimeWarlanceA9.830.26010.336.44C10.001.00010.001.78b) The expected completion time of the critical path weeks fround your response to two decimal...
please answer this problem
Answer all questions Consider a project consisting of 12 activities and their duration along with precedence as follows: Activity Precedence Duration (Days) B,C D,F.H IJ 10 5 marks Questionl Analyze the critical path to determine the total duration for the completion of the project Question2: Compute slack time for each task and analyze the appropriateness of the slack time and its usage in the process [5 marks] [5 marks Question3: Determine appropriate technological solution for the...
