Question

The estimated times and immediate predecessors for the activities in a project at Caesar Douglas’s screening...

The estimated times and immediate predecessors for the activities in a project at Caesar Douglas’s screening company are given in the following table. Assume that the activity times are independent. All times are in weeks.

Activity

Predecessors

Optimistic Time (a)

Most Likely Time (m)

Pessimistic Time (b)

A

--

9

10

11

B

--

4

10

16

C

A

9

10

11

D

B

5

8

11

  1. What is the critical path based on expected times? You may use any method to determine this?

Critical Path is A-C

KqEXqlnmZWUm2TWzHKLy0LgrMIRBEK4qRILqSVBW

  1. What is the probability of completing the project in 22 weeks or less?
0 0
Add a comment Improve this question Transcribed image text
Answer #1

Answer

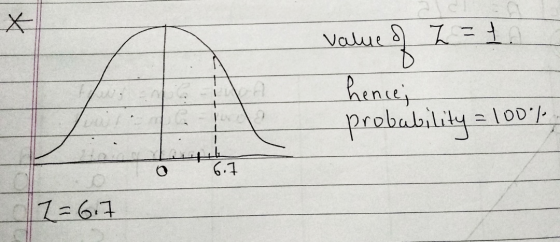

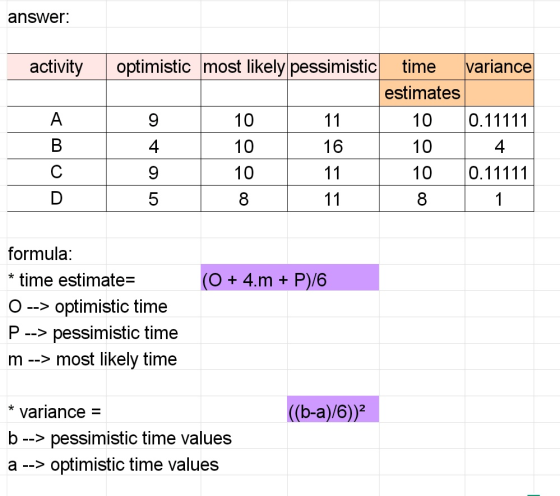

answer: activity optimistic most likely pessimistic A 9 4 9 5 / 10 10 10 8 time variance estimates 10 0.11111 10 4 10 0.11111activity of node diagram; 0 A 10 10 C 19 0 10 10 10 10 19 19 finish OB 10 10 D 18 11 10 11 11 8 19 a) critical path: A-C compvalue of L = 1. hence; probability = 100% Z=6.7

(Hope it helps you. Please like the answer it will encourage me.)

Add a comment
Know the answer?
Add Answer to:
The estimated times and immediate predecessors for the activities in a project at Caesar Douglas’s screening...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • The estimated times and immediate predecessors for the activities in a project at ABC Retinal Scanning...

    The estimated times and immediate predecessors for the activities in a project at ABC Retinal Scanning Company are given in the following table. Assume that the activity times are independent. Activity Immediate Predecessor a (time weeks) m (time weeks) b (time weeks) A - 9 10 11 B - 4 10 16 C A 9 10 11 D B 5 8 11 Calculate the expected time (mean) and variance for each activity, then answer the following: a. What is the...

  • The estimated times and immediate predecessors for the activities in a project

    The estimated times and immediate predecessors for the activities in a project at Howard Umrah's retinal scanning company are given in the following table. Assume that the activity times are independent This exercise contains only parts a, b, c, d, and e. a) Based on the activity time estimates, the expected times and variance for each of the activities are (round your response to two decimal places): ExpectedActivityTimeWarlanceA9.830.26010.336.44C10.001.00010.001.78b) The expected completion time of the critical path weeks fround your response to two decimal...

  • Please provide detailed solutions to the following problem. The estimated times and immediate predecessors for the...

    Please provide detailed solutions to the following problem. The estimated times and immediate predecessors for the activities in a project at Paccar Winch are given in the following table. Assume that the activity times are independent. Activity Immediate Predecessor Time (Weeks) a m b A - 9 10 11 B - 4 10 16 C A 9 10 11 D B 5 8 11 a) Calculate the expected time and variance for each activity. b) What is the expected completion...

  • please help!! The estimated times and immediate predecessors for the activities in a project at Howard...

    please help!! The estimated times and immediate predecessors for the activities in a project at Howard Umrah's retinal scanning company are given in the following table. Assu that the activity times are independent. Time (weeks) Immediate Time (weeks) Immediate Activity a bPredecessor(s)Activitya bPredecessor(s) 12 10 12 8 17 This exercise contains only parts a, b, c, d, and e a) Based on the activity time estimates, the expected times and variance for each of the activities are (round your response...

  • HW Score: 62.5%,5 of The estimated times and immediate predecessors for the activities in a projects...

    HW Score: 62.5%,5 of The estimated times and immediate predecessors for the activities in a projects Howard Urinalarning company are given in the following assume that the activity times are independent Question Help Activity . Immediate Predecessor) А 8 Time (weeksi . Predecessors Activity b 8 10 С 7 19 13 4 10 18 D 6 10 14 This exercise contains only parts , bedande a) Based on the activity time estimate the expected times and variance for each of...

  • PERT Analysis: The following represents a project with four activities. All times are in weeks. Activity Immediate Predecessor Optimistic Time Most Likely Time Pessimistic Time A -...

    PERT Analysis: The following represents a project with four activities. All times are in weeks. Activity Immediate Predecessor Optimistic Time Most Likely Time Pessimistic Time A - 3 8 14 B - 8 8 8 C A 6 9 18 D B 6 11 17 According to the data in the above Table: What is the critical path? What is the minimum expected completion time for the project? According to the above Table, there are four activities in the project....

  • Data regarding the activities for a project are presented below. The times are in weeks. The...

    Data regarding the activities for a project are presented below. The times are in weeks. The critical path for this project is A - D - H - I - J - K. Activity Optimistic Time Most Likely Time Pessimistic Time A 7 9 14 B 2 2 8 C 8 12 16 D 3 5 10 E 4 6 8 F 6 8 10 G 2 3 4 H 2 2 8 I 6 8 16 J 4 6...

  • Using the following information about Project A, its activities and predecessor activities below: Activity Predecessors A...

    Using the following information about Project A, its activities and predecessor activities below: Activity Predecessors A в B C D E, F D G The following table contains the pessimistic, likely, and optimistic estimates for how long activities are estimated to take for Project A. Activity Pessimistic Likely Optimistic 2 5 20 H 16 e. Calculate the time estimates (TE) f. Calculate the variance (s) g. Convert the TE to whole integers and place them in the network diagram for...

  • A small software development project has eight major activities. The times are estimated and prov...

    A small software development project has eight major activities. The times are estimated and provided in the table below: Activity Optimistic Time Most Likely Time Pessimistic Time Immediate Predecessor(s) A 3 4 5 -- B 5 7 9 -- C 2 3 10 A D 2 5 8 B E 1 7 7 B F 3 5 7 C, D G 7 8 9 D, E H 2 6 10 F Answer the following questions based on above table 1-2...

  • (50 points) Data regarding the activities for a project are presented below. The times are in...

    (50 points) Data regarding the activities for a project are presented below. The times are in weeks The critical path for this project is A-D-H-I-J-K 2. Pessimistic Time Most Likely Time y Optimistic Time 8 16 10 8 10 12 8 14 5 6 2 a. Determine the standard deviation of the critical path. b. Determine the probability of completing the project in 38 weeks or less c What is the probability of completing the project in 32 weeks or...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
