(e) time estimate (TE) = (TO + 4TM + TP)/ 6
Where TO = OPTIMISTIC TIME
TM = likely time
TP= PESSIMISTIC time
(f) standard deviation = (TP- TO)/6
VARIANCE = Square of standard deviation
Where TP= pessimistic time
TO= optimistic time

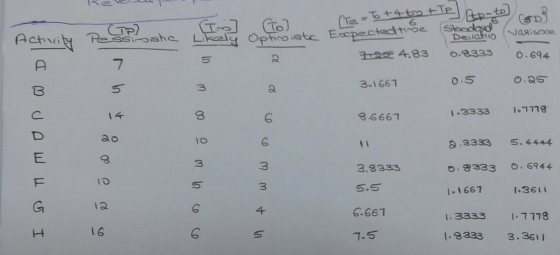

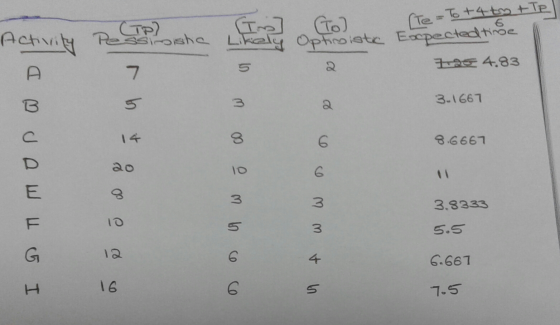

![To +4 tot TE EER to Ap-to]. go [In] Likely Te To +4 totle Espectedt To ptimiste Activity Pelisha Vasiloxe Stodos Delah 0.8333](http://img.homeworklib.com/questions/6c37aa20-725c-11ea-9271-03b8186e758c.png?x-oss-process=image/resize,w_560)
(g)

(H) (ì)(j)(k)

(l) Total float or slack comes zero only for activity in critical path. Hence our answer in (h) is confirmed.

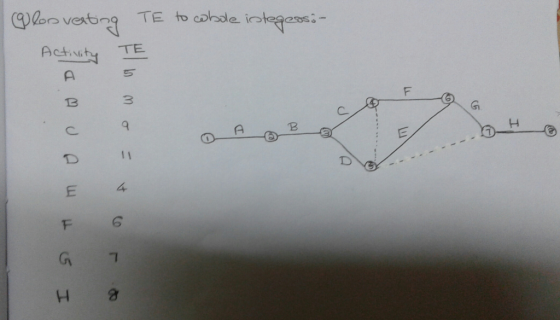

The critical path are A-B-D-E-G-H and A-B-C-F-G-H
(J) Standard deviation of project = square root of variance of expected time of project
Variance of expected time = sum of variances of critical path activities
= 0.694+ 0.25+ 5.4444+0.6944+1.7778+3.3611
= 12.2213 (for critical path A-B-D-E-G-H)
Standard deviation of project= square root of variance
= 3.4959
For critical path A-B-C-FG-H , standard deviation = 3.036
Note: time limitation for answering last part

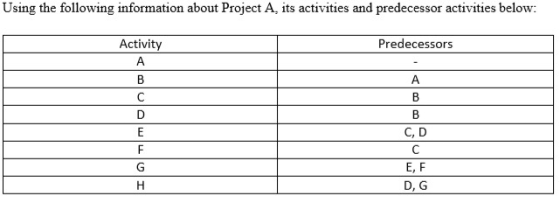

Using the following information about Project A, its activities and predecessor activities below: Activity Predecessors A...
