Question

Development of Version 20 of a particular accounting software product is being considered by Jose Nogueras technology form i
d) The maximum weeks by which the project can be reduced by crashing = 7 weeks. Total cost of crashing the project to minimum
0 0
Add a comment Improve this question Transcribed image text
Answer #1

Answer: d) 7 weeks, $1330

Initial duration of project = 16 weeks

After maximum possible crashing, Project duration = 9 weeks.

The maximum weeks by which the project can be reduced = 16 -9 =7 weeks

Crashing Cost:

Crashing Cost of Activity D by 4 weeks = $280

Crashing Cost of Activity G by 2 weeks = $300

Crashing cost of Activity A & E by 1 week = $650 + $100 =$750

Total Crashing Cost = 280 + 300 + 750 = $1330

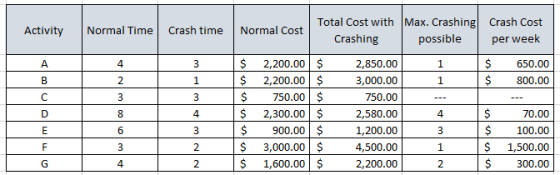

Activity Normal Time Crash time Normal Cost Total Cost with Max. Crashing Crashing possible Crash Cost per week 4 3 $ 2,200.0

Network Diagram:

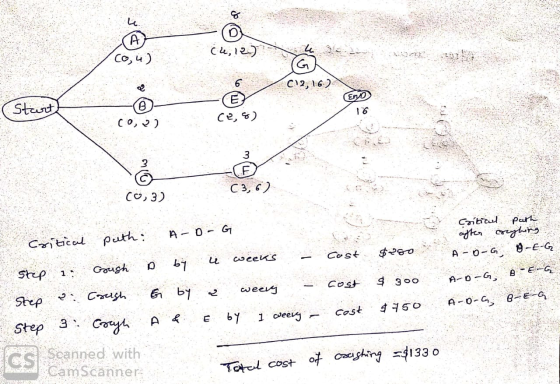

Cl, 12) CO, 4 ) C12, 162 End St B CO ) (0,3) Criticul path after coughing -E-G2 Critical puth - step i Gush Step 2 Cough Step

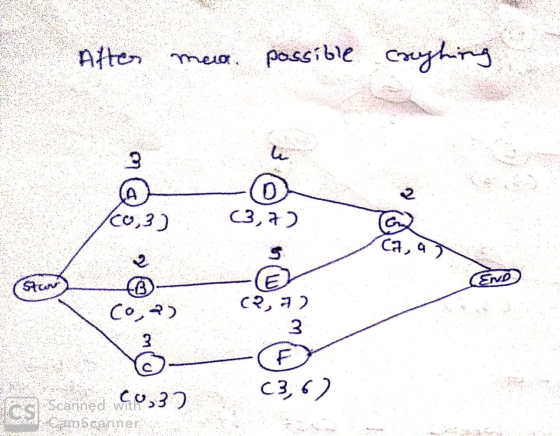

After mea. possible crushing 3,7 End 02,72 BS Scarined wqu32 hak cam Seanner

Add a comment
Know the answer?
Add Answer to:
Development of Version 20 of a particular accounting software product is being considered by Jose Noguera's...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • Development of Version 2.0 of a particular accounting software product is being considered by Jose Noquera's...

    Development of Version 2.0 of a particular accounting software product is being considered by Jose Noquera's technology firm in Baton Rouge. The activities necessary for the completion of this project are listed in the following table: To Cost Normal Time (weeks) Crash Time Normal with Activity (weeks) Cost Crashing Immediate Predecessor(s) $2.700 A $2,000 7 $2,300 S3,100 3 $500 $500 S2,300 $2,580 A E 5900 $1.275 F F $3.400 2 S4,800 C G $1,500 $2.100 D, E a) Based on...

  • Development of Version 2.0 of a particular accounting software product is being considered by Jose Noguera's...

    Development of Version 2.0 of a particular accounting software product is being considered by Jose Noguera's technology firm in Baton Rouge. The activities necessary for the completion of this project are listed in the following table: Activity A Normal Time Crash Time Normal (weeks) (weeks) Cost 4 3 $2,000 2 $2,100 $750 Total Cost with Immediate Crashing Predecessor(s) $2,650 - $2,800 - $750 B 2 3 $2.400 $2,680 Ā $900 3 § $1,200 3 $900 $3,200 § $4,600 $9,500 $2,000...

  • Development of Version 2.0 of a particular accounting software product is being considered by Jose​ Noguera's...

    Development of Version 2.0 of a particular accounting software product is being considered by Jose​ Noguera's technology firm in Baton Rouge. The activities necessary for the completion of this project are listed in the following​ table:                                                                                                                                  Activity Normal Time​(weeks) Crash Time​(weeks) Normal Cost Total Cost with Crashing Immediate​ Predecessor(s) A 44 33 $ 2 comma 000$2,000 $ 2 comma 650$2,650 long dash— B 22 11 $ 2 comma 200$2,200 $ 3 comma 000$3,000 long dash— C 33 33 $...

  • oblem S.ST evelopmient of Version 2 0 of a particular accounting software product is being considered...

    oblem S.ST evelopmient of Version 2 0 of a particular accounting software product is being considered by Jose Noguera's ompletion of this projedt are listed in the following table: technology firm in Baton Rouge. The activities necessary to Total Cost Normal Time Crash Time Normal with (weeks) Cost Crashing Immediate Predecessors) S2,000 $2.600 S2,300 $3,100 S750 $750 S2,500 $2.780 $1,000 $1,375 $3.000 S4,200 $1400 $2.000 D E a) Based on the given information regarding the activities for the project,the project...

  • 1) Based on the given information regarding the activities for the project, the project length= ___...

    1) Based on the given information regarding the activities for the project, the project length= ___ weeks. 2) The total cost required for completing this project on normal time= $____ 3) For reducing the duration of the project by one week, the activity that should be crashed first is activity ___. 4) The cost of the project based on the first activity selected for crashing will increase by $___. 5) The maximum weeks by which the project can be reduced...

  • Development of a new deluxe version of a particular toy is being considered by T-O-Y Inc....

    Development of a new deluxe version of a particular toy is being considered by T-O-Y Inc. The activities necessary for the completion of this project along with the relevant information for each activity are listed in the following table. The Total Crash Time represents the time for that activity after it has been crashed the maximum crash time allowed for that activity. For example, we can reduce the time for Activity A by one week to 3 weeks after crashing...

  • Kimpel Products makes pizza ovens for commercial use. James Kimpel, CEO, is contemplating producing smaller ovens...

    Kimpel Products makes pizza ovens for commercial use. James Kimpel, CEO, is contemplating producing smaller ovens for use in high school and college kitchens. The activities necessary to build an experimental model and related data are listed in the following table: Activity A Normal Time (weeks) 3 Crash Time (weeks) 2 B 2 1 1 Normal Cost $1,200 $2,000 $400 $1,500 $950 $4,500 $1,600 Total Cost with Immediate Crashing Predecessor(s) $1,800 $2,800 $400 $1,820 A $1,250 B $5,500 с $2,300...

  • For the following project: Normal Time Crash Time Normal Cost Crash Cost Immediate (weeks 4. Activity...

    For the following project: Normal Time Crash Time Normal Cost Crash Cost Immediate (weeks 4. Activity Predecessor (weeks) $2,600 $2,800 $2,000 $2,200 $500 $2,300 $900 $3,000 $500 $2,600 $1,200 $4,200 $1,400$2,000 4 D, E How long will the project take? What is the total cost to complete the project in normal time? If the project is to be shortened by 1 week, which activity will be reduced and how much will the cost be increased? What is the maximum time...

  • Solve the following project crashing problem adopted from Heizer et al. (2016). Attempt the question before looking up the solution on Page 855 of Heizer et. al. 2016 3.32Kimpel Products makes pi...

    Solve the following project crashing problem adopted from Heizer et al. (2016). Attempt the question before looking up the solution on Page 855 of Heizer et. al. 2016 3.32Kimpel Products makes pizza ovens for commercial use. James Kimpel, CEO, is contemplating producing smaller ovens for use in high school and college kitchens. The activities necessary to build an experimental model and related data are given in the following table: NORMAL CRASH TIME TIME NORMALI CRASH! IMMEDIATE ACTIVITY (WEEKS) (WEEKS) COST...

  • Normal Time Crash Time Normal with Activity (weeks) (weeks) Cost Crashing Immediate Predecessor(s) $1,400 A 3...

    Normal Time Crash Time Normal with Activity (weeks) (weeks) Cost Crashing Immediate Predecessor(s) $1,400 A 3 2 $2,050 $2,800 B 2 1 $2,100 1 1 $350 $350 7 $1,400 $1,700 A 6 3 $900 $1,200 $5,000 $2,000 F 2 $4,000 $1,500 C 4 G 2 D, E weeks a) Based on the given information regarding the activities for the project, the project completion date b) To reduce the duration of the project to 10 weeks at the least cost, the...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
