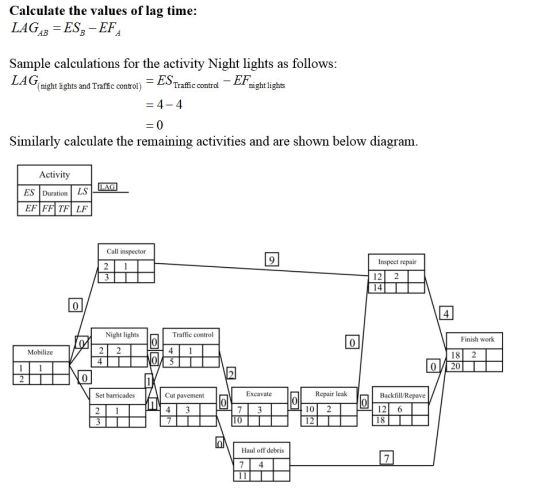

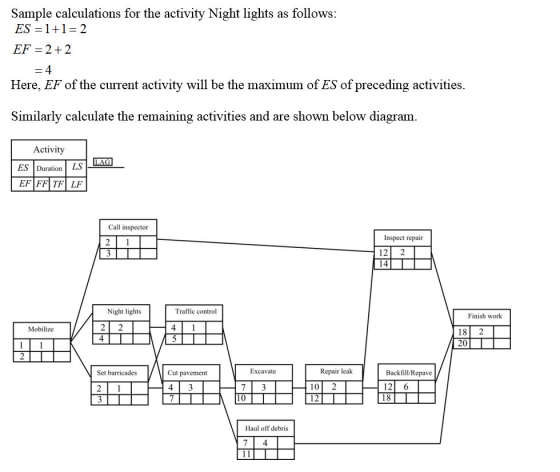

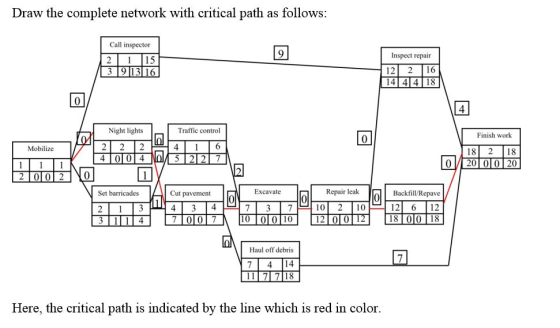

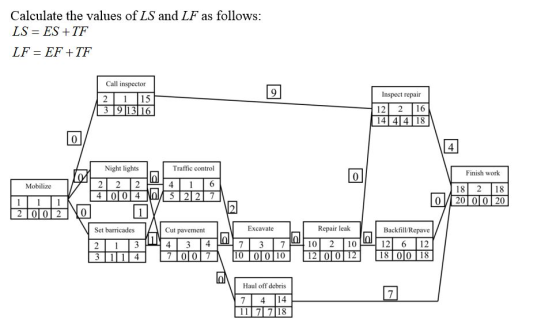

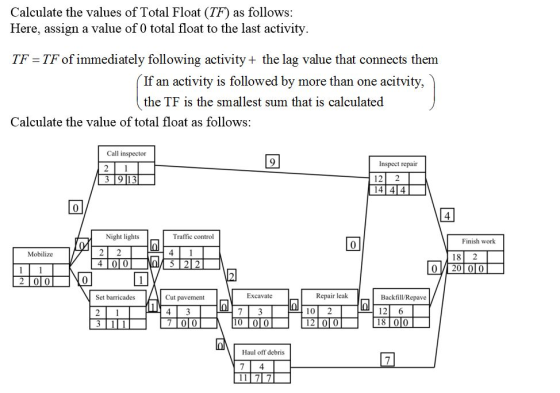

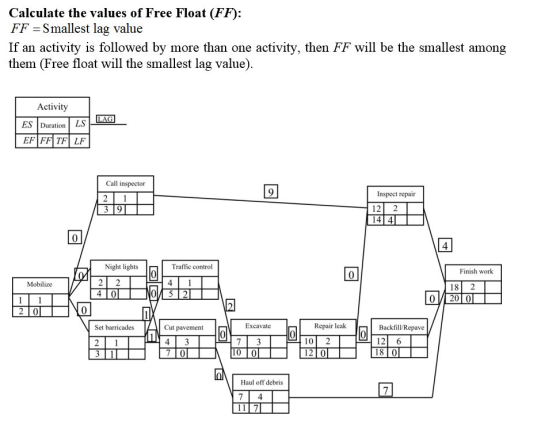

For a sewer repair project, the following activities are needed. Set up a network diagram showing all the logical dependencies, floats, and project duration. Note that activities are not listed in a sequential order.
| Activity | Order |
|---|---|
| Inspect Repair | |
| Call Inspector | |
| Haul off Debris | |
| Mobilize | |
| Set up Traffic Control | |
| Set Barricades | |
| Excavate | |
| Finish Work | |
| Cut Pavement | |
| Backfill/Repave | |
| Repair Leak | |
| Set up Night Lights |
How can we assess whether a project is a success or a
failure?
This case presents two phases of a large business transformation project involving the implementation of an ERP system with the aim of creating an integrated company. The case illustrates some of the challenges associated with integration. It also presents the obstacles facing companies that undertake projects involving large information technology projects. Bombardier and Its Environment Joseph-Armand Bombardier was 15 years old when he built his first snowmobile...
