The following represents a project that should be scheduled
using CPM:
| IMMEDIATE PREDECESSORS | TIMES (DAYS) | |||
| ACTIVITY | a | m | b | |
| A | — | 1 | 4 | 7 |
| B | — | 2 | 6 | 13 |
| C | A | 1 | 1 | 4 |
| D | A | 2 | 3 | 4 |
| E | B | 2 | 4 | 6 |
| F | C,D | 1 | 5 | 9 |
| G | D,E | 1 | 2 | 9 |
| H | F,G | 3 | 6 | 9 |
b. What is the critical path?
A-D-G-H
B-E-G-H
A-D-F-H
A-C-F-H
c. What is the expected project completion time? (Do not round intermediate calculations. Round your answer to 3 decimal places.)
|
d. What is the probability of completing this project within 20 days? (Use Excel's NORM.S.DIST() function to find the correct probability for your computed Z-value. Do not round intermediate calculations. Round "z" value to 2 decimal places and final answer to 4 decimal places.)
| Probability |

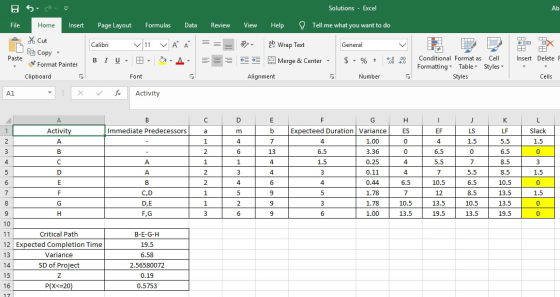

Below is the screenshot of the formula applied -

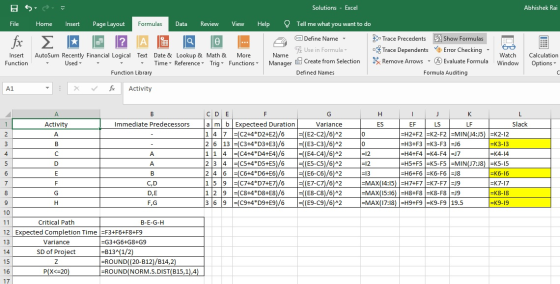

Below is the screenshot of the result -

The following represents a project that should be scheduled using CPM: IMMEDIATE PREDECESSORS TIMES (DAYS) ACTIVITY...
The following represents a project that should be scheduled using CPM: TIMES (DAYS) ACTIVITY IMMEDIATE PREDECESSORS a m b A — 1 3 5 B — 1 2 3 C A 1 2 3 D A 2 3 4 E B 3 4 11 F C, D 3 4 5 G D, E 1 4 6 H F, G 2 4 5 b. What is the critical path? A-C-F-H A-D-F-H B-E-G-H A-D-G-H c. What is the expected project completion time?...
The following represents a project that should be scheduled using CPM: TIMES (DAYS) IMMEDIATE b ACTIVITY PREDECESSORS m a 1 4 7 3 5 10 B 2 5 4 6 11 D B 1 2 3 E C,D D,E F,G 3 5 7 F G 1 2 6 2 5 b. What is the critical path? A-D-F-H A-D-G-H B-E-G-H A-C-F-H c. What is the expected project completion time? (Do not round intermediate calculations. Round your answer to 3 decimal places.)...
Problem 5-10 (Algo) The following represents a project that should be scheduled using CPM: IMMEDIATE PREDECESSORS TIMES (DAYS) ACTIVITY a m b A — 1 4 7 B — 1 3 5 C A 2 5 11 D A 1 8 9 E B 1 2 3 F C,D 1 6 11 G D,E 1 2 3 H F,G 2 3 3 b. What is the critical path? a. A-D-F-H b. B-E-G-H c.A-D-G-H d.A-C-F-H c. What is the expected project...
The following represents a project that should be scheduled using CPM: Intermediate Times(Days) Activity Predecessors a m b A ----- 1 2 6 B ----- 1 2 9 C A 2 2 11 D A 1 8 9 E B 1 2 3 F C,D 3 4 11 G D,E 1 3 11 H F,G 2 3 11 What is the critical path? What is the expected project completion time? (Round your answer to 3 decimal places.) Project completion time...
Problem 5-10 The following represents a project that should be scheduled using CPM: IMMEDIATE PREDECESSORS TIMES (DAYS) ACTIVITY a m b A — 1 4 7 B — 3 5 10 C A 2 5 8 D A 4 6 11 E B 1 2 3 F C,D 3 5 7 G D,E 1 2 6 H F,G 2 5 6 b. What is the critical path? B-E-G-H A-D-G-H A-D-F-H A-C-F-H c. What is the expected project completion time? (Round...
Problem 5-10 The following represents a project that should be scheduled using CPM: IMMEDIATE TIMES (DAYS) ACTIVITY PREDECESSORS a m b А 7 B 2 3 7 с A 3 5 7 D А 5 6 10 E B 1 2 6 F CD 1 3 6 DE 1 3 14 H F G 5 14 b. What is the critical path? A-D-G-H B-E-G-H A-D-F-H A-C-F-H c. What is the expected project completion time? (Round your answer to 3 decimal...
The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR TIME (WEEKS) A — 3 B A 9 C A 5 D C 2 E B D 7 F D 6 G E F 4 b. What is the critical path? A-B-D-F-G A-B-E-G A-C-D-F-G A-C-D-E-G c. How many weeks will it take to complete the project? Number of weeks d. How much slack does activity B have? Slack of activity B week(s)
Given the following activities and precedents, draw a PERT/CPM diagram. ACTIVITY IMMEDIATE PREDECESSOR DURATION (DAYS) A - 10 B - 12 C A 4 D A, B 8 E A, B 9 F C 10 G D, F 12 H E, G 15 Answer the following: What is the critical path? How long will it take to complete this project? Can activity E be delayed without delaying the completion of the project? If so, how many days?
I need help with the following problem. Schedule the following activities using CPM. ACTIVITY Immediate Predecessors Time in Weeks A ---- 2 B A 5 C A 4 D B 3 E C, D 6 F D 3 G F 3 H E, G 4 Draw the network diagram below using the square activity I have provided. Just select the object, then copy it and paste how many you need and then arrange them in the order you need and...
Given is a CPM project network diagram as shown below.
Activity
Start
A
B
C
D
E
F
G
H
End
day
0
5
6
9
6
9
8
5
4
0
a) The Project Completion time = days.
b) The Earliest Start time, ES, of Activity G = days.
c) The Latest Finish time, LF, of Acitivity C = days..
d) The critical activities are = (ex. Fill in answer as: ABCD)
End Start
