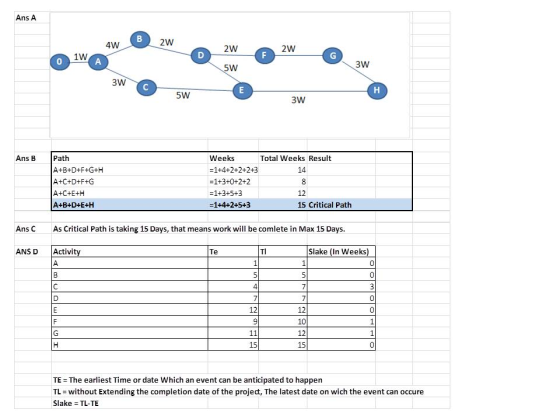

Schedule the following activities using CPM:
| ACTIVITY | IMMEDIATE PREDECESSOR | TIME (WEEKS) |
| A | — | 1 |
| B | A | 4 |
| C | A | 3 |
| D | B | 2 |
| E | C, D | 5 |
| F | D | 2 |
| G | F | 2 |
| H | E, G | 3 |
b. What is the critical path?
| A-B-D-F-G-H | |
| A-C-D-F-G | |
| A-C-E-H | |
| A-B-D-E-H |
c. How many weeks will it take to complete the project?
Number of weeks
d. Which activities have slack, and how much?
| D, 2 weeks; G, 1 week; and H, 1 week. | |
| C, 3 weeks; F, 1 week; and G, 1 week. | |
| B, 3 weeks; D, 1 week; and E, 1 week. |
Schedule the following activities using CPM: ACTIVITY IMMEDIATE PREDECESSOR TIME (WEEKS) A — 1 B A...
Schedule the following activities using CPM: Table 2 ACTIVITY IMMEDIATE PREDECESSOR TIME (WEEKS) A — 8 B A 4 C A 4 D C 8 E B, D 2 F D 6 G E, F 2 Question 25 (1 point) What is the critical path? (Show your diagram and calculations) Question 25 options: A-C-D-E-G A-B-E-G A-B-D-E-G A-C-D-F-G A-B-D-F-G How many weeks will it take to complete the project? What is B slack time?
The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR TIME (WEEKS) A — 3 B A 9 C A 5 D C 2 E B D 7 F D 6 G E F 4 b. What is the critical path? A-B-D-F-G A-B-E-G A-C-D-F-G A-C-D-E-G c. How many weeks will it take to complete the project? Number of weeks d. How much slack does activity B have? Slack of activity B week(s)
chedule the following activities using CPM:
ACTIVITY
IMMEDIATE PREDECESSOR
TIME (WEEKS)
A
—
5
B
A
3
C
A
4
D
B
6
E
C
D
8
F
D
2
G
F
4
H
E
G
3
b. What is the critical path?
A-B-D-E-H
A-B-D-F-G-H
A-C-E-F-G-H
A-C-E-H
c. How many weeks will it take to complete the
project?
d. Which activities have slack, and how
much?
B
1 week
H
2 weeks
F
4 weeks.
C
5 weeks
F
2...
Problem 5-7 The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR TIME (WEEKS) А 7 B 6 2 3 B.D D b. What is the critical path? Оооо A-C-D-E-G A-B-D-F-G A-B-E-G O A-C-D-F-G c. How many weeks will it take to complete the project? Number of weeks d. How much slack does activity B have? Slack of activity B week(s)
Problem 5-7 The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR TIME (WEEKS) A — 7 B A 6 C A 2 D C 4 E B D 3 F D 4 G E F 6 b. What is the critical path? A-B-D-F-G A-C-D-E-G A-C-D-F-G A-B-E-G c. How many weeks will it take to complete the project? Number of weeks d. How much slack does activity B have? Slack of activity B week(s)
I need help with the following problem. Schedule the following activities using CPM. ACTIVITY Immediate Predecessors Time in Weeks A ---- 2 B A 5 C A 4 D B 3 E C, D 6 F D 3 G F 3 H E, G 4 Draw the network diagram below using the square activity I have provided. Just select the object, then copy it and paste how many you need and then arrange them in the order you need and...
From this schedule of activities: Activity Immediate Predecessor Activity Time A --- 4 B A 2 C B 3 D B 5 E A 1 F C, D 3 G E, F 2 a. Draw the PERT/CPM network b. Complete the forward and backward pass c. Determine the critical path d. Determine the total duration of the project.
Given the following activities and precedents, draw a PERT/CPM diagram. ACTIVITY IMMEDIATE PREDECESSOR DURATION (DAYS) A - 10 B - 12 C A 4 D A, B 8 E A, B 9 F C 10 G D, F 12 H E, G 15 Answer the following: What is the critical path? How long will it take to complete this project? Can activity E be delayed without delaying the completion of the project? If so, how many days?
The following represent activities in Marc Massoud's Construction Company project: Activity Immediate Predecessor(s) Time (weeks) Activity Immediate Predecessor(s) Time (weeks) = C, E WLUI WNVN = n a a) Choose the correct network to represent this situation. OA. OB b) The critical path is B-E-F-H c) The length of the critical path is . weeks.
A project has the following set of activities Activity Immediate Predecessor Duration (weeks) A - 8 B - 10 C A 3 D A 7 E B, C 6 F B, C 7 G D, E 5 H F 3 Draw the AON diagram Identify all the possible paths What is the critical path? Can activity B be delayed without delaying the completion of the project? If so, by how many days?
