Question

                           Barbara​ Gordon, the project manager for Web​ Ventures, compiled a table showing time estimate for each...

                          

Barbara​ Gordon, the project manager for Web​ Ventures, compiled a table showing time estimate for each of the​company's manufacturing activities of a project. The list of​ activities, immediate​ predecessors, and estimated times appear in the following​ table:                                                                               

Activity

Immediate​ Predecessor(s)

Time​ (days)

A

-

4

B

-

6

C

-

1

D

B

10

E

​A, D

F

C

5

G

​E, F

12

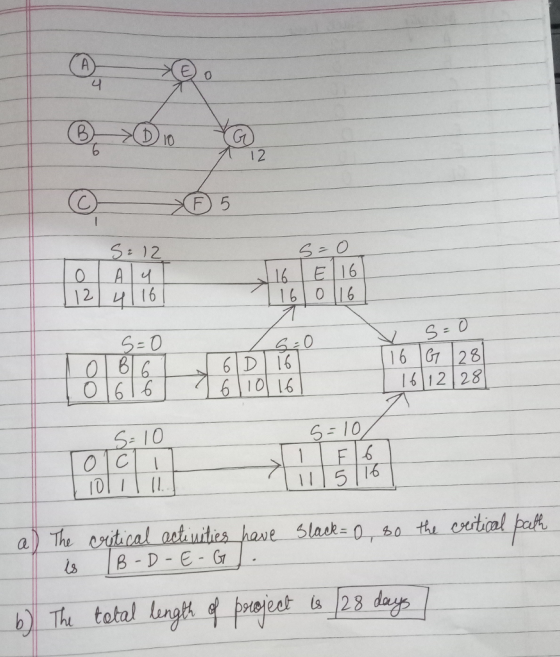

​a) Therefore, the critical activities for the manufacturing project are (A - E - G, C - F - G, B - D - E - G).

​b) The total length for the manufacturing project​ = ? days.

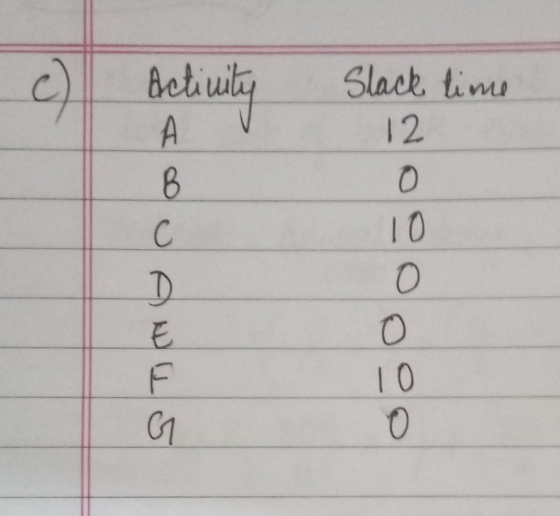

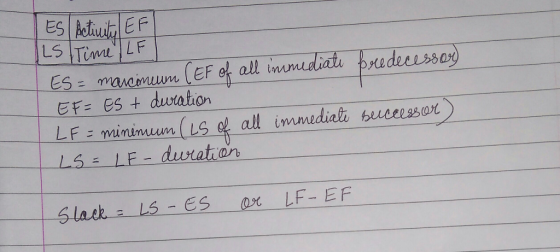

​c) Slack time for each of the activities are as​ follows:

Activity

Slack Time

A

?

B

?

C

?

D

?

E

?

F

?

G

?

0 0
Add a comment Improve this question Transcribed image text
Know the answer?
Add Answer to:
                           Barbara​ Gordon, the project manager for Web​ Ventures, compiled a table showing time estimate for each...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • Roger Ginde is developing a program in supply chain management certification for managers. Ginde has listed...

    Roger Ginde is developing a program in supply chain management certification for managers. Ginde has listed a number of activities that must be completed before a training program of this nature could be conducted. The activities, immediate predecessors, and times appear in the accompanying table: Activity Immediate Predecessor(s) Time (Days) A ------ 2 B ------ 5 C ------ 1 D B 10 E A,D 3 F C 6 G E,F 8 a) Develop an AON network for this problem. b)...

  • er Ginde is developing a program in supply chain management certification for managers. Ginde has listed...

    er Ginde is developing a program in supply chain management certification for managers. Ginde has listed a number of activities that must be completed before a training program of this nature could be ucted. The activities, immediate predecessors, and times appear in the accompanying table: Activity immediate Predecessor(s) Time (days) s exercise contains only parts b, c, and d. The critical activities for the leadership training program development project are The project length for the leadership training program development project...

  • 5.) Consider a project whose activities are listed in the table below. Activity A will have...

    5.) Consider a project whose activities are listed in the table below. Activity A will have slack time as long as…    Activity Immediate Predecessors A None B None C A D B E C, D F E G E a. Duration of A < Duration of B b. Duration of A + Duration of C > Duration of B + Duration of D c. Duration of A + Duration of C < Duration of B + Duration of D...

  • In the following table the activities with their precedence sequence and expected time (days) are listed...

    In the following table the activities with their precedence sequence and expected time (days) are listed for a project: Activity Immediate Predecessor(s) Time (days) - ITMO OWNono Ana E, F D GH a) The activities on the critical path are b) The project length is days. A-B-E-G-1 A-B-D-H-1 A-C-F-G-

  • project are listed for a In the following table the activities with their precedence sequence and...

    project are listed for a In the following table the activities with their precedence sequence and expected time (days) Immediate Predecessor(s) Time (days) Activity 7 A 2 A B 4 C 4 5 5 E C F 2 G E, F 3 H G, H a) The activities on the critical path are b) The project length is days.

  • A Question 11 The following table provides a list of activities in a project, along with...

    A Question 11 The following table provides a list of activities in a project, along with their respective durations and precedence requirements: Immediate Duration Activity Predecessor(s) (weeks) 2 B 3 C B D А E A.C 1 F DE 3 с 3 2 6 G Determine the amount of slack time for Activity E: a. O weeks b. 1 week C. 2 weeks O d. 3 weeks Question 12 Assume that activity A has the following times: Early start time...

  • In the following table the activities with their precedence sequence and expected time (days) are listed for a project Activity Immediate Predecessor(s) Time (days) E, F G, H The correct AOA preceden...

    In the following table the activities with their precedence sequence and expected time (days) are listed for a project Activity Immediate Predecessor(s) Time (days) E, F G, H The correct AOA precedence diagram is shown in Figure 1 Figure 2 Figure 3 Figure 1 Figure 2 Figure 3 In the following table the activities with their precedence sequence and expected time (days) are listed for a project Activity Immediate Predecessor(s) Time (days) E, F G, H The correct AOA precedence...

  • In the following table the activities with their precedence sequence and expected time​ (days) are listed...

    In the following table the activities with their precedence sequence and expected time​ (days) are listed for a project on which Carl​ Betterton's construction company is​ working:                                                                                        Activity Immediate​ Predecessor(s) Time​ (days) A minus− 5 B A 4 C A 6 D B 6 E B 4 F C 4 G D 6 H ​E, F 7 ​Carl's team should be able to complete the project in nothing days. Critical path activities for​ Carl's project are .

  • The following table provides a list of activities in a project, along with their respective durations...

    The following table provides a list of activities in a project, along with their respective durations and precedence requirements: Immediate Duration Activity Predecessor(s) (weeks) A 2 3 2 B с D E F 4 A B B с DE E 1 3 G 2 Determine the amount of slack time for Activity E Ola. O weeks b. 1 week c. 2 weeks d. 3 weeks

  • The table below shows a number of tasks required for the successful completion of a project....

    The table below shows a number of tasks required for the successful completion of a project. Activity Days Immediate Predecessor(s) A 4 B 2 A C 5 A D 7 A E 2 B F 5 B,C G 6 D,E,F Draw the network diagram for this project highlighting Early Start, Early Finish, Late Start and Late Finish and slack. Please show your answer by using the format shown below.                                                                                                                                  Table template: Activity A B C D E F G Early...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
