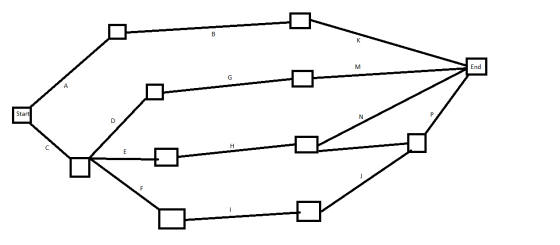

Activity |
Precedes |
Normal Duration (Weeks) |
CRASHING COSTS First Week |
CRASHING COSTS Second Week |
|
A |
---- |
12 |
15000 |
$20000 |
|
B |
A |
14 |
10000 |
10000 |
|
C |
---- |
10 |
5000 |
5000 |
|
D |
CC |
17 |
20000 |
21000 |
|
E |
CC |
18 |
16000 |
18000 |
|
F |
CC |
12 |
12000 |
15000 |
|
G |
D |
15 |
24000 |
24000 |
|
H |
E |
8 |
----- |
------ |
|
I |
F |
7 |
30000 |
---- |
|
J |
I |
12 |
25000 |
25000 |
|
K |
B |
9 |
10000 |
10000 |
|
M |
G |
3 |
---- |
---- |
|
N |
H |
11 |
40000 |
------- |
|
P |
H, J |
8 |
20000 |
20000 |
Assumptions:

Different paths and their duration is as below=
A-B-K=12+14+9=35
C-E-H-P=10+18+8+8=44
C-D-G-M=10+17+15+3=45
C-E-H-N=10+18+8+11=47
C-F-I-J-P=10+12+7+12+8=49
The below mentioned table has the details of crashing activities=
First of all we will crash activity C as it has least crashing cost
|
Path |
0 |
1 |
2 |
3 |
4 |
5 |
|
A-B-K |
35 |
|||||
|
C-E-H-P |
44 |
43 |
||||
|
C-D-G-M |
45 |
44 |
||||
|
C-E-H-N |
47 |
46 |
||||
|
C-F-I-J-P |
49 |
478 |
||||
|
Crashed activity |
C |
When it comes to second week, even then we will crash activity C due to least second week crash cost
|
Path |
0 |
1 |
2 |
3 |
4 |
5 |
|
A-B-K |
35 |
|||||
|
C-E-H-P |
44 |
43 |
42 |
|||
|
C-D-G-M |
45 |
44 |
43 |
|||
|
C-E-H-N |
47 |
46 |
45 |
|||
|
C-F-I-J-P |
49 |
48 |
47 |
|||
|
Crashed activity |
C |
C |
Now in the remaining activities, F has the second least first week crashing cost so we will not crash Activity F
|
Path |
0 |
1 |
2 |
3 |
4 |
5 |
|
A-B-K |
35 |
|||||
|
C-E-H-P |
44 |
43 |
42 |
41 |
||
|
C-D-G-M |
45 |
44 |
43 |
42 |
||
|
C-E-H-N |
47 |
46 |
45 |
44 |
||
|
C-F-I-J-P |
49 |
48 |
47 |
46 |
||
|
Crashed activity |
C |
C |
F |
Again we will crash Activity f due to least second week crash cost after C activity
|
Path |
0 |
1 |
2 |
3 |
4 |
5 |
|
A-B-K |
35 |
|||||
|
C-E-H-P |
44 |
43 |
42 |
42 |
42 |
|
|
C-D-G-M |
45 |
44 |
43 |
43 |
||
|
C-E-H-N |
47 |
46 |
45 |
45 |
45 |
|
|
C-F-I-J-P |
49 |
48 |
47 |
46 |
45 |
|
|
Crashed activity |
C |
C |
F |
F |
Final Table will be
|
Path |
0 |
1 |
2 |
3 |
4 |
5 |
|
A-B-K |
35 |
|||||
|
C-E-H-P |
44 |
43 |
42 |
42 |
42 |
40 |
|
C-D-G-M |
45 |
44 |
43 |
43 |
||
|
C-E-H-N |
47 |
46 |
45 |
45 |
45 |
44 |
|
C-F-I-J-P |
49 |
48 |
47 |
46 |
45 |
44 |
|
Crashed activity |
C |
C |
F |
F |
E,P |
Total cost of crashing= 5000+5000+12000+15000+3600=$73000
