Question

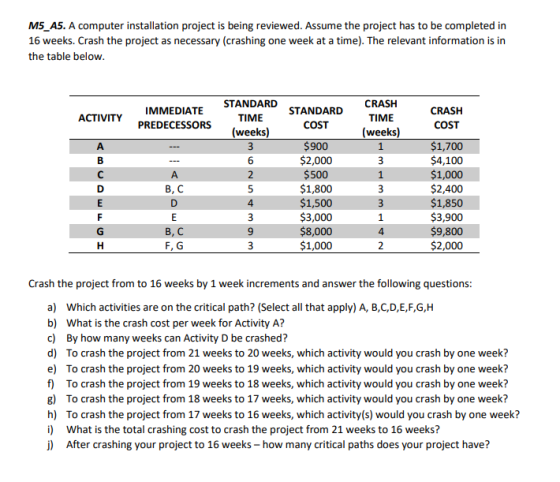

M5_A5. A computer installation project is being reviewed. Assume the project has to be completed in 16 weeks. Crash the projeI ONLY need help on letters G and I. According to the answers I've tried for these, it is NOT Activity G for the letter G and not $2,120 for letter I.

0 0
Add a comment Improve this question Transcribed image text
Answer #1

Solution: Givn data- action firct graph system outine depende nt pariority make ar on follows demonstsated ai Yelation ship aonolbu path A C G>H -A H 3+ t t 3= wceki weeks 6 93 au exerciseA th path 8-D-E - F-> H are. Comparina th critical path. on th2,HO0,800 600 D) 300 S 2 \,830- ,S0o 3so $35o - 3, 900 - Зо00 3 -1 9,800 360 , 00 q- H 1,OvD looo exercie A) is$ 400 for theweek ie Wscek to The project craining One exercise D ie, $300 weeks the e) project tom ao weekijol9 eeks TO Crash forming thewa the Smallest exereise D foom Crashed lt we So, i only 3 nseeks Thats Crash Co week. The lîmit i tor per COSH CrOLih crashis There tore craah cost $810 4D 360 - Crash the prdect tom tweeki fo crashing The to totau So, Add the COHS Crash values 300

Add a comment
Know the answer?
Add Answer to:
I ONLY need help on letters G and I. According to the answers I've tried for...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • I just need the last two parts of the question answered. PM.66 Real estate developer Russell Call was working with a fe...

    I just need the last two parts of the question answered. PM.66 Real estate developer Russell Call was working with a few contractors to make a number of improvements to one of his rental properties. After gathering information from these contractors he determined the following durations, predecessors, and costs of all the required activities Activity Normal Time (weeks) Crashed Time (weeks) Normal Cost Crashed Cost Predecessor(s) $1,050 $2,000 $2,560 $2,600 $1,300 $2,600 $2,200 $1,800 $2,400 4 $4,200 $5,540 $2,050 4...

  • Development of a new deluxe version of a particular toy is being considered by T-O-Y Inc....

    Development of a new deluxe version of a particular toy is being considered by T-O-Y Inc. The activities necessary for the completion of this project along with the relevant information for each activity are listed in the following table. The Total Crash Time represents the time for that activity after it has been crashed the maximum crash time allowed for that activity. For example, we can reduce the time for Activity A by one week to 3 weeks after crashing...

  • Kimpel Products makes pizza ovens for commercial use. James Kimpel, CEO, is contemplating producing smaller ovens...

    Kimpel Products makes pizza ovens for commercial use. James Kimpel, CEO, is contemplating producing smaller ovens for use in high school and college kitchens. The activities necessary to build an experimental model and related data are listed in the following table: Activity A Normal Time (weeks) 3 Crash Time (weeks) 2 B 2 1 1 Normal Cost $1,200 $2,000 $400 $1,500 $950 $4,500 $1,600 Total Cost with Immediate Crashing Predecessor(s) $1,800 $2,800 $400 $1,820 A $1,250 B $5,500 с $2,300...

  • Normal Time Crash Time Normal with Activity (weeks) (weeks) Cost Crashing Immediate Predecessor(s) $1,400 A 3...

    Normal Time Crash Time Normal with Activity (weeks) (weeks) Cost Crashing Immediate Predecessor(s) $1,400 A 3 2 $2,050 $2,800 B 2 1 $2,100 1 1 $350 $350 7 $1,400 $1,700 A 6 3 $900 $1,200 $5,000 $2,000 F 2 $4,000 $1,500 C 4 G 2 D, E weeks a) Based on the given information regarding the activities for the project, the project completion date b) To reduce the duration of the project to 10 weeks at the least cost, the...

  • Table of Crashing DecisionACTIVITYIMMEDIATE PREDECESSOR(S)NORMALCRASHNORMALCRASHA...323,000...

    Table of Crashing DecisionACTIVITYIMMEDIATE PREDECESSOR(S)NORMALCRASHNORMALCRASHA...323,0003,300B...648,0009,000CA114,0004,000      DA543,5004,000EB434,7505,500FC222,0002,000      GD114,0004,000HD,F323,5003,750IE,G323,0004,250JE215,0007,000Since no indirect cost nor penalty cost information is offered, please consider the schedule and crash cost issues only.1. Using Table of Crashing Decision, what is the earliest completion time of this project if normal times are used for all activities?A. fewer than 13 weeks; B. 13 weeks; C. 14 weeks; D. more than 14 weeks2. Using Table of Crashing Decision, what is the minimum time schedule for this project?A. fewer than 8 weeks; B. 8...

  • Lecture Exercise #13 Project Crashing Activity Predecessor(s) Time (weeks) Normal Crash 3 2 A None None...

    Lecture Exercise #13 Project Crashing Activity Predecessor(s) Time (weeks) Normal Crash 3 2 A None None None B Cost Normal Crash 1000 1600 2000 2700 300 300 1300 1600 2 1 С 1 1 D A 7 3 E 6 3 B с 1000 5000 F 2 850 4000 1500 NA G D. E 4 2000 What's the normal project completion time? Identify the critical path If you'd like to shorten the project by one week, which activity should you...

  • Kimpel Products makes pizza ovens for commercial use. James​ Kimpel, CEO, is contemplating producing smaller ovens...

    Kimpel Products makes pizza ovens for commercial use. James​ Kimpel, CEO, is contemplating producing smaller ovens for use in high school and college kitchens. The activities necessary to build an experimental model and related data are listed in the following​ table:                                                                                                                                   Activity Normal Time​(weeks) Crash Time​(weeks) Normal Cost Total Cost with Crashing    Immediate​ Predecessor(s) A 3 2 $ 1,200 $1,800 — B 2 1 $2,100 $2,900    __ C 1 1 $400 $400 — D 7 3 $1,300...

  • Lecture Exercise #13 Project Crashing Time (weeks) Cost Activity Predecessori s) Normal Crash Normal Crash A...

    Lecture Exercise #13 Project Crashing Time (weeks) Cost Activity Predecessori s) Normal Crash Normal Crash A None 3 2 1000 1600 B None 2 1 2000 2700 C None 1 1 300 300 D A 7 3 1300 1600 E B 6 3 850 1000 F с 2 1 4000 5000 D, E 2000 G 4 2 1500 What's the normal project completion time? Identify the critical path If you'd like to shorten the project by one week, which activity...

  • Development of Version 2.0 of a particular accounting software product is being considered by Jose Noquera's...

    Development of Version 2.0 of a particular accounting software product is being considered by Jose Noquera's technology firm in Baton Rouge. The activities necessary for the completion of this project are listed in the following table: To Cost Normal Time (weeks) Crash Time Normal with Activity (weeks) Cost Crashing Immediate Predecessor(s) $2.700 A $2,000 7 $2,300 S3,100 3 $500 $500 S2,300 $2,580 A E 5900 $1.275 F F $3.400 2 S4,800 C G $1,500 $2.100 D, E a) Based on...

  • PM.62 The US government has recently contracted with Boeing to build its fleet of airborne tankers....

    PM.62 The US government has recently contracted with Boeing to build its fleet of airborne tankers. The project has been laid out with durations (in weeks), predecessors, and costs included: Activity   Normal Time (weeks)   Crashed Time (weeks)   Normal Cost   Crashed Cost   Predecessor(s)   A 11 10 $1,500 $1,650 - B 7 5 $1,200 $2,490 - C 5 4 $900 $1,200 B D 4 2 $2,100 $3,000 A E 2 1 $550 $1,250 B F 4 3 $660 $1,050 E G 10...
