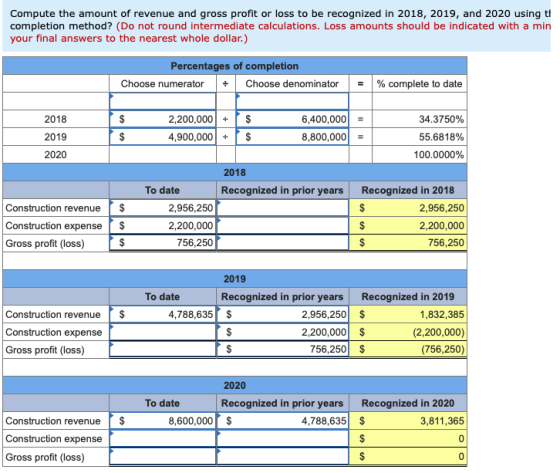

it says it's incomplete, please help
| On Feb 2018, Arrow construction company entered into a 3 year construction contract to build a bridge for $ 8600000 | |||||
| During 2018, the cost of $2200000 were incurred and billing of $2700000 was sent and cash collected was$2450000. | |||||
| Year | Numerator | / | Denominator | % of complete to date | |
| 2018 | 2200000 | 8600000 | 25.58 | ||
| 2019 | 7100000 | 8600000 | 82.56 | ||
| 2020 | 11100000 | 8600000 | 100.00 | (but limited to 100%) | |
| Numerator | |||||
| 2018 | Total Expenses incurred on the project | 2200000 | |||
| 2019 | Total Expenses incurred on the project | 4900000 | |||
| 2020 | Total Expenses incurred on the project | 4000000 | |||
| Gross Profit to be calculated = Percentage of work completed X Total Project value | |||||
| Percentage of work completed | X | Total Project value | Total Gross Profit | ||
| 2018 | 25.58 | X | 8600000 | 2200000 | |
| 2019 | 82.56 | X | 8600000 | 7100000 | |
| 2020 | 100.00 | X | 8600000 | 8600000 | |
| 2018 | |||||
| To date | Recognized in prior years | Recognized in 2018 | |||
| Contruction Revenue | 2200000 | 0 | 2200000 | ||
| Contruction Expense | 2200000 | 0 | 2200000 | ||
| Gross Profit | 0 | 0 | 0 | ||
| 2019 | |||||
| To date | Recognized in prior years | Recognized in 2019 | |||
| Contruction Revenue | 7100000 | 2200000 | 4900000 | ||
| Contruction Expense | 7100000 | 2200000 | 4900000 | ||
| Gross Profit | 0 | 0 | 0 | ||
| 2020 | |||||
| To date | Recognized in prior years | Recognized in 2020 | |||
| Contruction Revenue | 8600000 | 7100000 | 1500000 | ||
| Contruction Expense | 11100000 | 7100000 | 4000000 | ||
| Gross Profit(Loss) | -2500000 | 0 | -2500000 | ||
| 2a. | Journal entry for 2018 | ||||
| In the books of Arroe Contruction company | |||||
| for the year ended 31, December 2018 | |||||
| Date | Particulars | Amount$ | Amount$ | ||
| 31.12.2018 | Various Accounts A/c Dr | 2200000 | |||
| To Accounts Payable | 2200000 | ||||
| (being cost recorded) | |||||
| Accounts ReceivablesA/c Dr | 2700000 | ||||
| To Billing | 2700000 | ||||
| ( being billed amount recorded ) | |||||
| Cash A/c Dr | 2450000 | ||||
| To Accounts Receivables | 2450000 | ||||
| ( being cash collected) | |||||
| 2b. | Journal entry for 2019 | ||||
| In the books of Arroe Contruction company | |||||
| for the year ended 31, December 2019 | |||||
| Date | Particulars | Amount$ | Amount$ | ||
| 31.12.2019 | Various Accounts A/c Dr | 7100000 | |||
| To Accounts Payable | 7100000 | ||||
| (being cost recorded) | |||||
| Accounts ReceivablesA/c Dr | 2950000 | ||||
| To Billing | 2950000 | ||||
| ( being billed amount recorded ) | |||||
| Cash A/c Dr | 2675000 | ||||
| To Accounts Receivables | 2675000 | ||||
| ( being cash collected) | |||||
| 3a. | Balance Sheet for the year ended 31 December 2018 | ||||
| Particulars | Amount$ | Amount$ | |||
| Liabilities | |||||
| Accounts Payable | 2200000 | ||||
| Total Liabilities | 2200000 | ||||
| Assets | |||||
| Current Assets | |||||
| Accounts Receivables | 250000 | ||||
| Cash | 2450000 | ||||
| Total Assets | 2700000 | ||||
| 3b. | Balance Sheet for the year ended 31 December 2019 | ||||
| Particulars | Amount$ | Amount$ | |||
| Liabilities | |||||
| Accounts Payable | 7100000 | ||||
| Total Liabilities | 7100000 | ||||
| Assets | |||||
| Current Assets | |||||
| Accounts Receivables | 275000 | ||||
| Cash | 2675000 | ||||
| Total Assets | 2950000 | ||||
| Contract Cost | 8600000 | |||||
| Year | Cost | Cumulative cost | Cumulative % completion | Year on Year % | Cumulative revenue | YR on Yr revenue |
| 2018 | 2200000 | 2200000 | 25.58 | 25.58 | 2200000 | 2200000 |
| 2019 | 4900000 | 7100000 | 82.56 | 56.98 | 7100000 | 4900000 |
| 2020 | 4000000 | 11100000 | 100.00 | 17.44 | 8600000 | 1500000 |
| 11100000 | 100.00 | 8600000 |

it says it's incomplete, please help On February 1, 2018, Arrow Construction Company entered into a...
On February 1, 2018, Arrow Construction Company entered into a
three-year construction contract to build a bridge for a price of
$8,060,000. During 2018, costs of $2,020,000 were incurred with
estimated costs of $4,020,000 yet to be incurred. Billings of
$2,520,000 were sent, and cash collected was $2,270,000.
In 2019, costs incurred were $2,520,000 with remaining costs
estimated to be $3,630,000. 2019 billings were $2,770,000 and
$2,495,000 cash was collected. The project was completed in 2020
after additional costs of...
On February 1, 2018, Arrow Construction Company entered into a
three-year construction contract to build a bridge for a price of
$8,125,000. During 2018, costs of $2,050,000 were incurred, with
estimated costs of $4,050,000 yet to be incurred. Billings of
$2,560,000 were sent, and cash collected was $2,300,000. In 2019,
costs incurred were $2,560,000 with remaining costs estimated to be
$3,675,000. 2019 billings were $2,810,000, and $2,525,000 cash was
collected. The project was completed in 2020 after additional costs
of...
I am lost. This all that I have so far......
On February 1, 2018, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,060,000. During 2018, costs of $2,020,000 were incurred with estimated costs of $4,020,000 yet to be incurred. Billings of $2,520,000 were sent, and cash collected was $2,270,000. In 2019, costs incurred were $2,520,000 with remaining costs estimated to be $3,630,000. 2019 billings were $2,770,000 and $2,495,000 cash was collected....
On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,300,000. During 2021, costs of $2,100,000 were incurred with estimated costs of $4,100,000 yet to be incurred. Billings of $2,600,000 were sent, and cash collected was $2,350,000. In 2022, costs incurred were $2,600,000 with remaining costs estimated to be $3,750,000. 2022 billings were $2,850,000 and $2,575,000 cash was collected. The project was completed in 2023 after additional costs of...
On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,240,000. During 2021, costs of $2,080,000 were incurred with estimated costs of $4,080,000 yet to be incurred. Billings of $2,580,000 were sent, and cash collected was $2.330,000. In 2022, costs incurred were $2,580,000 with remaining costs estimated to be $3,720,000. 2022 billings were $2.830,000 and $2,555,000 cash was collected. The project was completed in 2023 after additional costs of...
3.
On February 1, 2018, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,300,000. During 2018, costs of $2,100,000 were incurred with estimated costs of $4,100,000 yet to be incurred. Billings of $2,600,000 were sent, and cash collected was $2,350,000. In 2019, costs incurred were $2,600,000 with remaining costs estimated to be $3,750,000. 2019 billings were $2,850,000 and $2,575,000 cash was collected. The project was completed in 2020 after additional costs...
On February 1, 2018, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,450,000. During 2018, costs of $2,180,000 were incurred, with estimated costs of $4,180,000 yet to be incurred. Billings of $2,716,000 were sent, and cash collected was $2,430,000. In 2019, costs incurred were $2,716,000 with remaining costs estimated to be $3,870,000. 2019 billings were $2,966,000, and $2,655,000 cash was collected. The project was completed in 2020 after additional costs of...
On February 1, 2018, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,000,000. During 2018, costs of $2,000,000 were incurred, with estimated costs of $4,000,000 yet to be incurred. Billings of $2,500,000 were sent, and cash collected was $2,250,000. In 2019, costs incurred were $2,500,000 with remaining costs estimated to be $3,600,000. 2019 billings were $2,750,000, and $2,475,000 cash was collected. The project was completed in 2020 after additional costs of...
please complete it in this format.
On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,030,000. During 2021, costs of $2,010,000 were incurred with estimated costs of $4,010,000 yet to be incurred. Billings of $2,510,000 were sent, and cash collected was $2,260,000. In 2022, costs incurred were $2,510,000 with remaining costs estimated to be $3,615,000. 2022 billings were $2,760,000 and $2,485,000 cash was collected. The project was completed...
On February 1, 2018, Arrow Construction Company entered into a
three-year construction contract to build a bridge for a price of
$8,125,000. During 2018, costs of $2,050,000 were incurred, with
estimated costs of $4,050,000 yet to be incurred. Billings of
$2,560,000 were sent, and cash collected was $2,300,000. In 2019,
costs incurred were $2,560,000 with remaining costs estimated to be
$3,675,000. 2019 billings were $2,810,000, and $2,525,000 cash was
collected. The project was completed in 2020 after additional costs
of...
