Question

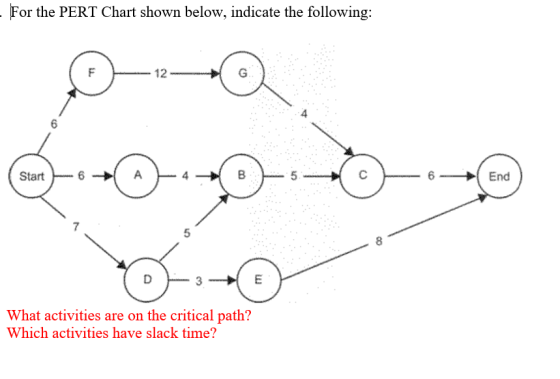

For the PERT Chart shown below, indicate the following:

- For the PERT Chart shown below, indicate the following: Start 6 End 0-0 D What activities are on the critical path? Which a

please provide the answers to the text in red

0 0
Add a comment Improve this question Transcribed image text
Answer #1

1st Ans: The critical path is the longest distance between the start and the finish of your project, including all the tasks, their duration, which gives you a clear picture of the project's actual schedule.

The activities F, G and C are on a critical path.

2nd Ans: Slack time can be defined as the amount of time an task can be delayed without causing another task to be delayed or impacting the completion date of your project.

The activity between F and G has slack time.
