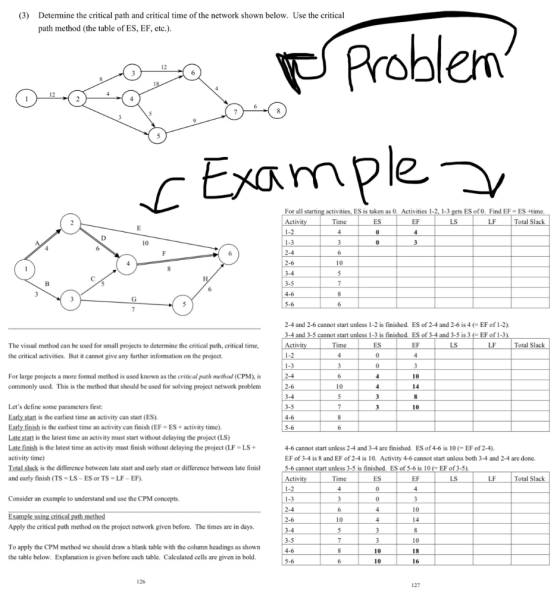

(3) Determine the critical path and critical time of the network
shown below. Use the critical path method (the table of ES, EF,
etc.).

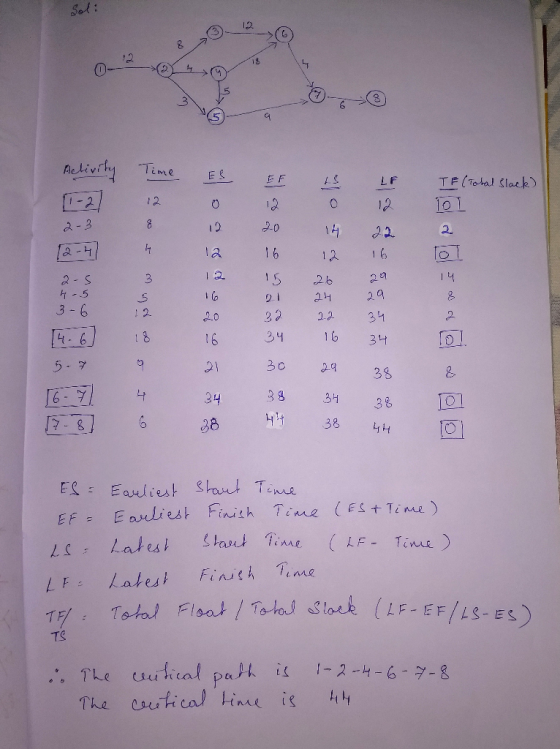

Sol:

(3) Determine the critical path and critical time of the network shown below. Use the critical...
QUESTION 2: (20 marks) 2. Critical Path Method (CPM) is a network diagramming technique used to predict total project duration and to determine the critical path. a) Based on the table provided, create the CPM network diagram. Analyse and show the Early Start (ES), Early Finish (EF), Late Start (LS), Late Finish (LF) and the Float/Slack duration. (14 marks) b) Analyse the diagram, state and circle the Critical Path clearly. (6 Marks) Activity Predecessor Duration A 6 B A 7...
QUESTION 2: (20 marks) 2. Critical Path Method (CPM) is a network diagramming technique used to predict total project duration and to determine the critical path. a) Based on the table provided, create the CPM network diagram. Analyse and show the Early Start (ES), Early Finish (EF), Late Start (LS), Late Finish (LF) and the Float/Slack duration (14 marks) b) Analyse the diagram, state and circle the Critical Path clearly. (6 Marks) Activity Predecessor Duration A 6 B А 7...
11. In CPM/PERT, an activity that is on the critical path A. has equal values for "Latest Start" and "Earliest Start" ( LS = ES ) B. has equal values for "Latest Finish" and "Earliest Finish" ( LF = EF ) C. is used in calculating total project duration D. has slack equal to zero E. all of the above 12. In CPM/PERT, the critical path through the network A. will require the most time of any path B. will...
The ABC Manufacturing Co. has made a decision to replace an existing production line with new equipment. This project will require several tasks (jobs) with precedence relationships and duration (days) as shown in the following table. The project will be finished when activities A-J are all finished. Activity predecessor Optimistic Most likely Pessimistic Expected A - 4 5 12 B A 3 4.5 15 C A 2 3 4 D C 6 8 22 E B 4 6 8 F...
For the following, draw the node network, perform the CPM
calculations, mark the critical Path, and complete the table.
IAAB 745 00 ABCDE Make possibility of rejection. Also show procurement activities CHAPTER 4 EXERCISES 1. For the following schedule, draw the node network, perform the CPM tions, mark the critical path, and complete the table. Activity Duration IPA ES EF LS LF TF FF В 8 B, C For the following schedule, draw the node network, perform the CPM tions,...
Consider a project having the following six activities: Immediate Max Crash cost Activity Predecessors Time (weeks) Crash* per week A none 6 6 N/A B none 5 2 $500 C A 3 2 $1000 D A, B 4 2 $2000 E C, D 5 2 $1250 F D 6 2 $1000 *Shortest possible time for the task 1. Draw the project network and list...
Consider the following project activities:
Calculate the expected time (te) for each
activity.
Draw an Activity on Node (AON) diagram to reflect the flow of
these activities.
Calculate the Early Start (ES), Early Finish (EF), Late Start
(LS), and Late Finish (LF) for each activity.
Calculate the slack for each activity.
Identify all activities on the Critical Path.
Use the data to calculate the probability the project will
finish in 20 weeks (Hint: z-score).
Activity A 8 с D E...
Consider a project having the following six activities: Immediate Max Crash cost Activity Predecessors Time (weeks) Crash* per week A none 7 7 N/A B none 3 2 $500 C A 5 3 $1000 D A, B 6 4 $2000 E C, D 4 3 $1250 F D 3 2 $1000 *Shortest possible time for the task 1. Draw the project network and list...
Must use AOA PERT/CPM
Manual Calculations and show Networks.
10. A farm owner is going to erect a maintenance building with a connecting electrical generator and water tank. The activities, activity descriptions, and estimated durations are given in the following table: Activity Activity Activity Activity Description Predecessor Time Excavate Erect building Install generator Install tank Install maintenance equipment Connect generator and tank to building b.c,d Paint finish Η Check out facility Construct the network for this project and calculate the...
also needs daves latest start and latest finish:
Dave Fletcher was able to determine the activity times for constructing his laser scanning machine. Fletcher would like to determine ES, EF, LS, LF, and slack for e activity. The total project completion time and the critical path should also be determined. Here are the activity times: Activity Time (weeks) Immediate Predecessor(s) Activity Time (weeks) Immediate Predecessor(s) C, E D, F Dave's earliest start (ES) and earliest finish (EF) are: Activity ES...
