Solution:
| Activity | Immediate Predecessors | Duration |
| A | - | 6 |
| B | A | 7 |
| C | A | 8 |
| D | B,C | 5 |
| E | C | 6 |
| F | D,E | 6 |
Edge and it's preceded and succeeded node
| Edge | Node1 → Node2 |
| A | 1→2 |
| B | 2→3 |
| C | 2→4 |
| D | 3→5 |
| d | 4→3 |
| E | 4→5 |
| F | 5→6 |

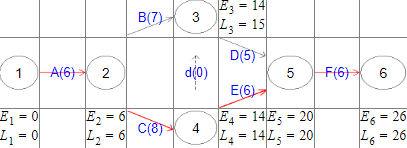

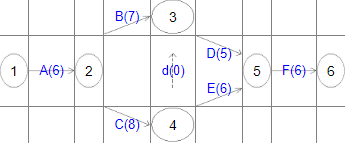

The network
diagram for the project, along with activity time, is

Forward
Pass Method
E1=0
E2=E1+t1,2
[t1,2=A=6]=0+6=6
E3=Max{Ei+ti,3}[i=2,4]
=Max{E2+t2,3;E4+t4,3}
=Max{6+7;14+0}
=Max{13;14}
=14
E4=E2+t2,4
[t2,4=C=8]=6+8=14
E5=Max{Ei+ti,5}[i=3,4]
=Max{E3+t3,5;E4+t4,5}
=Max{14+5;14+6}
=Max{19;20}
=20
E6=E5+t5,6
[t5,6=F=6]=20+6=26
Backward
Pass Method
L6=E6=26
L5=L6-t5,6
[t5,6=F=6]=26-6=20
L4=Min{Lj-t4,j}[j=5,3]
=Min{L5-t4,5;L3-t4,3}
=Min{20-6;15-0}
=Min{14;15}
=14
L3=L5-t3,5
[t3,5=D=5]=20-5=15
L2=Min{Lj-t2,j}[j=4,3]
=Min{L4-t2,4;L3-t2,3}
=Min{14-8;15-7}
=Min{6;8}
=6
L1=L2-t1,2
[t1,2=A=6]=6-6=0
The
critical path in the network diagram has been shown. This has been
done by double lines by joining all those events where E-values and
L-values are equal.
The
critical path of the project is : 1-2-4-5-6 and critical activities
are A,C,E,F
The
total project time is 26
The network
diagram for the project, along with E-values and L-values,
is

For each non-critical activity, the total float, free float and independent float calculations are shown in Table
Activity (i,j) (1) |
Duration (tij) (2) |
Earliest time Start (Ei) (3) |
(Ej) (4) |
(Li) (5) |
Latest time Finish (Lj) (6) |
Earliest time Finish (Ei+tij) (7)=(3)+(2) |
Latest time Start (Lj-tij) (8)=(6)-(2) |
Total Float (Lj-tij)-Ei (9)=(8)-(3) |
Free Float (Ej-Ei)-tij (10)=((4)-(3))-(2) |
Independent Float (Ej-Li)-tij (11)=((4)-(5))-(2) |
| 2-3 | 7 | 6 | 14 | 6 | 15 | 13 | 8 | 2 | 1 | 1 |
| 3-5 | 5 | 14 | 20 | 15 | 20 | 19 | 15 | 1 | 1 | 0 |
| 4-3 | 0 | 14 | 14 | 14 | 15 | 14 | 15 | 1 | 0 | 0 |
If you liked the answer please give an up-vote, it will be quite encouraging to me. Thank you and have a nice day!!!
