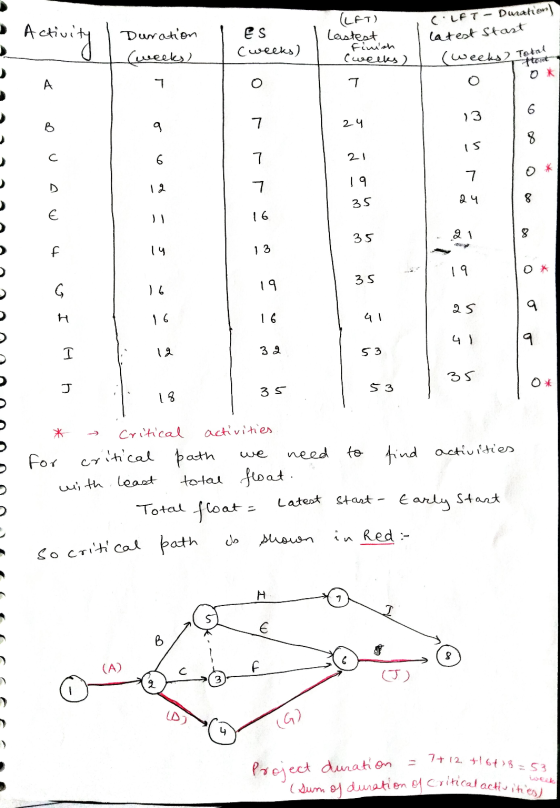

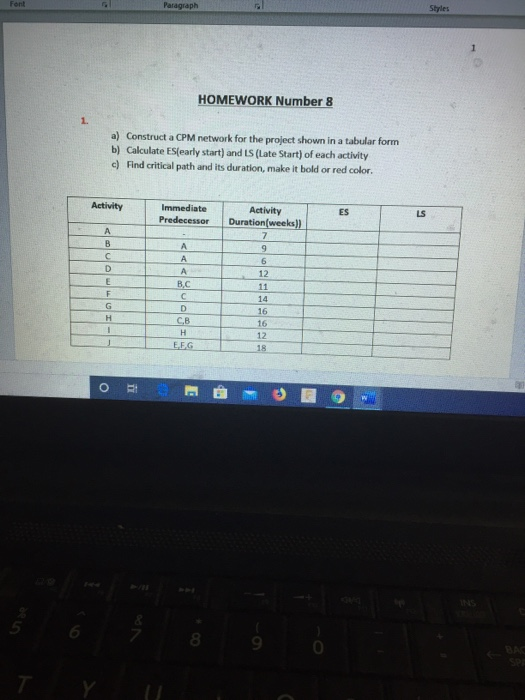

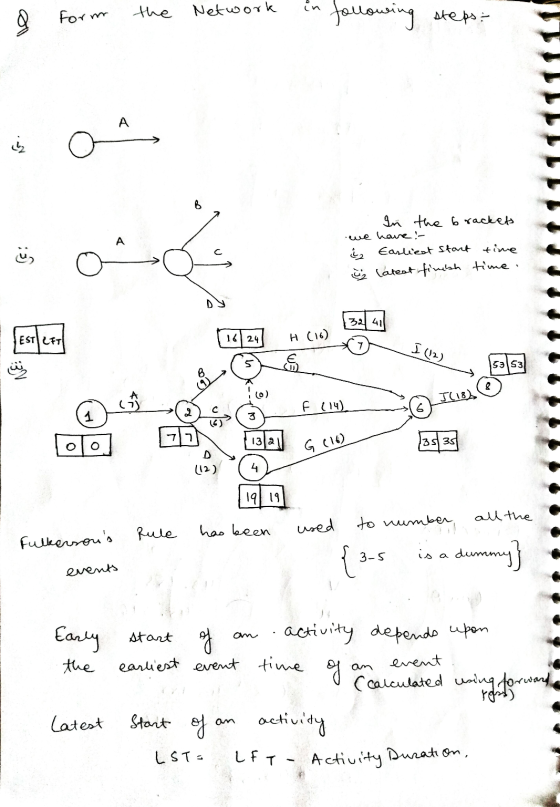

Paragraph HOMEWORK Number 8 a) Construct a CPM network for the project shown in a tabular...
QUESTION 2: (20 marks) 2. Critical Path Method (CPM) is a network diagramming technique used to predict total project duration and to determine the critical path. a) Based on the table provided, create the CPM network diagram. Analyse and show the Early Start (ES), Early Finish (EF), Late Start (LS), Late Finish (LF) and the Float/Slack duration (14 marks) b) Analyse the diagram, state and circle the Critical Path clearly. (6 Marks) Activity Predecessor Duration A 6 B А 7...
QUESTION 2: (20 marks) 2. Critical Path Method (CPM) is a network diagramming technique used to predict total project duration and to determine the critical path. a) Based on the table provided, create the CPM network diagram. Analyse and show the Early Start (ES), Early Finish (EF), Late Start (LS), Late Finish (LF) and the Float/Slack duration. (14 marks) b) Analyse the diagram, state and circle the Critical Path clearly. (6 Marks) Activity Predecessor Duration A 6 B A 7...
A simple CPM network has three activities, A, B, and C. A is an immediate predecessor of B and of C. B is an immediate predecessor of C. The activity durations are A=4, B=3, C=5. The network has no critical path. The critical path cannot be determined without knowing PERT expected activity times. The critical path is A-C, duration 10.5. The critical path is A-B-C, duration 9. The critical path is A-B-C, duration 12.
1. For the following schedule, Draw the AON network diagram for the project and calculate the schedule. а. Summarize the schedule in a tabular form, showing ES, EF, LS, LF, TF, and FF for each activity b. Denote the critical path on the network. C. d. Perform a cost analysis based on an early start, late start, and target schedule for the project. Plot the cumulative cost distribution for the three S-curves on one graph. e. f. Plot the cumulative...
QUESTION 1 Please use the information below to draw and solve the network on a piece of paper by: Complete the forward and backward pass Identify the critical path Fill in the requested information (Example: ESA Early Start of Activity A; LFA Late Finish of Activity A, etc) Relationship Activity Contract sign Predecessor Activity ID Duration 3 А Survey В 2 А Target market C Data В,С D 7 collection Presentation 2 FS Lag 3 E В Analyze F 2...
For the following, draw the node network, perform the CPM
calculations, mark the critical Path, and complete the table.
IAAB 745 00 ABCDE Make possibility of rejection. Also show procurement activities CHAPTER 4 EXERCISES 1. For the following schedule, draw the node network, perform the CPM tions, mark the critical path, and complete the table. Activity Duration IPA ES EF LS LF TF FF В 8 B, C For the following schedule, draw the node network, perform the CPM tions,...
A project manager discovers that his team has neglected to
complete the network diagram for the project. the network diagram
is shown below. however the project manager has some information
available, specifically that each activity a-g, has a different
duration between one and seven weeks. also the slack time for each
of the activity is known as shown belowDuration (weeks): 1,2,3,4,5,6,7 Slack time (weeks): 0,0,0,1,1,3,7 A D E G B FINISH START C F Using the clues provided below, determine...
21. Using the CPM method, calculate early start (ES), late start (LS), early finish (EF), late finish (LF) and total float (TF) for each activity in the following network and answer the questions 21-1. The ES of activity His: a) 18 b) 22C) 5 d) 2 21-2. The LF of activity B is: a) 20 b) 22c) 18d) 19 ) 13 d) 59 21-3. The TF of activity A is: a) 5 b ) 17 c) 18 21-4. The project...
(3) Determine the critical path and critical time of the network
shown below. Use the critical path method (the table of ES, EF,
etc.).
(3) Determine the critical path and critical time of the network shown below. Use the critical path method (the table of ES, EF, etc.). po Problem . Example a 100 For all starting activities, ES is taken as 0. Activities 1-2, 1-3 gets ES of O. Find EF-ES +time. Activity Time ES E F LS L...
Consider the following project activities:
Calculate the expected time (te) for each
activity.
Draw an Activity on Node (AON) diagram to reflect the flow of
these activities.
Calculate the Early Start (ES), Early Finish (EF), Late Start
(LS), and Late Finish (LF) for each activity.
Calculate the slack for each activity.
Identify all activities on the Critical Path.
Use the data to calculate the probability the project will
finish in 20 weeks (Hint: z-score).
Activity A 8 с D E...
