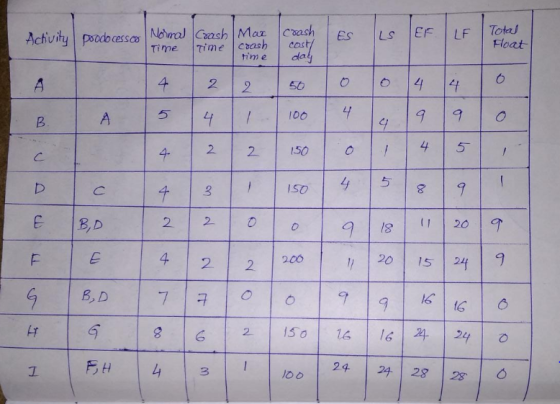

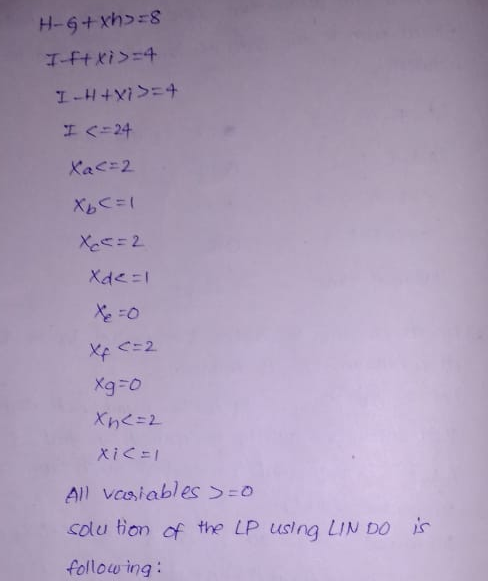

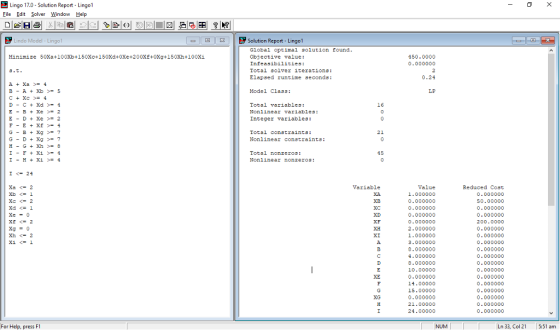

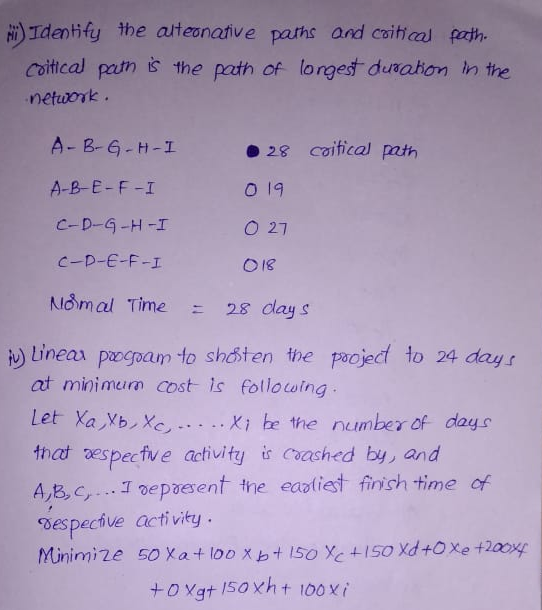

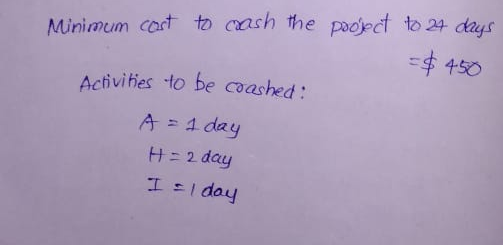

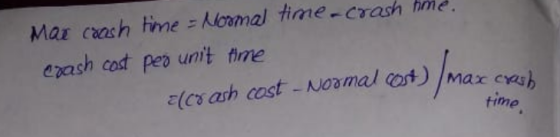

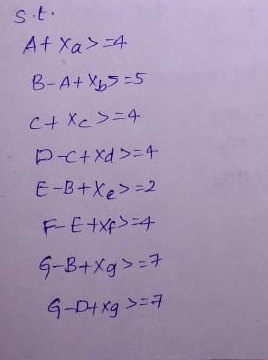

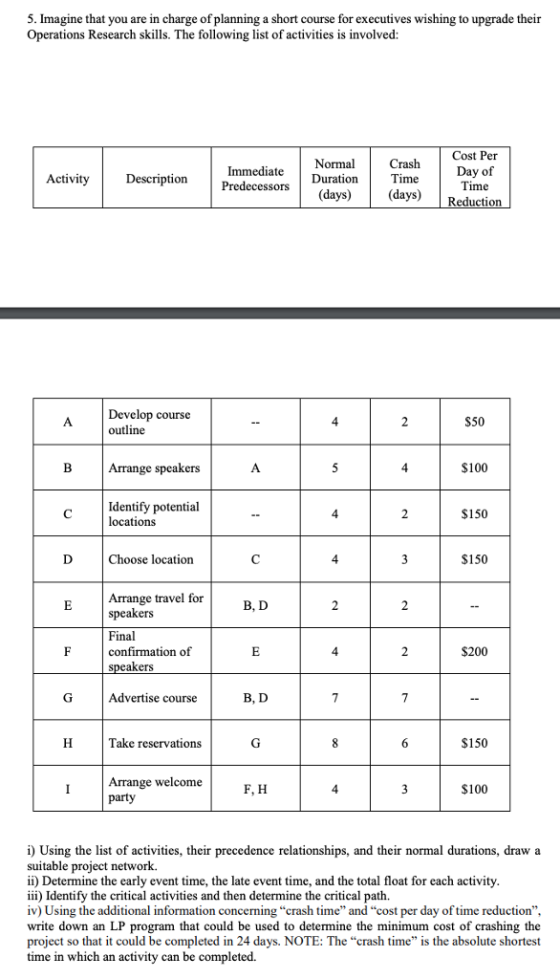

5. Imagine that you are in charge of planning a short course for executives wishing to...
Given below is the crashing data for a project along with other data. The project completion time is 20 davs. Determine: (a) the crash slope (i.e crash cost/day) for all activities, (b) the normal total project cost, (c) prioritized the list of activities for crashing from best to worst, (d) the best activity to crash if the project has to be completed in 19 days and alternative critical paths, if any, (e) the earliest time the project can be completed,...
1. When finding the approximate probability of project duration, it is necessary to know which of following? a. The mean and variance of each activity b. The mean of each activity on the CP c. The sd of only the activities on the CP d. Each activity's probability of completion e. The distribution of activity times 2. The sd of a path is computed as: a. the sum of the sd of all activities on the path b. the square...
6. A project has been defined to contain the following list of activities, along with their precedence relations and time and cost estimates for the activity durations. Time estimates (weeks L Cost estimates ($) Activity Predecessor(s) Normal time Crashed time Normal cost Crashed cost 10 9 $6000 $8000 - 85 $1100 $2000 A 7 5 $3000 $3800 B 12 4 $4000 $6000 B 4 2 $5000 $6500 AD 6 3 $2500 $4000 CE $2800 $$3000 a. Draw the Activity-on-node (AON)...
18. Office Automation, Inc., developed a proposal for introducing a new computerized office system that will standardize the electronic archiving of invoices for a particular company. Contained in the proposal is a list of activities that must be accomplished to complete the new office system project. Use the following relevant information about the activities Crash Cost ($1000s) Activity Description Immediate NormalCrash Normal Predecessor Time TimeCost (weeks) (weeks ($1000s) 10 70 150 160 50 75 Plan needs Order equipment Install equipment...
If you would like to reduce the overall completion time of the
project by 1 day, which activity (A, B, C, D, E, F, G, or H) should
be crashed?
The list of activities of a data analysis project, their precedence relationships, and their activity times (in number of days) are given in the table below. Activity ID Predecessors Activity Time (Days) A 3 B А 4 с B 2 D с 5 E B 7 F с 2 G...
Question 16 4 points Save Answe The following provides information about a project, including a list of activities and precedence relationships, activity durations (normal and "crash" times), direct activity costs (normal and "crash"), indirect costs for the project, as well as calculated crash costs/day and the maximum amount that each activity can be shortened (crashed) by. There are no penalty costs for this project. Total project cost (using normal times), a network diagram, and the four paths and durations have...
hi need answers for this urgently thanks

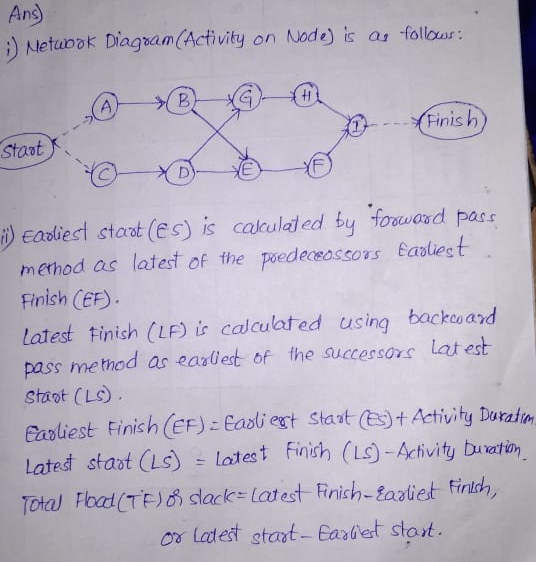

Question 2 (20 Marks) a) Given the following project details, identify the project's critical path; Activity Predecessor A B Duration (Man Days) 5 10 12 8 6 15 D Ε F B, C GE CD G H 20 18 30 5 I,J к F, L M (10 Marks) Continued... b) Given the information below, identify how much it would cost for each day you crash the schedule. Determine the total cost for crashing...
5.) Consider a project whose activities are listed in the table below. Activity A will have slack time as long as… Activity Immediate Predecessors A None B None C A D B E C, D F E G E a. Duration of A < Duration of B b. Duration of A + Duration of C > Duration of B + Duration of D c. Duration of A + Duration of C < Duration of B + Duration of D...
Office Automation Inc., has developed a proposal for introducing a new computerized office system that will improve word processing and interoffice communications for a particular company. Contained in the proposal is a list of activities that must be accomplished in order to complete the new office system project. Information about the activities is shown in the table below. Times are in weeks. Data for Office Automation, Inc. Activity Description Immediate Predecessors Normal Time Crash Time Normal Cost ($) Crash Cost...
A Question 11 The following table provides a list of activities in a project, along with their respective durations and precedence requirements: Immediate Duration Activity Predecessor(s) (weeks) 2 B 3 C B D А E A.C 1 F DE 3 с 3 2 6 G Determine the amount of slack time for Activity E: a. O weeks b. 1 week C. 2 weeks O d. 3 weeks Question 12 Assume that activity A has the following times: Early start time...
