Correct option is "B"-625000
| Year 1 | 2 | 3 | |
| Cost incurred Till date | 1000 | 1000(till year 1 )+1500=2500 | 2500 (till year 2) +1250=3750 |
| Estimated cost to complete | 3000 | 1500 | 0 |
| Total cost of contract | 4000 | 4000 | 3750 |
| % of completion [cost incurred till date /Total cost ] |
1000/4000 25% |
2500/4000 62.5% |
3750/3750 100% |
| Year 1 | 2 | 3 | |
| Contract price | 5000 | 5000 | 5000 |
| Less:Total cost | (4000) | (4000) | (3750) |
| Gross profit | 1000 | 1000 | 1250 |
| % of completion | 25% | 62.5% | 100% |
| Gross profit to be recognized till date | 1000*25%=250 | 1000*62.5%=625 | 1250*100%=1250 |
| Less:Gross profit recognized till prior year | 0 | -250 | -625 |
| Gross profit to be recognized in current period | 250 | 375 | 625 |

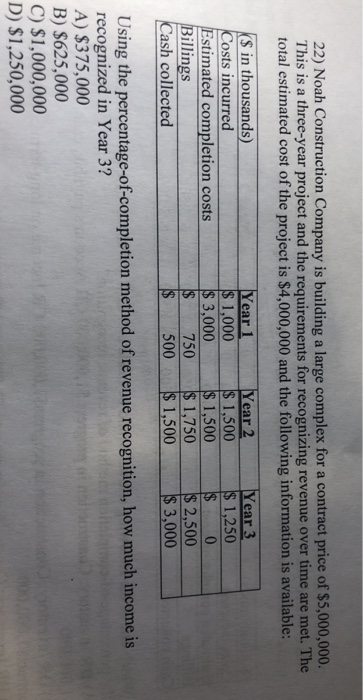

22) Noah Construction Company is building a large complex for a contract price of $5,000,000 This...
23) A right of return exists when: A) the customer is entitled to a full or partial refund. B) the customer is entitled to a credit against amounts owed. C) the customer is entitled to another product in exchange. D) any one of these conditions is met. 19) Noah Construction Company is building a large complex for a contract price of $5,000,000. This is a three-year project and the requirements for recognizing revenue over time are met. The total estimated...
Brady Construction Company contracted to build an apartment
complex for a price of $5,000,000. Construction began in 2021 and
was completed in 2023. The following is a series of independent
situations, numbered 1 through 6, involving differing costs for the
project. All costs are stated in thousands of dollars.
Estimated Costs to Complete
Costs Incurred During Year
(As of the End of the Year)
Situation
2021
2022
2023
2021
2022
2023
1
1,500
2,100
900
3,000
900
—
2
1,500...
King Corporation started the construction of a building during 2017 at a contract price of $5,000,000. The contract to build was non-cancellable and they managed to complete the project in 2019 as anticipated. Billings are nonrefundable and under the terms of the project, King sends billings to the vendor as revenues are earned. The following additional information is available: 2017 2018 2019 Costs to-date $ 800,000 $2,500,000 $4,800,000 Estimated costs to complete $2,400,000 $2,500,000 $0 Required: a. Calculate the amount...
Brady Construction Company contracted to build an apartment complex for a price of $5,000,000. Construction began in 2013 and was completed in 2015. The following are a series of independent situations, numbered 1 through 6, involving differing costs for the project. All costs are stated in thousands of dollars Costs Incurred During Year Situation 2013 2014 2015 1 1,500 2,100 900 3,000 900 %u2014 2 1,500 900 2,400 3,000 2,400 %u2014 3 1,500 2,100 1,600 3,000 1,500 %u2014 4 500...
2. Brady Construction Company contracted to build an apartment complex for a price of $5,000,000. Construction began in 2021 and was completed in 2023. The following is a series of independent situations, numbered 1 through 6, involving differing costs for the project. All costs are stated in thousands of dollars. Situation о» от дома Costs Incurred During Year 2021 2022 2023 1,500 2,100 900 1,500 900 2,400 1,500 2,100 1,600 500 3,000 1,000 500 3,000 1,300 500 3,000 1,800 Estimated...
Fender period. Construction Company receives a contract to construct a building over a 3 year Information relating to the performance of the contract is summarized as follows: 2015 2016 2017 S 16,000,000 Cumulative construction costs incurred to date Estimated costs to complete Billings during the year Cash collected during the year 6,000,000 8,000,000 6,000,000 3,000,000 8,000,000 7,000,000 4,000,000 5,000,000 Required: 1. How much is Fender Construction charging to build this athletic stadium? In other words, what is the contract price...
Curtiss Construction Company, Inc., entered into a fixed-price contract with Axelrod Associates on July 1, 2021, to construct a four-story office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,960,000. The building was completed on December 31, 2023. Estimated percentage of completion, accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings to Axelrod under the...
Exercise 6-23 (Static) Income (loss) recognition; Long-term
contract; revenue recognition over time vs. upon project completion
[LO6-9] Brady Construction Company contracted to build an apartment
complex for a price of $5,000,000. Construction began in 2021 and
was completed in 2023. The following is a series of independent
situations, numbered 1 through 6, involving differing costs for the
project. All costs are stated in thousands of dollars.
Situation 1 2 3 4 Costs Incurred During Year 2021 2022 2023 1,500 2,100...
Check my work 10 Curtiss Construction Company, Inc., entered into a fixed-price contract with Axelrod Associates on July 1, 2021, to construct a four-story office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,000,000. The building was completed on December 31, 2023. Estimated percentage of completion, accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings...
McCombs Contractors received a contract to construct a mental health facility for $2,500. Construction was begun in 2023 and completed in 2024. Cost and other data are presented below: 2024 $1,300 Costs incurred during the year Estimated costs to complete Billings during the year Cash collections during the year 2023 $1,500 1,200 1,200 1,000 1,300 1,500 1. Compute the amount of revenue and gross profit recognized during 2023 and 2024. 2. Assume that McCombs recognizes revenue on this contract over...
