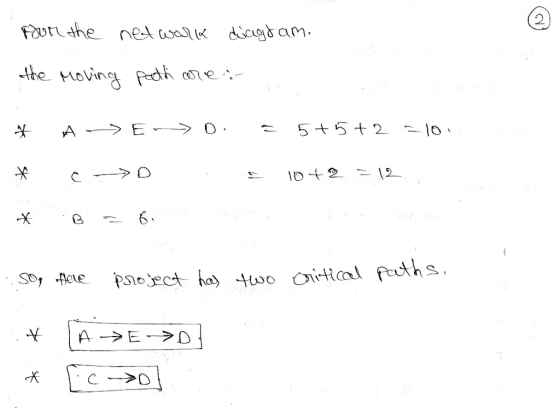

Consider the project network information in Table 1 of Case Study A on Page 3 below....

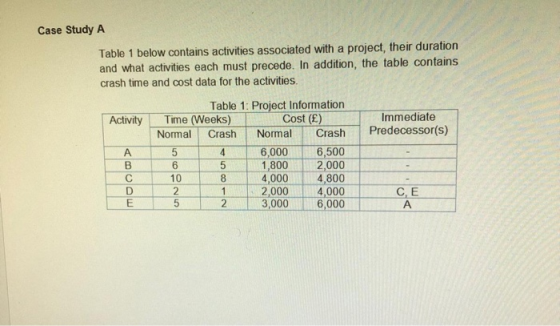

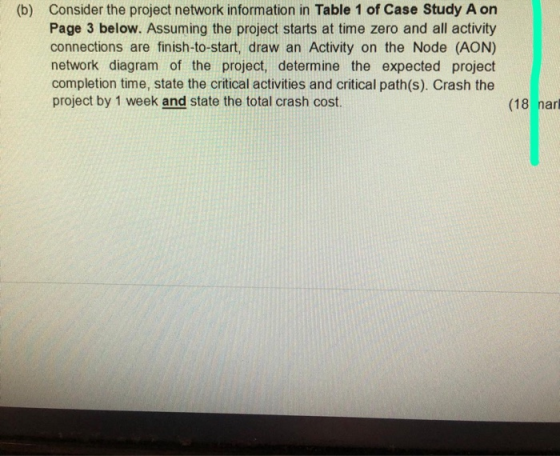

Consider the project network information in Table 1 of Case Study A on Page 3 below. Assuming the project starts at time zero and all activity connections are finish-to-start, draw an Activity on the Node (AON) network diagram of the project, determine the expected project completion time, state the critical activities and critical path(s). Crash the project by 1 week and state the total crash cost. (b) (18 narl Case Study A Table 1 below contains activities associated with a...
Question 2. (30%) The following table provides the information necessary to construct project network and calculate a total project cost. In case of activity crash, the information includes crash cost for each activity. Activity Immediate predecessor(s) Activity time (weeks) Normal cost (x1000$) Additional cost for crashing one week (x1000$) Normal After maximum crash A - 16 12 2,000 300 B - 14 9 1,000 160 C A 8 6 500 100 D A 5 4 600 700 E B 4...
Table 2 contains information about an environmental cleanup project in the township of Hiles. Shorten the project 3 weeks by finding the minimum-cost schedule. Assume that project indirect costs and penalty costs are negligible. Identify activities to crash while minimizing the additional crash costs. What is the project’s duration if only normal times are used? What is the minimum-cost schedule? What is the critical path for the minimum-cost schedule? TABLE 2 Activity Normal Time (wks) Crash Time (wks) Cost to...
The table below defines the activities and the normal time duration for each activities within a small project. You can decrease (crash) the durations at an additional expense. Table 1 summarizes the time-cost information for the activities to complete the project. Table 1: The time-cost information for the activities Activity Normal Completion Time (weeks) Immediate Predecessor Crash Time (weeks) Normal cost for activities Crash cost for activities/week A 2 - 1 1200 400 B 3 - 1 1400 500 C...
9. Consider a project having the following ten activities sh Maximum Cost Normal Norma Crash Cra Time Immediate Weeks Cost Time Activity Predecessors (weeks (S) (weeks(SL Reduced none 3,000 9,000 3,000 3,000 6,000 9,000 3,000 7,000 4,000 6 6,000 8 5,000 2 2,000 4 3,000 B, C 4,000 C, D 6 4,000 2 3.000 E, F 4,000 1 4,000 H, I 8 2,000 7,000 (a) What is the expected project completion time? b) What is the critical path? (c) What...
You are the manager of a project to improve a billing process at your firm. The table below contains the data you will need to conduct a cost analysis of the project Indirect costs are $1,600 per week, and penalty costs are $600 per week after week 12 Immediate Normal Cost Crash Cost Predecessor(s) Normal Time (weeks) Crash Time (weeks) ($) ($) Activity A 4 5,500 7,500 В 5 3 8,000 9,500 A 1 1 3,500 3,500 В 6 3...
5. (4 points) The Figure shows the project network with normal durations of the activities (in weeks). The following table shows the normal durations, shortest possible durations, achieved at extra cost, & the acceleration cost per time unit. Activity Immediate predecessor(s) Normal duration Shortest possible duration Unit cost of acceleration ($ in Thousands) 40 C 5 4 50 80 DA 5 1 50 (6,5, 40) (5, 4, 50) Start End D (5, 1, 50) (4, 3, 80) Develop all possible...
Question 8-10, CHAPTER 18: A home-remodeling project consists of eight activities. The immediate predecessors and activity times in weeks are shown below. Activity Predecessor(s) Normal Time Crash Time Normal Cost $400 Crash Cost $700 1600 2000 800 1100 1000 NNW 600 1200 1450 800 800 500 650 400 600 900 1300 F G H1 1000 650 8. Draw the network for this project. (10 points) 9. Please indicate the Earliest Start, Earliest Finish, Latest Start, and Latest Finish on the...
Given below is the crashing data for a project along with other data. The project completion time is 20 davs. Determine: (a) the crash slope (i.e crash cost/day) for all activities, (b) the normal total project cost, (c) prioritized the list of activities for crashing from best to worst, (d) the best activity to crash if the project has to be completed in 19 days and alternative critical paths, if any, (e) the earliest time the project can be completed,...
TYPE: A CRAMOCerat Managmenti Sume 20t9 2 JCh. 3. Project Management] Jacksonville Bike Shop is behind on a custom bike and needs to crash 1 day of time from the 6-step project. Given the project table below answer the following questions. Suppose this shop calls the customer and asks for a project extension, reducing the amount of time she/he nceds to crash. [Note: The project can be speeded up (or "crashed") by spending For example, activity A currently takes 10...
