Question

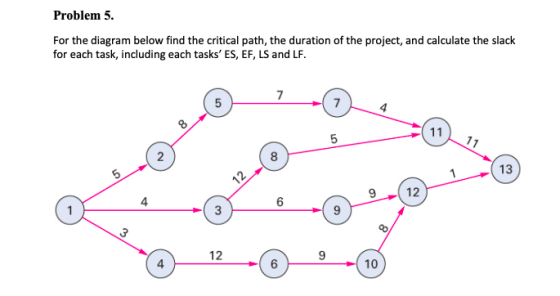

Problem 5. For the diagram below find the critical path, the duration of the project, and calculate the slack for each task,

0 0
Add a comment Improve this question Transcribed image text
Answer #1

13 12 12 Paths 1-2-5-7-11-13 1-3-8-11-13 1-3-9-12-13 1-4-6-10-12-13 Duration 35 32 20 the critical path is the path with the

Add a comment
Know the answer?
Add Answer to:
Problem 5. For the diagram below find the critical path, the duration of the project, and...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • (3) Determine the critical path and critical time of the network shown below. Use the critical...

    (3) Determine the critical path and critical time of the network shown below. Use the critical path method (the table of ES, EF, etc.). (3) Determine the critical path and critical time of the network shown below. Use the critical path method (the table of ES, EF, etc.). po Problem . Example a 100 For all starting activities, ES is taken as 0. Activities 1-2, 1-3 gets ES of O. Find EF-ES +time. Activity Time ES E F LS L...

  • Problem #2 (25 points) For the project below, choose a random duration for each activity (Activity...

    Problem #2 (25 points) For the project below, choose a random duration for each activity (Activity A already has a duration of 3). Calculate the ES, EF, LS, LF, TF and FF for all activities. Use the legend shown below for each activity and highlight the critical path. Fill the answers in the activity's boxes shown below. F с E H A 3 D G Legend: ES TF EF FF Activity LS Duration LF

  • DSIM 350: Managing Product and Service Operations Final Exam - Total Points (100) Problem 2: Ch...

    DSIM 350: Managing Product and Service Operations Final Exam - Total Points (100) Problem 2: Ch 9 Project Management (50 Points) Following table gives the details about all tasks needed to be completed for a pro their respective predecessors and task times (weeks). ject along with 1. Activity Activity predecessor Time (Weeks) b, c 7 6 4 a. Draw the network diagram b. Calculate ES-EF-LF-LS times and determine the slack for each activity. Show all calculations on the diagram. Establish...

  • B. Resource Loading (33 pts). The network diagram below represents a project plan. a. b. C....

    B. Resource Loading (33 pts). The network diagram below represents a project plan. a. b. C. Compute the early, late, and slack times. Include your diagram in your paper What is the project duration? What is the critical path -illustrate it on your diagram (such as a dotted line). Ch 8 Assignment Resources: P(ainter); T(rimmer) 0 A START P & T ES ID EF SL Resour LS Dur LF 2 As your text stated, a plan isn't a schedule until...

  • Consider a project having the following six activities:

    Consider a project having the following six activities:                                                      Immediate                                                  Max        Crash cost             Activity                           Predecessors           Time (weeks)             Crash*    per week                   A                                none                                    6                          6                N/A                   B                                none                                    5                          2               $500                   C                                A                                       3                          2             $1000                   D                                A, B                                    4                          2             $2000                   E                                 C, D                                    5                          2             $1250                   F                                D                                       6                          2             $1000                                                                                                 *Shortest possible time for the task 1. Draw the project network and list...

  • QUESTION 2: (20 marks) 2. Critical Path Method (CPM) is a network diagramming technique used to...

    QUESTION 2: (20 marks) 2. Critical Path Method (CPM) is a network diagramming technique used to predict total project duration and to determine the critical path. a) Based on the table provided, create the CPM network diagram. Analyse and show the Early Start (ES), Early Finish (EF), Late Start (LS), Late Finish (LF) and the Float/Slack duration. (14 marks) b) Analyse the diagram, state and circle the Critical Path clearly. (6 Marks) Activity Predecessor Duration A 6 B A 7...

  • Consider a project having the following six activities:

    Consider a project having the following six activities:                                                      Immediate                                                  Max            Crash cost             Activity                           Predecessors          Time (weeks)             Crash*    per week                   A                                none                                    7                          7         N/A                   B                                none                                    3                          2        $500                   C                                A                                       5                          3      $1000                   D                                A, B                                    6                          4      $2000                   E                                 C, D                                    4                          3      $1250                   F                                D                                       3                          2      $1000                                                                                                 *Shortest possible time for the task 1. Draw the project network and list...

  • for each problem I have this setup so far. I need help on each part and im not too sure if I am on the right track for each question on the picture. this chapter is on project management for statisti...

    for each problem I have this setup so far. I need help on each part and im not too sure if I am on the right track for each question on the picture. this chapter is on project management for statistics 1. A project is shown by the following network. The durations of activities (in weeks) are indicated on the arrows. a. Identify all of the paths, compute the length of each, identify the critical path and the b. Determine...

  • : A network consists of the following list. Times are given in weeks. Activity Preceding Duration...

    : A network consists of the following list. Times are given in weeks. Activity Preceding Duration A -- 9 B A 2 C A 12 D A 5 E B 6 F B 8 G C, F 3 H D 2 I H 8 J G, I 6 K E, J 2 Draw the network diagram. Find ES, EF, LS, LF, and the slack times for each of the activities. Which activities are critical? Determine the critical path(s). What is...

  • Consider the following project where times are in weeks. Activity Duration Immediate Predecessors A B с...

    Consider the following project where times are in weeks. Activity Duration Immediate Predecessors A B с D E F G H A.B B A с E,F 8 12 7 4 2 3 7 3 DF a) Determine the activity schedule (ES, EF, LS, and LF) as well as slack using the information from the table above (11 marks) b) Determine all the possible paths of this project and determine the shortest possible time this project can be completed? (4 marks)...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
