Network Diagram - Critical Path Method: in Hand written Format

|
From the Network Diagram, It is clear that Critical Path is ADEH, as activities on that critical path have zero float, Further, Project needs at least 11 days time to finish as Critical path duration is 11 Days, which is here Maximum time, the critical Path is shown with Bold Arrow |
| Activity | Duration | Early Start | Late Start | Early Finish | Late Finish | Slack or Float Time = Late start - Early Start = Late Finish - Early Finish | Critical path activities Yes or No |
| A | 3 | 0 | 0 | 3 | 3 | 0 | Yes |
| B | 2 | 0 | 1 | 2 | 3 | 1 | No |
| C | 2 | 0 | 4 | 2 | 6 | 4 | No |
| D | 2 | 3 | 3 | 5 | 5 | 0 | Yes |
| E | 4 | 5 | 5 | 9 | 9 | 0 | Yes |
| F | 6 | 2 | 3 | 8 | 9 | 1 | No |
| G | 3 | 2 | 6 | 5 | 9 | 4 | No |
| H | 2 | 9 | 9 | 11 | 11 | 0 | Yes |
| Resource Loading | ||||||||||||||||
| Activity | Duration | Resource | 1 | 2 | 3 | 4 | 5 | 6 | 7 | 8 | 9 | 10 | 11 | |||
| A | 3 | Painter | 1 | 1 | 1 | |||||||||||
| B | 2 | Painter | 1 | 1 | ||||||||||||
| C | 2 | Trimmer | 1 | 1 | ||||||||||||
| D | 2 | Painter | 1 | 1 | ||||||||||||
| E | 4 | Trimmer | 1 | 1 | 1 | 1 | ||||||||||
| F | 6 | Trimmer | 1 | 1 | 1 | 1 | 1 | 1 | ||||||||
| G | 3 | Painter | 1 | 1 | 1 | |||||||||||
| H | 2 | Painter plus Trimmer | 2 | 2 | ||||||||||||
| Total | 3 | 3 | 3 | 3 | 3 | 2 | 2 | 2 | 1 | 2 | 2 | |||||
| Resource Leveling | ||||||||||||||||
| Activity | Duration | Resource | 1 | 2 | 3 | 4 | 5 | 6 | 7 | 8 | 9 | 10 | 11 | 12 | 13 | 14 |
| A | 3 | Painter | 1 | 1 | 1 | |||||||||||
| B | 2 | Painter | 1 | 1 | ||||||||||||
| C | 2 | Trimmer | 1 | 1 | ||||||||||||
| D | 2 | Painter | 1 | 1 | ||||||||||||
| E | 4 | Trimmer | 1 | 1 | 1 | 1 | ||||||||||
| F | 6 | Trimmer | 1 | 1 | 1 | 1 | 1 | 1 | ||||||||
| G | 3 | Painter | 1 | 1 | 1 | |||||||||||
| H | 2 | Painter plus Trimmer | 2 | 2 | ||||||||||||
| Total | 2 | 2 | 2 | 2 | 2 | 2 | 2 | 2 | 2 | 2 | 1 | 1 | 2 | 2 | ||
After Resource loading and Leveling Project Duration has changed,
The new Project duration = 14 Days, or project needs at least 14 Days time to complete,
there will be new critical path as We have done Resource leveling and considering, there is only one Painter and One Trimmer, The New critical path would be ABGEH

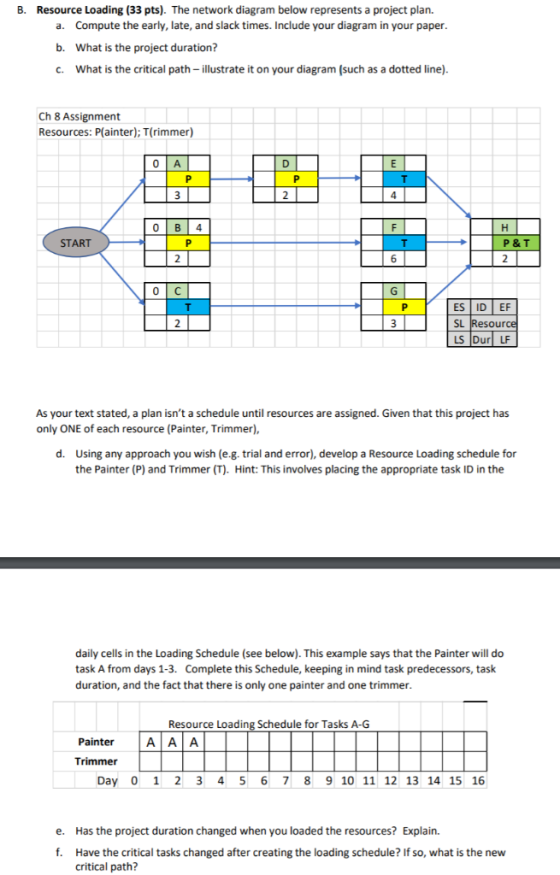

B. Resource Loading (33 pts). The network diagram below represents a project plan. a. b. C....
