In Exercise 1 Chapter 8, Given the network plan that follows, compute the early, late, and slack times. What is the project duration? Using any approach you wish (e.g., trial and error), develop a loading chart for resources, Electrical Engineers (EE), and resource, Mechanical Engineers (ME). Assume only one of each resource exists. Given your resource schedule, compute the early, late, and slack times for your project. Which activities are now critical? What is the project duration now? Could something like this happen in real project?

I tried my best to answer. I hope you understood. If you have any doubts mention in comments. Please give me a upvote. Thank You
In Exercise 1 Chapter 8, Given the network plan that follows, compute the early, late, and...

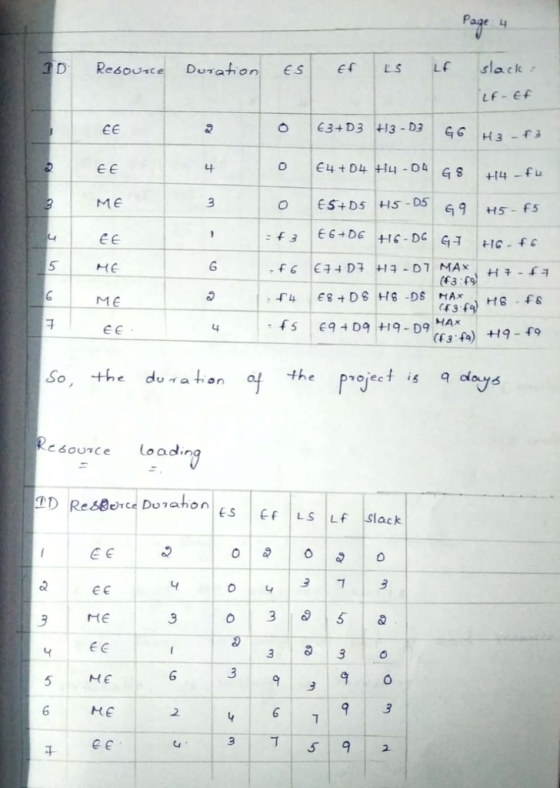

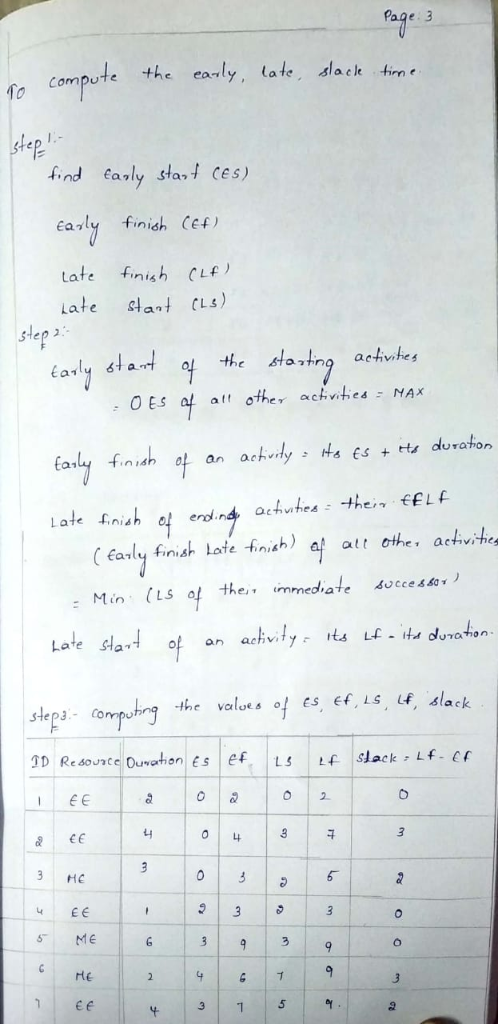

In Exercise 1 Chapter 8, Given the network plan that follows, compute the early, late, and slack times. What is the project duration? Using any approach you wish (e.g., trial and error), develop a loading chart for resources, Electrical Engineers (EE), and resource, Mechanical Engineers (ME). Assume only one of each resource exists. Given your resource schedule, compute the early, late, and slack times for your project. Which activities are now critical? What is the project duration now? Could something...

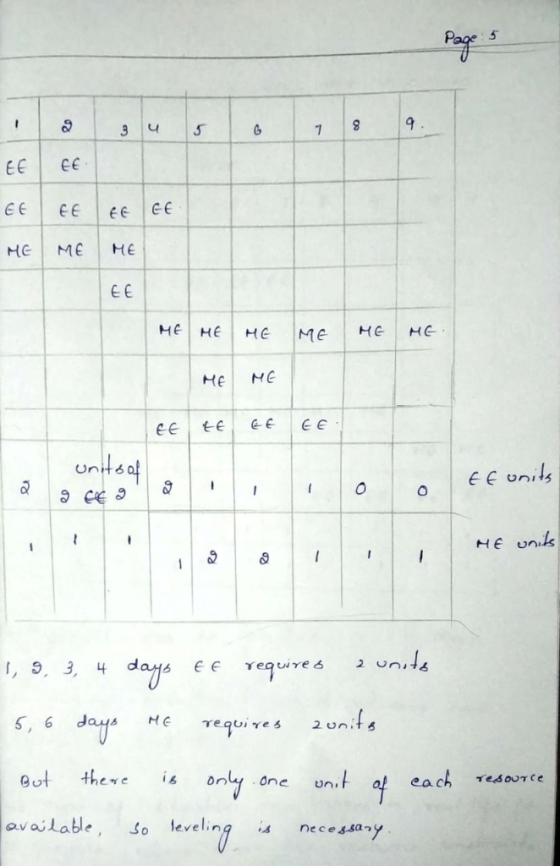

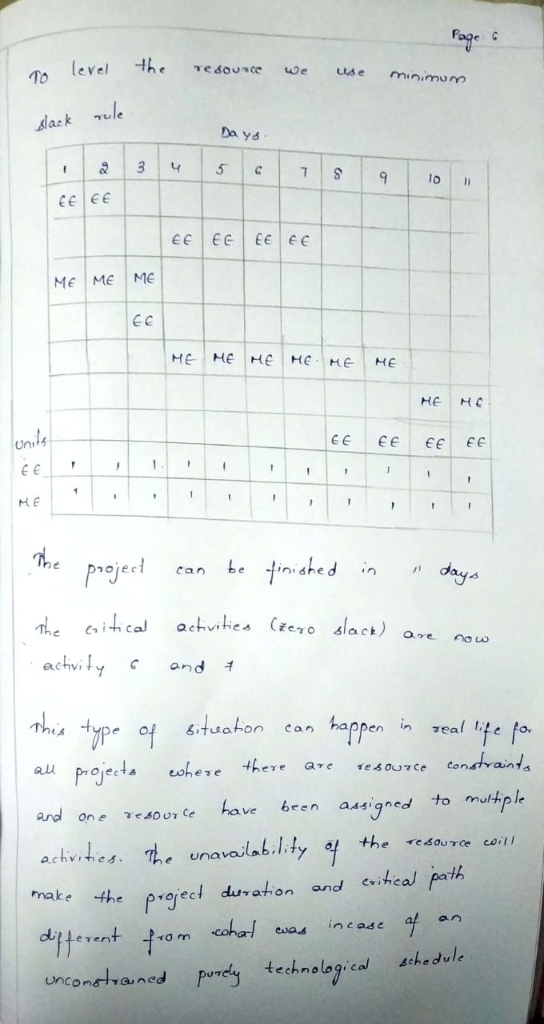

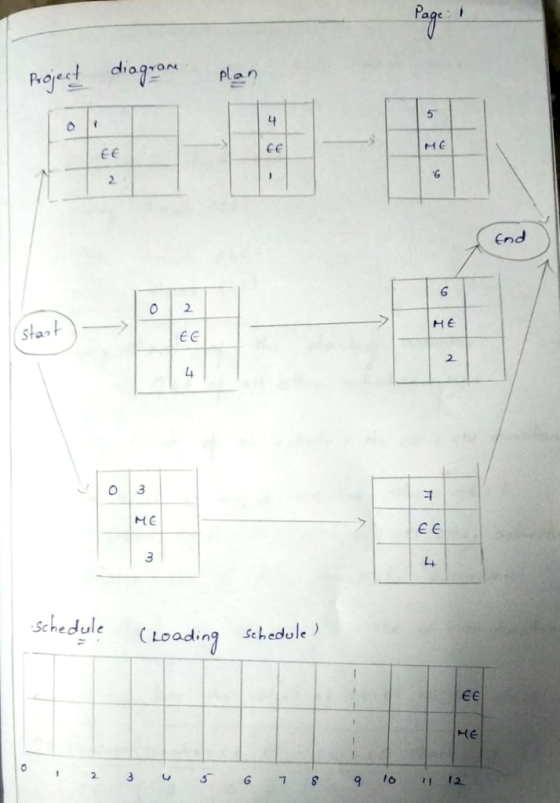

Plan ME Develop a loading schedule for each resource below. (Figure 8.3) EE ME 0 1 2 3 4 5 6 7 8 9 10 11 12 Fill in the times below for a resource activity schedule. ID/RES ES LSEF LF SL 1-EE Schedule 2.EE Legend ES ID EF 3-ME SL LS DUR LF 4.EE 5-ME 6-ME 7-EE Resource EX8-1 (Static) Given the network plan that... Given the network plan that follows, compute the early, late, and slack times. What...
B. Resource Loading (33 pts). The network diagram below represents a project plan. a. b. C. Compute the early, late, and slack times. Include your diagram in your paper What is the project duration? What is the critical path -illustrate it on your diagram (such as a dotted line). Ch 8 Assignment Resources: P(ainter); T(rimmer) 0 A START P & T ES ID EF SL Resour LS Dur LF 2 As your text stated, a plan isn't a schedule until...
21. Given the information in the following lag exercises, compute the early, late, and slack times for the project network. Which activities on the critical path have only the start or finish of the activity on the critical path? Lag 3 Interview 15 Def. New Features Order Comps Prototype Field Test Lag 5 Lag 10 10 Legend Description SL Duration
QUESTION 2 Given the following information, you are to determine the following Project network. Early, late and slack activity times. Project duration. Critical path Task Predecessor Duration A None 8 B A 5 C A 10 D A 15 E A 10 F B 12 G C, D 12 H E, 7 I G, H 7 J F,G,I 10 K J 12
Below is the network diagram for a construction project. Given ONLY THREE (3) workers are available at all times, develop a resource schedule using the parallel heuristics for resource-constrained projects. 0 A 1 1 2 1 1 1 2 4 E 7 0 0 4 3 7 IN نا 7 G 2 c 4 3 0 2 24 1 ON 0 7 00 000 7 1 4 1 F 1 0 B 2 02 o 0 2 2 N ON...
Assignment for week 5Given the following information, draw the project network. Compute the early, late and slack times for the project network. which activities are on the critical path have only the start or finish of the activity on the critical path?ID duration finish to start finish to start additional lag lag predecessor lag Relationship A 2 none 0 none 0B 4 A 0 none 0C 6 A 0 finish-finish C to F 7D 8 A 0 none 0E 18...
(3) Determine the critical path and critical time of the network
shown below. Use the critical path method (the table of ES, EF,
etc.).
(3) Determine the critical path and critical time of the network shown below. Use the critical path method (the table of ES, EF, etc.). po Problem . Example a 100 For all starting activities, ES is taken as 0. Activities 1-2, 1-3 gets ES of O. Find EF-ES +time. Activity Time ES E F LS L...
1 According to the project plan, a contractor is scheduled to deliver some software components today afternoon. A regular payment is due to be made to this contractor tomorrow. You and your project team received a note this morning informing you that the software delivery will be delayed by 2 weeks. What should you do right now? a You should delay the payment for two weeks b You must immediately find a different contractor c You should conduct a meeting...
CHAPTER 13 / Developing and implementing Effective Accounting Information Systems 431 14 FIGURE 13-11 PERT network diagram for a systems implementation project. 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32 33 34 35 36 37 Activity Prepare the Physical site 3958 Determine functional changes Select and assign personnel Train personnel Acquire and install computer equipment Establish...
