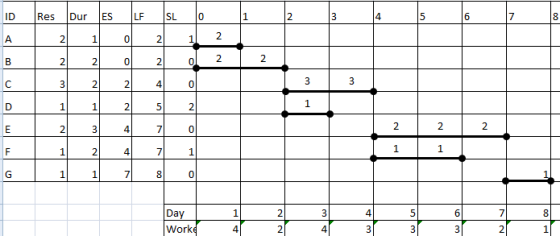

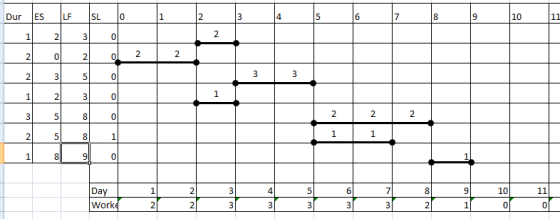

The Gantt chart for earliest schedule is as follows:

The Gantt chart according to resource-constraint is as follows:
1. Move A from ES = 0 to ES = 2
2. After completing A schedule activity C from ES = 3
3. Do not move activity D
4. After completing C schedule activity E and From from ES = 5
5. After completing E and F schedule Activity G from ES = 8

The project completion time of the resource-constraint scheduling is 9 days.

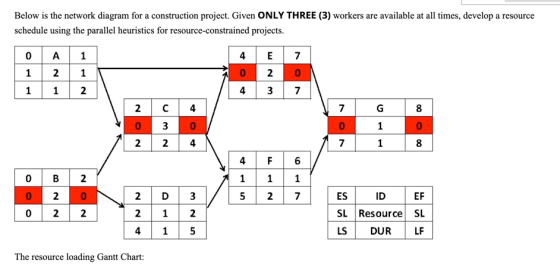

Below is the network diagram for a construction project. Given ONLY THREE (3) workers are available...
Plan ME Develop a loading schedule for each resource below. (Figure 8.3) EE ME 0 1 2 3 4 5 6 7 8 9 10 11 12 Fill in the times below for a resource activity schedule. ID/RES ES LSEF LF SL 1-EE Schedule 2.EE Legend ES ID EF 3-ME SL LS DUR LF 4.EE 5-ME 6-ME 7-EE Resource EX8-1 (Static) Given the network plan that... Given the network plan that follows, compute the early, late, and slack times. What...
B. Resource Loading (33 pts). The network diagram below represents a project plan. a. b. C. Compute the early, late, and slack times. Include your diagram in your paper What is the project duration? What is the critical path -illustrate it on your diagram (such as a dotted line). Ch 8 Assignment Resources: P(ainter); T(rimmer) 0 A START P & T ES ID EF SL Resour LS Dur LF 2 As your text stated, a plan isn't a schedule until...
Check my word 1 You have prepared the following schedule for a project in which the key resource is a tractor. There are three tractors available to the project. The resource requirements are as shown in the diagrams below. Develop a resource-constrained schedule. Use the parallel method and heuristics given. Be sure to update each period as the computer would do. ts SESSE DURU FEE eBook 1 eferences Use the following order of heuristics: 1. Minimum slack, 2. Smallest duration,...
You have prepared the following schedule for a project in which the key resource is a backhoe. This schedule is contingent on having 3 backhoes. You receive a call from your partner, Brooker, who desperately needs 1 of your backhoes. You tell Brooker you would be willing to let him have the backhoe If you are still able to complete your project in 11 months. Develop a resource schedule in the loading chart that follows to see if it is...
EX8-4 (Algo) You have prepared the following schedule... You have prepared the following schedule for a project in which the key resource is a tractor. There are three tractors available to the project. The resource requirements are as shown in the diagrams below. Develop a resource-constrained schedule. Use the parallel method and heuristics given. Be sure to update each period as the computer would do. Legend ESIDER SUK RES SUK U DURU 106 12 OO 5510 0155 5 5 Use...
You have prepared the following schedule for a project in which the key resource is a backhoe. This schedule is contingent on having four backhoes. You receive a call from your partner, Brooker, who desperately needs one of your backhoes. You tell Brooker you are willing to let him have the backhoe if you are still able to complete your project in 13 months. Develop a resource schedule to see if it is possible to complete the project in 13...
Given the project network and baseline information below, complete the form to develop a status report for the project at the end of period 4 and the end of period 8 LEGEND ES | ID | EF SL LS DUR LF SL 8 D 12 0 8412 0 0 0 2 6 8 12 F15 0 12 315 0 0 0 7 E 10 2 93 12 2 4 5 9 Time Period Task LF DUR ES SL Budget (PV)...
Consider a project with the following information: Activity Duration Predecessors A 5 -- B 7 A C 9 B D 5 B E 7 C, D F 6 D G 4 C H 7 E, F, G Activity Duration ES EF LS LF Float A 5 0 5 0 5 B 7 5 12 5 12 C 9 12 21 12 21 D 5 12 17 16 21 E 7 21 28 21 28 F 6 17 23 22 28...
Problem #3 (25 points) For the construction project whose network diagram is shown below, a time-cost optimization procedure is required to determine the shortest duration and its corresponding lowest cost. Activity ID ES Darwin EF LS UF 1. Fill in values for the normal cost and crashed cost in the table below. Activities A and B already have costs associated with them. For activities through I do not use the same costs for any activity 2. Calculate the slope and...
Problem 5. For the diagram below find the critical path, the duration of the project, and calculate the slack for each task, including each tasks' ES, EF, LS and LF 2 8 113 912 4 6 12 4 6 10
