Question

Problem #3 (25 points) For the construction project whose network diagram is shown below, a time-cost optimization procedure

3. Based on the calculated slopes, crash the best four (4) activities to the crashed durations regardless of critical path. F
0 0
Add a comment Improve this question Transcribed image text
Answer #1

◆ Hello,

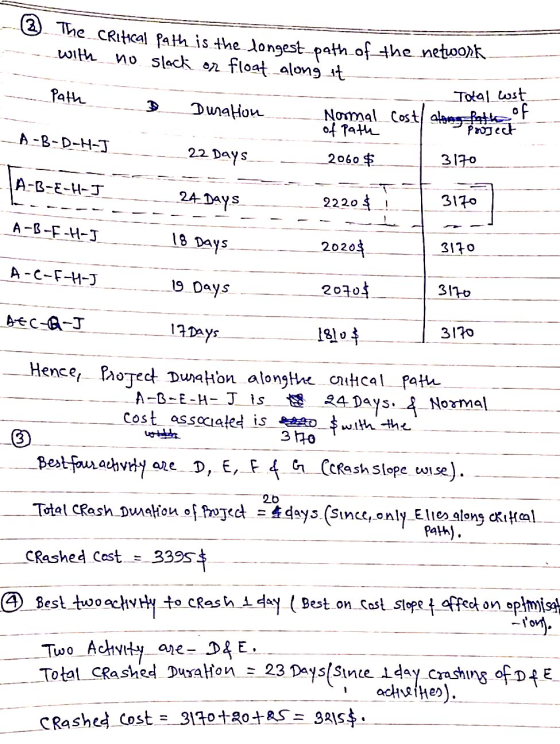

Normal Crashed Acuity- Duration_duration Normal ast CRashel Cost. Crash slupe preference NC-CC orcher Spay hash A 3 3 600 600with @ The Critical Path is the longest path of the network no slack or float along it path Duration Normal cost along that t

So I hope it will help you. Stay home Be safe.

Thank you.

Add a comment
Know the answer?
Add Answer to:
Problem #3 (25 points) For the construction project whose network diagram is shown below, a time-cost...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
