PP.72 A manufacturer of solid state drives (SSDs) has projected the next six months of demand to be as shown the table below:
| Supply/Demand Info | Beginning | Jan | Feb | Mar | Apr | May | Jun |
| Forecast (demand) | 48,000 | 52,000 | 60,000 | 54,000 | 58,000 | 64,000 | |
| Regular production | |||||||
| Overtime production | |||||||
| Subcontract production | |||||||
| Ending inventory | 6,000 | ||||||
| Hired employees | |||||||
| Fired employees | |||||||
| Total employees | 200 |
Cost variables as as follows:
| Cost Variables | |
| Labor cost/hour | $14 |
| Overtime cost/unit | $32 |
| Subcontracting cost/unit | $29 |
| Holding cost/unit/month | $8 |
| Hiring cost/employee | $2,500 |
| Firing cost/employee | $4,200 |
Here is some additional relevant (capacity) information:
| Capacity Information | |
| Total labor hours/SSD | 2 |
| Regular production units/employee/month | 200 |
| Max regular production/month | 56,000 |
| Max overtime production/month | 4,000 |
| Max subcontractor production/month | 5,000 |
Given the above information (and don't overlook beginning number of employees and inventory levels in the first table), create a combination production plan using Solver to determine the lowest cost solution by optimizing the set of trade-offs among hiring and firing, overtime and subcontractor production, and holding inventory.

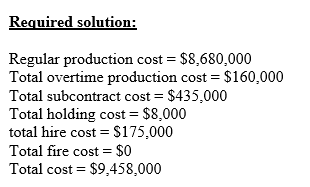

What is the regular production cost (over the six months from January through June) for this optimized production plan? (Display your answer to the nearest whole number.)
What is the total overtime production cost for this production plan? (Display your answer to the nearest whole number.)
What is the total subcontract cost for this production plan? (Display your answer to the nearest whole number.)
What is the total holding cost for this production plan? (Display your answer to the nearest whole number.)
What is the total hire cost for this production plan? (Display your answer to the nearest whole number.)
What is the total fire cost for this production plan? (Display your answer to the nearest whole number.)
What is the total cost (sum of all costs) for this production plan? (Display your answer to the nearest whole number.)

PP.72 A manufacturer of solid state drives (SSDs) has projected the next six months of demand...
I only have 1 hour left, please help!! PP.62 A manufacturer of solid state drives (SSDs) has projected the next six months of demand to be as shown the table below: Supply/Demand Info Beginning Jan Feb Mar Apr May Jun Forecast (demand) 48,000 52,000 60,000 54,000 58,000 64,000 Regular production Overtime production Subcontract production Ending inventory 6,000 Hired employees Fired employees Total employees 200 Cost variables as as follows: Cost Variables Labor cost/hour $14 Overtime cost/unit $32 Subcontracting cost/unit $29...
PP.63 Jupiter, a large candy company, is having great success with its "Swan" family of candy bars. Due to a number of factors they like to plan their production at least nine months into the future. The table below contains their demand projections (in tons) for April through December: Supply/Demand Info Beginning Apr May Jun Jul Aug Sep Oct Nov Dec Predicted sales 3,000 2,200 1,900 2,000 2,400 3,200 4,800 2,700 3,600 Regular production Overtime production Subcontract production Ending inventory...
PP.61 A small manufacturer of specialty welding equipment has developed a level production plan for the next four quarters, as seen below: Supply/Demand Info Pre-Q1 Q1 Q2 Q3 Q4 Forecast (demand) 4,600 4,600 3,680 6,440 Regular production 4,830 4,830 4,830 4,830 Subcontract production Ending inventory Hired employees 12 Fired employees Total employees 30 42 42 42 42 Additional Information: Capacity Information & Cost Variables Production rate (units/employee/quarter) 115 Subcontractor capacity (units/quarter) 480 Regular production cost/unit $70 Holding cost/unit/quarter $14...

Show excel work
PP.52 A manufacturer of solid state drives (SSDs) has projected the next six months of demand to be as shown the table below Jan 48,00052,00060,00054,00058,00064,000 Feb Mar Apr May Jun Supply/Demand Info Beginning Forecast (demand) Regular production Overtime production Subcontract production Ending inventory Hired employees Fired employees Total employees Cost variables as as follows: 6,000 200
A small manufacturer of specialty welding equipment has developed a level production plan for the next four quarters, as seen below: Supply/Demand Info Pre-Q1 Q1 Q2 Q3 Q4 Forecast (demand) 2,300 2,760 3,680 5,980 Regular production 3,680 3,680 3,680 3,680 Subcontract production Ending inventory Hired employees 11 Fired employees Total employees 21 32 32 32 32 The table below shows additional relevant information: Capacity Information & Cost Variables Production rate (units/employee/quarter) 115 Subcontractor capacity (units/quarter) 480 Regular production...
A manager has projected demand for the next six months (below). Given this information, prepare a LEVEL aggregate plan for production. Assume maximum regular time production is 350 units per month. Overtime is limited to 75 units per month. The limit for subcontracting is 400 per month. The company has a zero beginning inventory and cannot have ending inventory or a backlog at the end of the 6th period. Unit costs are as noted below. Regular Time Cost: $10/unit Overtime...
Given the projected demands for the next six months, prepare an aggregate plan that uses inventory, regular time, overtime, subcontract and backorders. Regular time is limited to 150 units per month (Cost per Unit = $30 ). Overtime is limited to a maximum of 20 units per month (Cost per Unit -S45). Units purchased from the subcontractor (Cost per Unit = $54 ) cannot exceed 60 per month and the total purchases from the subcontractor over the 6 month period...
The current aggregate demand requirements for a firm are shown below for the next six months: Month May June July Aug Sept Oct Demand 270 250 250 250 280 300 The firm always plans to meet all demand. The firm currently has 270 workers capable of producing 270 units in a month (1 unit/worker). The workforce can be increased (at a cost of $700 per worker) or decreased (at a cost of $1,400 per worker). Inventory holding cost is $175...
02 Consuelo Chua, Inc., is a disk drive manufacturer in need of an aggregate plan for July through December. The com- pany has gathered the following data: COSTS Holding cost $8/disk/month Subcontracting 580/disk Regular-time labor $12 hour Overtime labor $18 hour for hours above 8 hours/workerday Hiring cost $4000/ worker Layoff cost $8000/worker DEMAND Note: In this problem (and Q3) the production cost should be computed based on the labor cost OTHER DATA Current worden 8 people Labor hours disk...
Ram Roy's firm has developed the following supply, demand, cost, and inventory data Supply Available Regular Time 30 30 40 Demand Period Overtime Subcontract Forecast 15 15 20 40 45 60 Initial inventory Regular-time cost per unit Overtime cost per unit Subcontract cost per unit Carrying cost per unit per month 20 units $100 $150 $200 $6 Assume that the initial inventory has no holding cost in the first period and backorders are not permitted Allocating production capacity to meet...
