Question

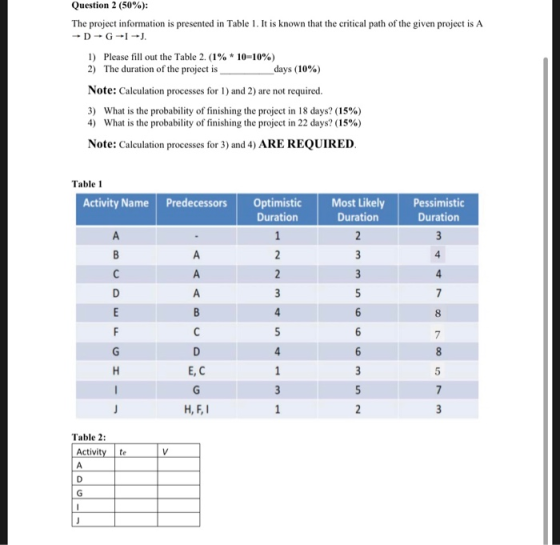

Question 2 (50%): The project information is presented in Table 1. It is known that the critical path of the given project is
0 0
Add a comment Improve this question Transcribed image text
Answer #1

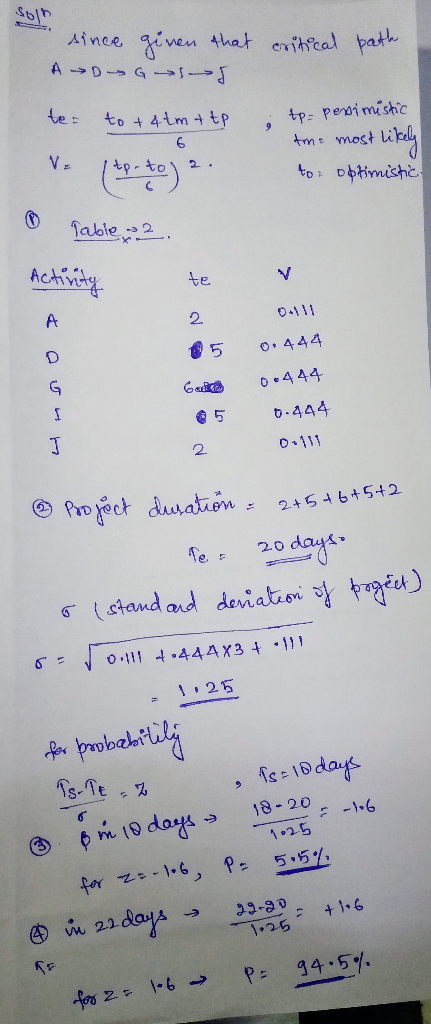

solh since go since given that critical parth AD G te= to +4 tm + tp t p- pesimistic the most likely V. (tp-to) 2. to optimis

Add a comment
Know the answer?
Add Answer to:
Question 2 (50%): The project information is presented in Table 1. It is known that the...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • PERT: Calculate the probability of finishing the project in 25 days or less Activity 10-20 10-30...

    PERT: Calculate the probability of finishing the project in 25 days or less Activity 10-20 10-30 20-40 30-40 20-30 16 15 10 12 10 13 4 10 Dummy a is the optimistic duration m is the most likely duration b is the pessimistic duration

  • Using the following information about Project A, its activities and predecessor activities below: Activity Predecessors A...

    Using the following information about Project A, its activities and predecessor activities below: Activity Predecessors A в B C D E, F D G The following table contains the pessimistic, likely, and optimistic estimates for how long activities are estimated to take for Project A. Activity Pessimistic Likely Optimistic 2 5 20 H 16 e. Calculate the time estimates (TE) f. Calculate the variance (s) g. Convert the TE to whole integers and place them in the network diagram for...

  • 5. A project has critical path activities A, B, and C. A is the predecessor of B. B is the predec...

    5. A project has critical path activities A, B, and C. A is the predecessor of B. B is the predecessor of C. The duration estimate for activity A, B and C is shown in the following table. Fill the table with mean duration, standard deviation, and variance for activities and the whole project (critical path). Determine what is the probability of completing this project within 80 days? (10 points) Activity Optimistic Pessimistic Most likely Mean Standard Variance deviation duration...

  • Given the following activity list and times in days: (15 points) Activity           Optimistic       Most Likely     Pessimistic...

    Given the following activity list and times in days: (15 points) Activity           Optimistic       Most Likely     Pessimistic                         Time                Time                Time A                     7                      10                    12 B                     6                      8                      14 C                     5                      9                      12 D                     12                    14                    21 E                      10                    12                    15 F                      4                      5                      8 G                     1                      3                      8 H                     12                    15                    17 NOTE 1: ASSUME THE CRITTCAL PATH IS “B-E-H”. Calculate the schedule duration of the critical path in days. What is the probability of the project being completed...

  • If the contracted duration for a project with the following network is 120 days, what is the prob...

    If the contracted duration for a project with the following network is 120 days, what is the probability (in percent) of meeting the schedule based on PERT analysis? Then, assume that the owner delays the start by 5 days while keeping the end date as originally scheduled. What is the probability (in percent) that the project will still finish at the originally scheduled completion date? The requested probabilities should be determined based on the entire network and not just one...

  • 1. Sid Orland is involved in planning a scientific research project. The activities are displayed in the following...

    1. Sid Orland is involved in planning a scientific research project. The activities are displayed in the following diagram. Optimistic, most likely, and pessimistic time estimates are displayed in the following table. Figure for Problem 1. r e 14 16 E 4 H 4 7 11 7 11 16 20 G 5 0 33 611 16 11 16 D 3 Most Likely Pessimistic Activity Optimistic 4 4 (a) Determine the expected times and variances for each activity along the critical...

  • Pert project method Activity Predecessors A group 5 optimistic Most likely Pessimistic Expected Variance a m...

    Pert project method Activity Predecessors A group 5 optimistic Most likely Pessimistic Expected Variance a m b Time (t) o 2 3 2 1 B с D NWN mlm A 1 A,B 2 4 1 6 7 9 F 1 с с DE F,G 4 2 5 3 G 4 12 H 2 4 From the table above find the flowing answers. 1. Construct the project Network 2. Find the expected duration and Variance of each activity 3. Find the...

  • Microsoft Project Assignment Description A system development project has been defined to contain the following list of...

    Microsoft Project Assignment Description A system development project has been defined to contain the following list of activities along with their estimated times for completion. The project will start on 5/1/2019. Project Data Provided: Activity ID Activity Name Days Predecessors Optimistic(O) Realistic(R) Pessimistic(P) 1 Gather Requirement 1 2 3 2 Analyze processes 1 2 6 1 3 Define DFDs 0.5 1 1.5 2 4 Design Processes 2 7 12 2 5 Design database 4 7 22 3 6 Design UI...

  • QUESTION 1 G E. H. C A Finish Start D. Complete the network activity diagram using the table below to answer questio...

    QUESTION 1 G E. H. C A Finish Start D. Complete the network activity diagram using the table below to answer questions 1-15. The expected activity completion times are provided in days. Each question is 1 point. Most Probable Activity Optimistic Pessimistic A 7 B 12 C 5 12 7 E 10 15 20 6 9 18 G 6 13 H 11 What is the early start (ES) time for activity F? 13 12 10 None of the above are...

  • 2. Given the table below (10 pts): A. Draw the project network B. Calculate the expected...

    2. Given the table below (10 pts): A. Draw the project network B. Calculate the expected time to complete each activity as well as the variance (or standard deviation) associated with that time C. Determine the time associated with each potential path and denote the critical path D. Given the calculated data, what is the probability of completing the project in 30 days? 35 days? E. If you were to try to improve your performance (in terms of time), what...
