Question

Assume the following information (figures are in thousands):                              Budgeted Costs for Samp

  1. Assume the following information (figures are in thousands):

                             Budgeted Costs for Sample Project

Duration (in weeks)

5

10

15

20

25

30

35

40

45

Total

Design

4

4

2

Engineer

3

6

12

8

Install

4

12

24

6

Test

2

6

6

4

2

Total Monthly Cumul.

a.         Calculate the monthly budget and the monthly cumulative budgets for the project.

b.         Draw a project S-curve identifying the relationship between the project’s budget baseline and its schedule.

0 0
Add a comment Improve this question Transcribed image text
Answer #1

a)

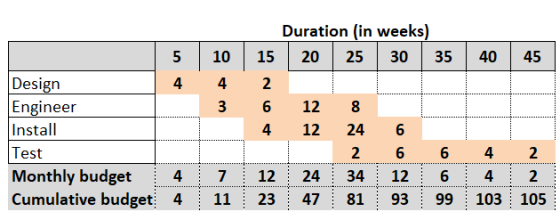

Monthly budget and the monthly cumulative budget is tabulated below:

Duration (in weeks) 20 5 10 25 30 35 40 45 4 3 15 2 6 4 12 12 6 Design 4 Engineer Install Test Monthly budget 4 Cumulative bu

-------------------------------------------------------------

b)

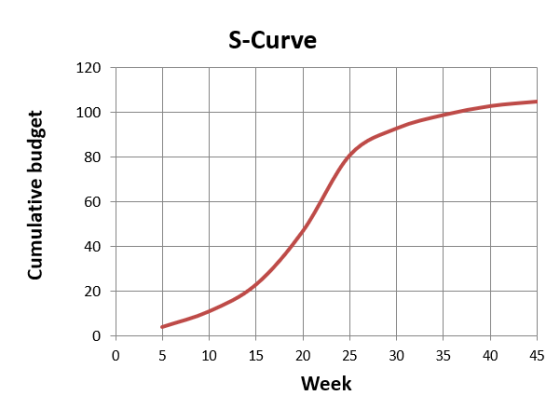

Project S-curve is following:

S-Curve 120 100 80 Cumulative budget 60 40 20 0 0 5 10 15 20 25 30 35 40 45 Week

Add a comment
Know the answer?
Add Answer to:
Assume the following information (figures are in thousands):                              Budgeted Costs for Samp
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • The information about a project is shown below. Duration Immediate Budgeted Cost Activity (weeks) Predecessor(s) ($/week)...

    The information about a project is shown below. Duration Immediate Budgeted Cost Activity (weeks) Predecessor(s) ($/week) A T 3 none 40,000 в з А 22,000 C2A 17,000 D 3 B 27,000 E5C 16,000 The above table shows that the budgeted cost of activity E is $16,000 per week. NOTE: Do not use any comma in your answer. The cumulative budgeted cost at the end of week 4 is dollars The cumulative Juugeleu cost at the NOTE: Do not use any...

  • Given the time-phased work packages and network, complete the baseline budget form for the project. Market...

    Given the time-phased work packages and network, complete the baseline budget form for the project. Market Survey Project WBS Work Package Cost by Week WP Design - 52 WP Survey 2 2 4 4 - 5 WP Report 332 Project Network Design Survey Report Task Budget Time-Phased Budget Week 3 4 5 6 7 8 9 10 11 Design Survey Report 80 Total Cumulative

  • Use the following project status information to calculate each of the requested EVM numbers below. The...

    Use the following project status information to calculate each of the requested EVM numbers below. The project status is reported at the end of week 13. 5. Cost performance index: 6. Schedule performance index 7. Budget at completion 8. Estimate to complete 9. Estimate at completion Task Budget Cost Budget Duration Status as of Week 13 A $5,000 2 weeks 100 percent com- plete, $5,000 B $8,500 3 weeks 100 percent com- plete, $9,000 с $15,000 4 weeks 75 percent...

  • 1. Using Microsoft Excel prepare a Gantt Chart for the following project. Predecessor(s) Duration (Days) Activity...

    1. Using Microsoft Excel prepare a Gantt Chart for the following project. Predecessor(s) Duration (Days) Activity 1. Forming the problem statement 2. Identifying functional requirements 3. Identifying constraints and limitations 4. Defining a schedule 5. Defining the design parameters 6. Identifying alternatives 7. Evaluating and analyzing alternatives 8. Select a solution 9. Gather supplies 10. Construct prototype 11. Test performance 12. Redesign 13. Demonstrate solution to class 2,3 2 8 10 11 12

  • Consider a project with the following information: Activity Duration Predecessors A 5 -- B 7 A...

    Consider a project with the following information: Activity Duration Predecessors A 5 -- B 7 A C 9 B D 5 B E 7 C, D F 6 D G 4 C H 7 E, F, G Activity Duration ES EF LS LF Float A 5 0 5 0 5 B 7 5 12 5 12 C 9 12 21 12 21 D 5 12 17 16 21 E 7 21 28 21 28 F 6 17 23 22 28...

  • Table 2 contains information about an environmental cleanup project in the township of Hiles. Shorten the...

    Table 2 contains information about an environmental cleanup project in the township of Hiles. Shorten the project 3 weeks by finding the minimum-cost schedule. Assume that project indirect costs and penalty costs are negligible. Identify activities to crash while minimizing the additional crash costs. What is the project’s duration if only normal times are used? What is the minimum-cost schedule? What is the critical path for the minimum-cost schedule? TABLE 2 Activity Normal Time (wks) Crash Time (wks) Cost to...

  • Given all the information in the table, use PERT/CPM to help Mr. Hawthorne address to the...

    Given all the information in the table, use PERT/CPM to help Mr. Hawthorne address to the following questions. A. Create the network diagram representing the problem. B. What is the total time expected to be required to complete the project if no delays occur? C. What are the earliest and latest start and finish times for the individual activities required to meet the expected project completion time provided in question B (show your method for determining this)? D. Which are...

  • Tiro provides you with the following information Project 3 Cash budgets and budgeted financial statements (Chapters...

    Tiro provides you with the following information Project 3 Cash budgets and budgeted financial statements (Chapters 4 and 5) Question 1 P. Ttro provides you with the following figures March actual sales April budgeted sales May budgeted sales June budgeted sales 42 000 39 COC 36 CCC 25 200 Sales are expected to be 70% credit and 30% cash and include GST. Invoices for credit sales are issued at the end of the month. Accounts receivable pay 70% within 30...

  • QUESTION 1 3.8 points Save Ans The cost management plan has all of the following characteristics EXCEPT It may specify variance thresholds for monitoring cost performance to indicate an...

    QUESTION 1 3.8 points Save Ans The cost management plan has all of the following characteristics EXCEPT It may specify variance thresholds for monitoring cost performance to indicate an agreed-upon amount of variation to be allowed before some action needs to be taken. It describes how the project costs will be planned, structured, and controlled. It is based on project cost estimates and is separate from the project management plan. It may specify the level of precision, which is the...

  • Megah Holding Sdn. Bhd is in progress to start their housing project. The list of activity...

    Megah Holding Sdn. Bhd is in progress to start their housing project. The list of activity and scheduled of the project is proposed as in Table 1. If the indirect costs for each duration is as follows, compute the direct and total cost for each duration. What is the optimum cost-time schedule? Indirect cost 27 weeks – RM 350 26 weeks – RM 270 25 weeks – RM 160 24 weeks – RM 100 12 weeks – RM 70 (12...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
