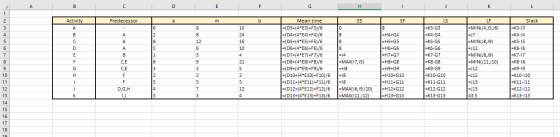

Formulas used are shown in the below table,

Formulas used to calculate ES,EF,LS and LF are shown below:
Forward pass -
ES = Maximum(EF of the predecessor activities)
EF = ES + Mean time
Backward pass -
LF = Minimum(LS of all succeeding activities)
LS = LF - Mean time
Note,
ES for Activity A = 0
LF for activity K = EF for activity K
Critical path is the path with the activities with zero slack
Hence,

critical path is A-B-E-F-H-J-K
Time required for critical path = 43.5 units of time.

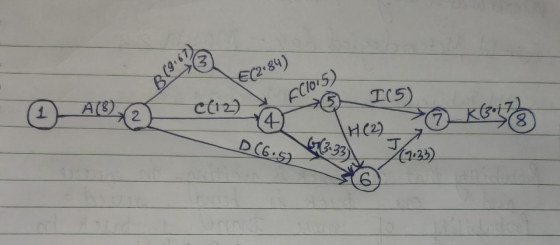

a.) Create project network for activites A thru G b.) Then compute on the network above,...
Problem 9-14 Given the following activity times in months, determine the items listed below: Time Estimates (months) Activity Activity Predecessor а т 4 12 A B 6 10 15 С 2 10 14 1 D A 4 13 E A 3 F В 3 6 18 G 2 8 12 Н С.Е.F С.Е.F 15 22 I 5 12 21 J D 20 25 K G.I 5 12 L Н.К 3 20 Expected activity times b. Variance times а. c. Earliest...
QUESTION 5 Given is a CPM project network diagram as shown below. А C F Start E Н. End B D G A B D E F G H Activity day Start 0 с 8 End 0 6 3 7 4 9 4 6 a) The Project Cor etion time = days b) The Earliest Start time, ES, of Activity G- days. c) The Latest Finish time, LF, of Acitivity - days. d) The critical activities are = (ex. Fill...
please show answers clearly
12 points Save Answer QUESTION 5 Given is a CPM project network diagram as shown below. F А H End E Start G B D E F Activity day Start 0 A 5 B 6 Ula G 5 H 4 End 0 ON 9 8 days. a) The Project Completion time = days. b) The Earliest Start time, ES, of Activity G= days.. c) The Latest Finish time, LF, of Acitivity C = d) The critical...
Given is a CPM project network diagram as shown below. A F Start E H End B D G Start H Activity day А 6 B 3 с 8 D 7 E 4 F 9 G 4 End 0 0 6 a) The Project Completion time = days. b) The Earliest Start time, ES, of Activity G - days. c) The Latest Finish time, LF, of Acitivity - dayy d) The critical activities are (ex. Fill in answer as: ABCD)
QUESTION 5 Given is a CPM project network diagram as shown below. А F Start E H End B D G Start A B C D E F G H End Activity day 0 6 زر 8 7 4 9 4 6 0 a) The Project Completion time = days. b) The Earliest Start time, ES, of Activity G= days. c) The Latest Finish time, LF, of Acitivity C = days. d) The critical activities are = (ex. Fill in...
Consider a project having the following six activities: Immediate Max Crash cost Activity Predecessors Time (weeks) Crash* per week A none 6 6 N/A B none 5 2 $500 C A 3 2 $1000 D A, B 4 2 $2000 E C, D 5 2 $1250 F D 6 2 $1000 *Shortest possible time for the task 1. Draw the project network and list...
Given is a CPM project network diagram as shown below.
Activity
Start
A
B
C
D
E
F
G
H
End
day
0
5
6
9
6
9
8
5
4
0
a) The Project Completion time = days.
b) The Earliest Start time, ES, of Activity G = days.
c) The Latest Finish time, LF, of Acitivity C = days..
d) The critical activities are = (ex. Fill in answer as: ABCD)
End Start
QUESTION 5 Given is a CPM project network diagram as shown below. A F Start H End B D G B Activity days Start 0 A 2 H D 3 E 4 F 2 G 3 6 8 End 0 2 a) The Project Completion time days. b) The Earliest Start time, ES, of Activity G - days. c) The Latest Finish time, LF, of Acitivity C- days. d) The critical activities are (ex. Fill in answer as: ABCD)
Paragraph HOMEWORK Number 8 a) Construct a CPM network for the project shown in a tabular form b) Calculate ES(early start) and LS (Late Start) of each activity c) Find critical path and its duration, make it bold or red color. Activity Immediate Predecessor Activity Duration(weeks}} А А A B.C 12 D CB н EEG
Consider a project having the following six activities: Immediate Max Crash cost Activity Predecessors Time (weeks) Crash* per week A none 7 7 N/A B none 3 2 $500 C A 5 3 $1000 D A, B 6 4 $2000 E C, D 4 3 $1250 F D 3 2 $1000 *Shortest possible time for the task 1. Draw the project network and list...
