what is the normal cost of this project? what is the cost of the project after...
Question 1:
I)-What is the normal cost of this project?
II)-What is the cost of the project after 2 days shortening?
III)-What is the crashing cost per day for activity G?

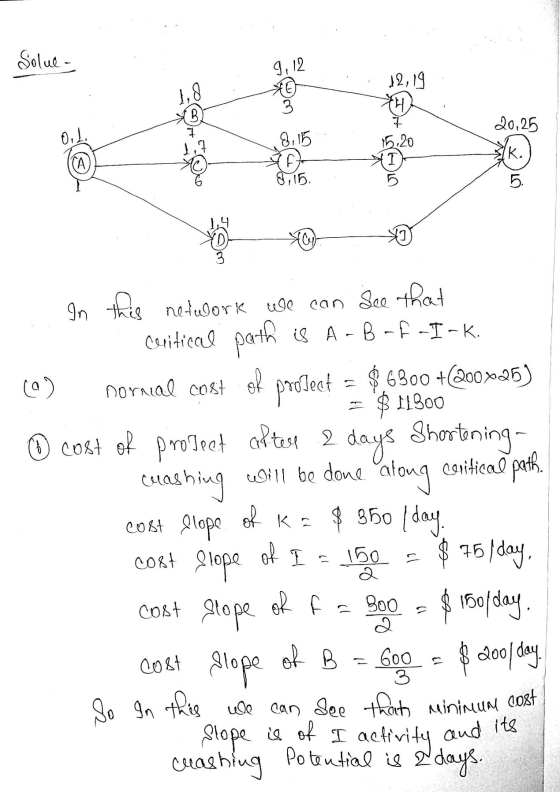

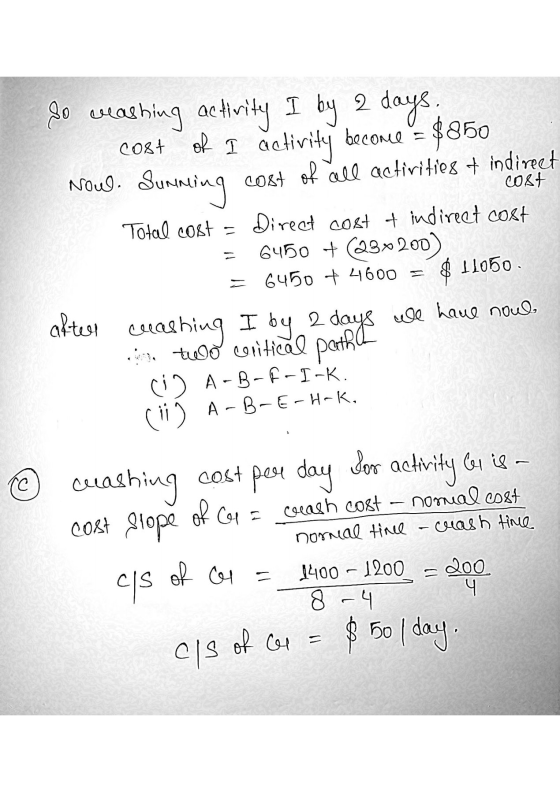

Given the following data and network, find answer the questions 18-20 if you're asked to finish this project 2 days earlier than its normal duration. Indirect cost (overhead) is $200 per day. 9.12 E 3 1.8 12. 19 10,13 B 7 1,8 13.20 0,1 1,7 8.15 20,25 15.20 F...

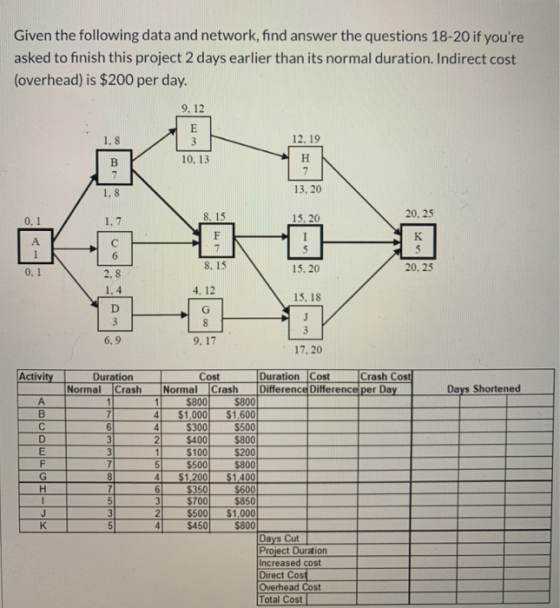

Given the following data and network, find answer the questions 18-20 if you're asked to finish this project 2 days earlier than its normal duration. Indirect cost (overhead) is $200 per day. 9.12 1.8 E 3 12. 19 B 10.13 H 7 1.8 13.20 0.1 1.7 8.15 15.20 20.25 A F I с 6 u K 5 20.25 0.1 8.15 15.20 4. 12 2.8 1.4 D 3 6,9 15.18 G 8 9.17 3 17.20 Duration Normal Crash Days Shortened 7...
A B Start E End C D Activity Normal time (days) Normal cost Crash time Cr 3 1 А B с D E 7 3 6 3 2 $300 $250 $400 $200 $300 4 2 1 ive the crash cost per day per activity. (5 points) Search 36_WA_Homework_EV_Problems_v1 (1) - Protected View - Saved References Mailings Review View Help PROBLEM 1 Use the network diagram below and the additional information provided to answer the corresponding questions. (10 points) B E...
3. The client of a project has requested the project team to crash 8 hours of time. The table below provides the necessary information about the possible project crashing. (a) What is the crash cost for 8 hours of time-savings? (b) Assume the team calls the client and asks for a project extension, reducing the amount of time they need to crash. The project team has a $20 crash budget. Is the budget sufficient to crash 4 hours of time?...
Question 6 - 8 Activity Depends on А B C D E F G A A А B C,D D, E, F Duration (Days) Normal Crash 5 4 7 5 8 5 11 8 6 4 4 3 7 5 Cost ($) Normal Crash 500 620 350 500 800 920 1000 1300 600 750 420 500 700 1000 6. Draw the node network for the above project using the following template. For each activity, show the computed value of early...
The Advanced Tech Company has a project to design an integrated information data base for a major bank. Data for the project are given $150 per day. The company will incur a $100 per day penalty for each day the project lasts beyond day 15. the following table. Indirect project costs amount to Normal Time Crash Time Crash Cost Immediate Normal Cost (S) Activity Predecessor(s) (S) (days) (days) 1.200 A 6 800 4 6 1,000 2 2,200 600 900 C...
QUESTION 27 What is the cost of crashing the project represented in the table below, by 3 days? Immediate Normal Crash Normal Crash Activity Predecessors Time/Days Time/Days Cost Cost А 3 2 $200 $500 B А 3 2 $350 $550 С А 2 1 $300 $250 D B&C 3 $500 $550 E С 2 $500 $900 F D&E . $500 $1,000 NN $150 $450 $550 $2450 $2750 QUESTION 1 According to Michael Porter, the primary activities in a value chain...
3. The client of a project has requested the project team to crash 8 hours of time. The table below provides the necessary information about the possible project crashing. (a) What is the crash cost for 8 hours of time-savings? (b) Assume the team calls the client and asks for a project extension, reducing the amount of time they need to crash. The project team has a $20 crash budget. Is the budget sufficient to crash 4 hours of time?...
Question 15 The following information about a project was provided: • Indirect costs per day: $233 • Late completion penalty of $84 per day beyond day 19 • The current Critical Path duration is 26 Acitvity А B с D E F G Immed Normal Normal Pred(s) Time (days) Cost ($) 3 7,000 1 3,000 A 4 12,000 B 2 12,000 1 8,000 DE 4 5,000 E 2 9,000 Crash Time Crash Cost (days) 2 10,000 1 3,000 2 40,000...
The Advanced Tech Company has a project to design an integrated information data base for a major bank. Data for the project are given in the following table. Indirect project costs amount to S150 per day. The company will incur a $100 per day penalty for each day the project lasts beyond day 15. Normal Time Crash Time Crash Cost Immediate Normal Cost ($) Activity (S) (days) (days) Predecessor(s) 6 800 1,200 A 4 6 1,000 2,200 C 600 1...
