Can you explain how you came to your answers. Just the answer does me no good. Thank you so much!

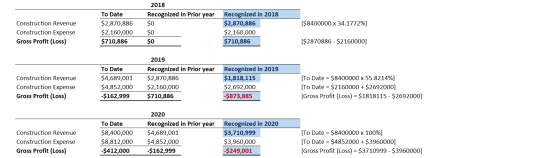

![Construction Revenue Construction Expense Gross Profit (Loss) [$8400000 x 34.1772%] 2018 Recognized in Prior year $0 $0 $0 To](http://img.homeworklib.com/questions/4c949350-b5ab-11eb-8832-7f35d8be8145.png?x-oss-process=image/resize,w_560)

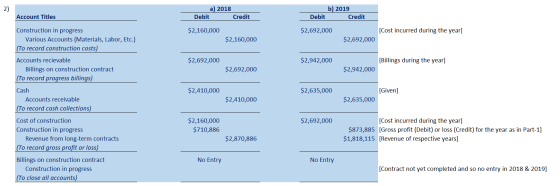

![2) a) 2018 Debit Credit b) 2019 Debit Credit Account Titles $2,160,000 $2,692,000 [Cost incurred during the year] Constructio](http://img.homeworklib.com/questions/4d01afd0-b5ab-11eb-ac91-db1ccf7dc1de.png?x-oss-process=image/resize,w_560)

Can you explain how you came to your answers. Just the answer does me no good....

On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,400,000. During 2021, costs of $2,160,000 were incurred, with estimated costs of $4,160,000 yet to be incurred. Billings of $2,692,000 were sent, and cash collected was $2,410,000. In 2022, costs incurred were $2,692,000 with remaining costs estimated to be $3,840,000. 2022 billings were $2,942,000, and $2,635,000 cash was collected. The project was completed in 2023 after additional costs of...
On February 1, 2018, Arrow Construction Company entered into a
three-year construction contract to build a bridge for a price of
$8,125,000. During 2018, costs of $2,050,000 were incurred, with
estimated costs of $4,050,000 yet to be incurred. Billings of
$2,560,000 were sent, and cash collected was $2,300,000. In 2019,
costs incurred were $2,560,000 with remaining costs estimated to be
$3,675,000. 2019 billings were $2,810,000, and $2,525,000 cash was
collected. The project was completed in 2020 after additional costs
of...
it says it's incomplete, please help
On February 1, 2018, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,600,000. During 2018, costs of $2,200,000 were incurred with estimated costs of $4,200,000 yet to be incurred. Billings of $2,700,000 were sent, and cash collected was $2,450,000. In 2019, costs incurred were $2,700,000 with remaining costs estimated to be $3,900,000. 2019 billings were $2,950,000 and $2,675,000 cash was collected. The project was completed...
omework Saved Help Save & Exit Submit Check my work Exercise 5-19 Long-term contract; revenue recognition over time; loss projected on entire project [LO5-9] On February 1, 2018, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,180,000. During 2018, costs of $2,060,000 were incurred with estimated costs of $4,060,000 yet to be incurred. Billings of $2,560,000 were sent, and cash collected was $2,310,000. In 2019, costs incurred were $2,560,000 with remaining...
On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,240,000. During 2021, costs of $2,080,000 were incurred with estimated costs of $4,080,000 yet to be incurred. Billings of $2,580,000 were sent, and cash collected was $2.330,000. In 2022, costs incurred were $2,580,000 with remaining costs estimated to be $3,720,000. 2022 billings were $2.830,000 and $2,555,000 cash was collected. The project was completed in 2023 after additional costs of...
Exercise 6-21 (Algo) Long-term contract; revenue recognition over time; loss projected on entire project [LO6-9] On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,300,000. During 2021, costs of $2,100,000 were incurred with estimated costs of $4,100,000 yet to be incurred. Billings of $2,600,000 were sent, and cash collected was $2,350,000. In 2022, costs incurred were $2,600,000 with remaining costs estimated to be $3,750,000. 2022 billings were $2,850,000...
Please address and answers marked wrong and show steps as to
correctly solve the questions
On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,500,000. During 2021, costs of $2,200,000 were incurred, with estimated costs of $4,200,000 yet to be incurred. Billings of $2,740,000 were sent, and cash collected was $2,450,000. In 2022, costs incurred were $2,740,000 with remaining costs estimated to be $3,900,000. 2022 billings were $2,990,000,...
On February 1, 2018, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,450,000. During 2018, costs of $2,180,000 were incurred, with estimated costs of $4,180,000 yet to be incurred. Billings of $2,716,000 were sent, and cash collected was $2,430,000. In 2019, costs incurred were $2,716,000 with remaining costs estimated to be $3,870,000. 2019 billings were $2,966,000, and $2,655,000 cash was collected. The project was completed in 2020 after additional costs of...
On February 1, 2018, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,000,000. During 2018, costs of $2,000,000 were incurred, with estimated costs of $4,000,000 yet to be incurred. Billings of $2,500,000 were sent, and cash collected was $2,250,000. In 2019, costs incurred were $2,500,000 with remaining costs estimated to be $3,600,000. 2019 billings were $2,750,000, and $2,475,000 cash was collected. The project was completed in 2020 after additional costs of...
On February 1, 2018, Arrow Construction Company entered into a
three-year construction contract to build a bridge for a price of
$8,125,000. During 2018, costs of $2,050,000 were incurred, with
estimated costs of $4,050,000 yet to be incurred. Billings of
$2,560,000 were sent, and cash collected was $2,300,000. In 2019,
costs incurred were $2,560,000 with remaining costs estimated to be
$3,675,000. 2019 billings were $2,810,000, and $2,525,000 cash was
collected. The project was completed in 2020 after additional costs
of...
