Question

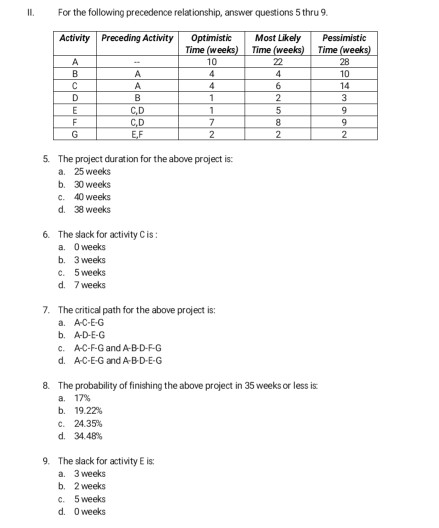

For the following precedence relationship, answer questions 5 thru 9. Activity Preceding Activity Optimistic Time (weeks) 10

Areas Under the One-Tailed Standard Normal Curve This table provides the area between the mean and some score For example, wh

0 0
Add a comment Improve this question Transcribed image text
Answer #1

First, we need to calculate the mean time for the activities. Following formula can be used to calculate the mean time

= (t +4, +) where. t = Mean Time to = Optimistic Time t = Most Likely Time t = Pessimistic Time

Activity Optimistic Time Most Likely time Pessimistic time Mean Time N CUI NON MOON N CONNU

The precedence relationship diagram is as follows:

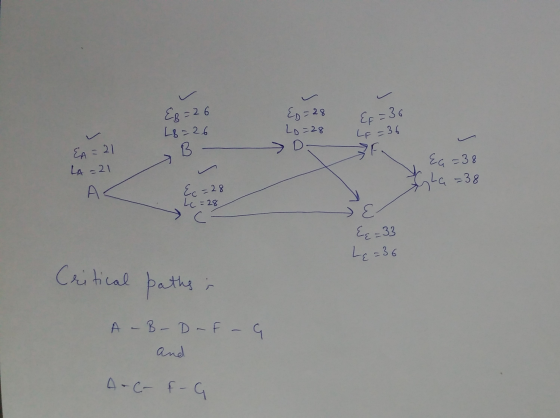

ED=28 Lo=28 EF=36 LE = 36 EA = 21 LA =21 B Dit Ea=38 pha=38 A = 28 tc=28 28 JE Eq=33 Lq=36 Critical paths is A - B - Daf - G

As per the network diagram:

5. The project duration for the above project is 38 weeks

6. The slack for activity C is 0 weeks because this activity comes on the critical path.

7. The critical path for the above projects are:

a) A-B-D-F-G

b) A-C-F-G

8. Following formula can be used to calculate the probability in less than 35 weeks

where,

Ts = Target Value

Te = Mean completion time

o = Standard Deviation

To calculate the standard deviation, first variance needs to be calculated for critical path.

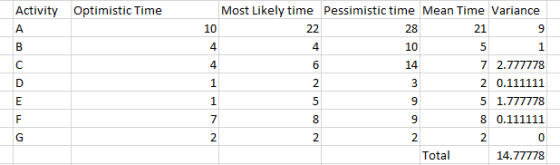

Activity Optimistic Time Most Likely time Pessimistic time Mean Time Variance NC UNAN NEW 7 2.777778 2 0.111111 5 1.777778 8

o = Sum of Critical path Variances o = 11.889 o=3.44

DZI.-I, 35-38 = Prob.{Z S-0.8720}=0.1916 o 3.44

Therefore, the probability of finishing the project in less than 35 weeks is 19.22 percent

9. By referring the precedence network diagram:

The slack for activity E is 36-33 = 3 weeks

Heyy! Please hit thumbs up. If you like the answer. Thanks
