Question

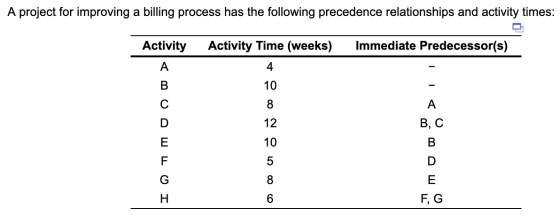

A project for improving a billing process has the following precedence relationships and activity times: Activity Activity Tib. Calculate the slack for each activity. Which activities are on the critical path? Activity Activity Time (weeks) On critic

1 0
Add a comment Improve this question Transcribed image text
Answer #1

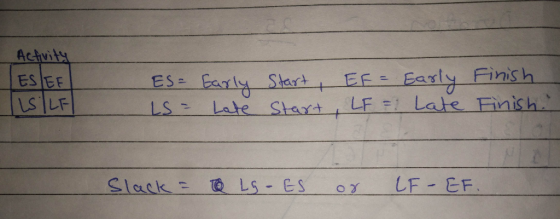

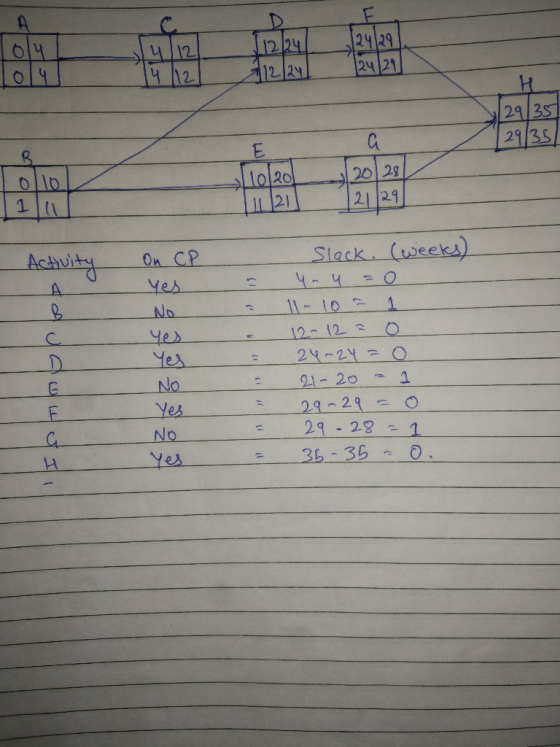

Activity ESEF ILSILEI ES= LS = Early Late Start, EF = Start , LF = Early Late Finish Finish. Slack = LG-ES or LF-EF.04 H y/29/35 729/35 10/20 111 211 /20/28 2129 Activity On CP Slack. (weeks) 4. 4 - 0 yes No Yes Yes t No 12-12 = 0 24-24 =

Do give a positive rating if you think this answer helped

Add a comment
Know the answer?
Add Answer to:
A project for improving a billing process has the following precedence relationships and activity times: Activity...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • Problem 3 A project for improving a billing process has the following precedence relationships and activity...

    Problem 3 A project for improving a billing process has the following precedence relationships and activity times: Activity Time (weeks) Activity Immediate Predecessor(s) A В 7 C 7 A В, С D 14 Е 10 5 D E Н F, G a. Choose the correct network diagram below. O A. O B. в O C. O D. S в Problem 3 Question Help O D. O C b. Calculate the slack for each activity. Which activities are on the critical...

  • Please help me find the critical path and the slack. I've been struggling on this for...

    Please help me find the critical path and the slack. I've been struggling on this for awhile Screen Shot 2020-04-20 at 3.45.19 PM Z o @ Q Search A project for improving a billing process has the following precedence relationships and activity times: Activity Activity Time (weeks) Immediate Predecessor(s) <MOOW LUI b. Calculate the slack for each activity. Which activities are on the critical path? Activity Activity Time (weeks) On critical path? Slack (weeks) Yes No Yes Yes | <mo...

  • project are listed for a In the following table the activities with their precedence sequence and...

    project are listed for a In the following table the activities with their precedence sequence and expected time (days) Immediate Predecessor(s) Time (days) Activity 7 A 2 A B 4 C 4 5 5 E C F 2 G E, F 3 H G, H a) The activities on the critical path are b) The project length is days.

  • The following activities of a hospital expansion project has been identified in the following table. First,...

    The following activities of a hospital expansion project has been identified in the following table. First, all activities of the project are listed. Next, the immediate predecessor(s) of each activity is identified (activity relationships). Please plot the activity network diagram and answer the following questions. Hospital Expansion Project Activity Description Immediate predecessor(s) Activity Time (Weeks) A Select administrative and medical staff - 12 B Select site and do site survey - 9 C Select equipment A 10 D Prepare final...

  • Problem 5-7 The following activities are part of a project to be scheduled using CPM: ACTIVITY...

    Problem 5-7 The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR TIME (WEEKS) А 7 B 6 2 3 B.D D b. What is the critical path? Оооо A-C-D-E-G A-B-D-F-G A-B-E-G O A-C-D-F-G c. How many weeks will it take to complete the project? Number of weeks d. How much slack does activity B have? Slack of activity B week(s)

  • The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR...

    The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR TIME (WEEKS) A — 3 B A 9 C A 5 D C 2 E B D 7 F D 6 G E F 4 b. What is the critical path? A-B-D-F-G A-B-E-G A-C-D-F-G A-C-D-E-G c. How many weeks will it take to complete the project? Number of weeks             d. How much slack does activity B have? Slack of activity B             week(s)

  • Question 24 (20 points) Use the following table of related activities with their activity times (weeks). Q24-1) Type your answers by the order of ES, EL, LS, LF, Slack for each activity. For ex...

    Question 24 (20 points) Use the following table of related activities with their activity times (weeks). Q24-1) Type your answers by the order of ES, EL, LS, LF, Slack for each activity. For example, A. Х, Х, Х, Х, Х Q24-2) Determine the critical path. Immediate Activity Activity Predecessor Time ESEFLSLqslack (weeks 4 C A DIB E A FIB G C,D H |D,F 7 6 5 4 6 G, H, I J Question 24 (20 points) Use the following table...

  • also needs daves latest start and latest finish: Dave Fletcher was able to determine the activity...

    also needs daves latest start and latest finish: Dave Fletcher was able to determine the activity times for constructing his laser scanning machine. Fletcher would like to determine ES, EF, LS, LF, and slack for e activity. The total project completion time and the critical path should also be determined. Here are the activity times: Activity Time (weeks) Immediate Predecessor(s) Activity Time (weeks) Immediate Predecessor(s) C, E D, F Dave's earliest start (ES) and earliest finish (EF) are: Activity ES...

  • Problem 5-7 The following activities are part of a project to be scheduled using CPM: ACTIVITY...

    Problem 5-7 The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR TIME (WEEKS) A — 7 B A 6 C A 2 D C 4 E B D 3 F D 4 G E F 6 b. What is the critical path? A-B-D-F-G A-C-D-E-G A-C-D-F-G A-B-E-G c. How many weeks will it take to complete the project? Number of weeks             d. How much slack does activity B have? Slack of activity B             week(s)

  • In the following table the activities with their precedence sequence and expected time (days) are listed...

    In the following table the activities with their precedence sequence and expected time (days) are listed for a project: Activity Immediate Predecessor(s) Time (days) - ITMO OWNono Ana E, F D GH a) The activities on the critical path are b) The project length is days. A-B-E-G-1 A-B-D-H-1 A-C-F-G-

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
