Question

Problem 3 A project for improving a billing process has the following precedence relationships and activity times: Activity TProblem 3 Question Help O D. O C b. Calculate the slack for each activity. Which activities are on the critical path? On crit

0 0
Add a comment Improve this question Transcribed image text
Answer #1

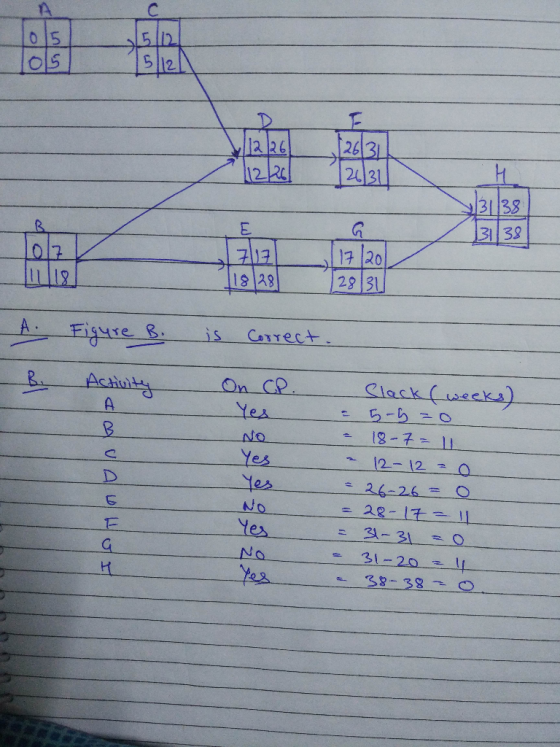

nisl A. Figure B. is correct. Activity On CP. Yes No lentop Slack (weeks) = 5 -5 - o - 18 -7 = 1 - 12-12 = 0 = 26-26= 0 = 28-

Do give a positive rating if you think this answer helped

Add a comment
Know the answer?
Add Answer to:
Problem 3 A project for improving a billing process has the following precedence relationships and activity...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • A project for improving a billing process has the following precedence relationships and activity times: Activity...

    A project for improving a billing process has the following precedence relationships and activity times: Activity Activity Time (weeks) Immediate Predecessor(s) B, C I Q7 Moow E F, G b. Calculate the slack for each activity. Which activities are on the critical path? Activity Activity Time (weeks) On critical path? Yes Slack (weeks) D 0 Yes 0 0 00000000 @ Tm I

  • Please help me find the critical path and the slack. I've been struggling on this for...

    Please help me find the critical path and the slack. I've been struggling on this for awhile Screen Shot 2020-04-20 at 3.45.19 PM Z o @ Q Search A project for improving a billing process has the following precedence relationships and activity times: Activity Activity Time (weeks) Immediate Predecessor(s) <MOOW LUI b. Calculate the slack for each activity. Which activities are on the critical path? Activity Activity Time (weeks) On critical path? Slack (weeks) Yes No Yes Yes | <mo...

  • Problem 5-7 The following activities are part of a project to be scheduled using CPM: ACTIVITY...

    Problem 5-7 The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR TIME (WEEKS) А 7 B 6 2 3 B.D D b. What is the critical path? Оооо A-C-D-E-G A-B-D-F-G A-B-E-G O A-C-D-F-G c. How many weeks will it take to complete the project? Number of weeks d. How much slack does activity B have? Slack of activity B week(s)

  • QUESTION 14 A firm is planning a project for the development of a new product. The network of activities and data are s...

    QUESTION 14 A firm is planning a project for the development of a new product. The network of activities and data are shown follow. Time Immediate Activity (weeks) Predecessor 2 5 В 4 C 5 В 6 В.С D,E F What are the slack times of Activities D and E? 0 and 0, respectively 1 and 1, respectively 2 and 0, respectively 0 and 1, respectively 1 and 0, respectively shown follow. A firm is planning a project for the...

  • Problem 5-7 The following activities are part of a project to be scheduled using CPM: ACTIVITY...

    Problem 5-7 The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR TIME (WEEKS) A — 7 B A 6 C A 2 D C 4 E B D 3 F D 4 G E F 6 b. What is the critical path? A-B-D-F-G A-C-D-E-G A-C-D-F-G A-B-E-G c. How many weeks will it take to complete the project? Number of weeks             d. How much slack does activity B have? Slack of activity B             week(s)

  • The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR...

    The following activities are part of a project to be scheduled using CPM: ACTIVITY IMMEDIATE PREDECESSOR TIME (WEEKS) A — 3 B A 9 C A 5 D C 2 E B D 7 F D 6 G E F 4 b. What is the critical path? A-B-D-F-G A-B-E-G A-C-D-F-G A-C-D-E-G c. How many weeks will it take to complete the project? Number of weeks             d. How much slack does activity B have? Slack of activity B             week(s)

  • Ross​ Hopkins, president of Hopkins​ Hospitality, has developed the​ tasks, durations, and predecessor relationships in the...

    Ross​ Hopkins, president of Hopkins​ Hospitality, has developed the​ tasks, durations, and predecessor relationships in the following table for building new motels.                                                                                                                                                             Time ​(weeks​) Immediate Time ​(weeks​) Immediate Activity a m b ​Predecessor(s) Activity a m b ​Predecessor(s) A 6 8 10 — G 3 3 5 ​C, E B 2 9 23 A H 1 1 1 F C 8 12 18 A I 7 7 7 F D 4 7 10 A J 4 7 14 ​D, G,...

  • The following represent activities in Marc Massoud's Construction Company project: Activity Immediate Predecessor(s) Time (weeks) Activity...

    The following represent activities in Marc Massoud's Construction Company project: Activity Immediate Predecessor(s) Time (weeks) Activity Immediate Predecessor(s) Time (weeks) = C, E WLUI WNVN = n a a) Choose the correct network to represent this situation. OA. OB b) The critical path is B-E-F-H c) The length of the critical path is . weeks.

  • project are listed for a In the following table the activities with their precedence sequence and...

    project are listed for a In the following table the activities with their precedence sequence and expected time (days) Immediate Predecessor(s) Time (days) Activity 7 A 2 A B 4 C 4 5 5 E C F 2 G E, F 3 H G, H a) The activities on the critical path are b) The project length is days.

  • A Question 11 The following table provides a list of activities in a project, along with...

    A Question 11 The following table provides a list of activities in a project, along with their respective durations and precedence requirements: Immediate Duration Activity Predecessor(s) (weeks) 2 B 3 C B D А E A.C 1 F DE 3 с 3 2 6 G Determine the amount of slack time for Activity E: a. O weeks b. 1 week C. 2 weeks O d. 3 weeks Question 12 Assume that activity A has the following times: Early start time...
