Question

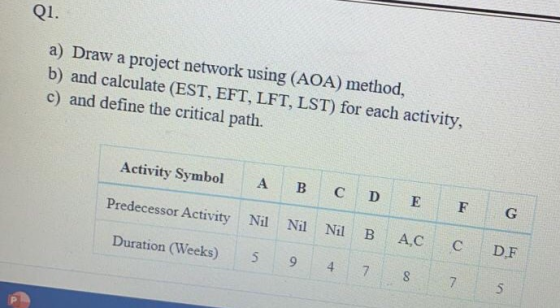

Q1. a) Draw a project network using (AOA) method, b) and calculate (EST, EFT, LFT, LST) for each activity, c) and define the
0 0
Add a comment Improve this question Transcribed image text
Answer #1

From given data of activity and its duration, AOA (Activity On Aerrow) network is drawn as shown below.

m A/co 0 G A → 3 5 5

EFT = EST + Duration

LST = LFT - Duration

Total Float= LFT - EFT

Activity Duration EST EFT LST LFT Total Float Comment
A 5 0 5 8 13 8
B 9 0 9 0 9 0 Critical
C 4 0 4 5 9 5
D 7 9 16 9 16 0 Critical
E 8 5 13 13 21 8
F 7 4 11 9 16 5
G 5 16 21 16 21 0 Critical

here in activity B, D and G total float is zero thus these are critical activities.

Critical path is B-D-G and the critical duration of the project is 9+7+5= 21 days.
