Question

Draw an activity on the arrow network for the activities of a project as shown in...

Draw an activity on the arrow network for the activities of a project as shown in table, indicate the critical path and calculate the total float

Activity description immediate predecessor Expected time (Weeks)
A - 5
B - 4
C A 7
D B 7
E B 8
F B 5
G C,D 8
H E,I 11
I F 2
J F 12
K H,I 11

2.convert the above into activity on the node

0 0
Add a comment Improve this question Transcribed image text
Answer #1

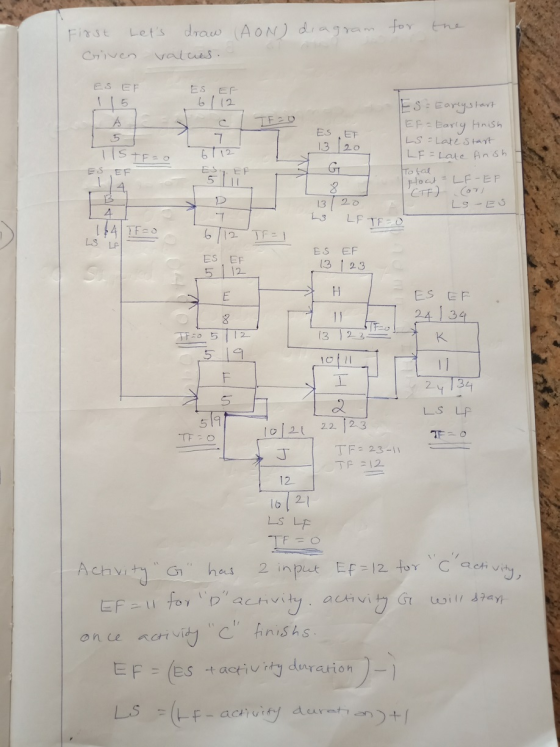

First Lets the draw (AON) diagram for values. ES EF 1 ES EF If=o А 5 с 7 6112 ES 13 20 T 15+F=0 Es Earlystart EF= Early finiCritical path is B-E-H-K project completion days = 34 (weeks) Activity Total float A B С D F Orto O O O doo

Add a comment
Know the answer?
Add Answer to:
Draw an activity on the arrow network for the activities of a project as shown in...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • The following represent activities in Marc Massoud's Construction Company project: Activity Immediate Predecessor(s) Time (weeks) Activity...

    The following represent activities in Marc Massoud's Construction Company project: Activity Immediate Predecessor(s) Time (weeks) Activity Immediate Predecessor(s) Time (weeks) = C, E WLUI WNVN = n a a) Choose the correct network to represent this situation. OA. OB b) The critical path is B-E-F-H c) The length of the critical path is . weeks.

  • Consider the following network for a small maintenance project (all times are in days). [7 Marks]...

    Consider the following network for a small maintenance project (all times are in days). [7 Marks] Activity Immediate Predecessor [s] Optimistic Time Most Likely Time Pessimistic Time A - 2 3 4              B - 5 6 7 C - 5 6 7 D A 3 4 5 E A 2 3 4 F C 3 4 5 G C 8 10 16 H B, E, F 5 6 7 I B, E, F 7 11 15 J B, E,...

  • 1. Consider the following project. Activity Duration (weeks)5 Immediate Predecessor(s) Cost (S) 1000 | 400 I 20...

    1. Consider the following project. Activity Duration (weeks)5 Immediate Predecessor(s) Cost (S) 1000 | 400 I 200 | 1200 | 500 | 700 | 1200 | 800 | 1800 | 1500 | 400 (a) Construct the activity-on-node (AoN) network for the relations among the activities in the (b) Using the activity-on-node (Ao) network developed in part (a), determine the critical path and the minimum time required to complete the project. Develop the earliest start and finish times, the latest finish...

  • 1. The activities needed for a new project your company is undertaking are listed in the...

    1. The activities needed for a new project your company is undertaking are listed in the following table. ACTIVITY IMMEDIATE PREDECESSOR(S) A ---- B ---- C A D A, B E B F C, D, E G D, E H F I F, G J G The activity times were determined for the project, and were as below. ACTIVITY ACTIVITY TIME (days) A 11 B 9 C 7 D 12 E 8 F 9 G 10 H 6 I 7...

  • Using the following information about Project A, its activities and predecessor activities below: Activity Predecessors A...

    Using the following information about Project A, its activities and predecessor activities below: Activity Predecessors A в B C D E, F D G The following table contains the pessimistic, likely, and optimistic estimates for how long activities are estimated to take for Project A. Activity Pessimistic Likely Optimistic 2 5 20 H 16 e. Calculate the time estimates (TE) f. Calculate the variance (s) g. Convert the TE to whole integers and place them in the network diagram for...

  • QUESTION 14 A firm is planning a project for the development of a new product. The network of activities and data are s...

    QUESTION 14 A firm is planning a project for the development of a new product. The network of activities and data are shown follow. Time Immediate Activity (weeks) Predecessor 2 5 В 4 C 5 В 6 В.С D,E F What are the slack times of Activities D and E? 0 and 0, respectively 1 and 1, respectively 2 and 0, respectively 0 and 1, respectively 1 and 0, respectively shown follow. A firm is planning a project for the...

  • Q1.      (10 marks) Construct an activity on arrow network based on the activity descriptions below. Show...

    Q1.      (10 marks) Construct an activity on arrow network based on the activity descriptions below. Show all your work. Label activities in the network by their activity letters and node numbers. Remove any redundant dependencies and label dummy activities DUMMY1, DUMMY2, etc. • Activities H, R2, T1 start the project. • Activity T2 can start when Activities H, E1 and S are completed. • Activity E1 also depends on Activity R2. • Activity X follows Activity H and precedes Activity...

  • Consider the following project activities: Calculate the expected time (te) for each activity. Draw an Activity...

    Consider the following project activities: Calculate the expected time (te) for each activity. Draw an Activity on Node (AON) diagram to reflect the flow of these activities. Calculate the Early Start (ES), Early Finish (EF), Late Start (LS), and Late Finish (LF) for each activity. Calculate the slack for each activity. Identify all activities on the Critical Path. Use the data to calculate the probability the project will finish in 20 weeks (Hint: z-score). Activity A 8 с D E...

  • A project has the following set of activities Activity Immediate Predecessor Duration (weeks) A - 8...

    A project has the following set of activities Activity Immediate Predecessor Duration (weeks) A - 8 B - 10 C A 3 D A 7 E B, C 6 F B, C 7 G D, E 5 H F 3 Draw the AON diagram Identify all the possible paths What is the critical path? Can activity B be delayed without delaying the completion of the project? If so, by how many days?

  • The following activities of a hospital expansion project has been identified in the following table. First,...

    The following activities of a hospital expansion project has been identified in the following table. First, all activities of the project are listed. Next, the immediate predecessor(s) of each activity is identified (activity relationships). Please plot the activity network diagram and answer the following questions. Hospital Expansion Project Activity Description Immediate predecessor(s) Activity Time (Weeks) A Select administrative and medical staff - 12 B Select site and do site survey - 9 C Select equipment A 10 D Prepare final...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
