Question

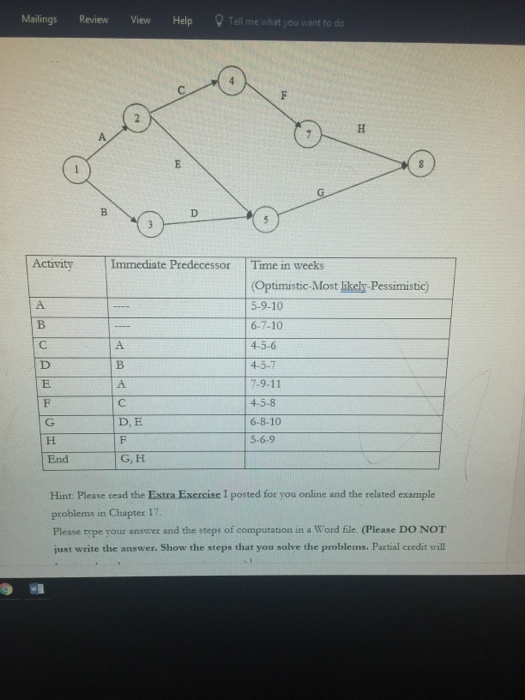

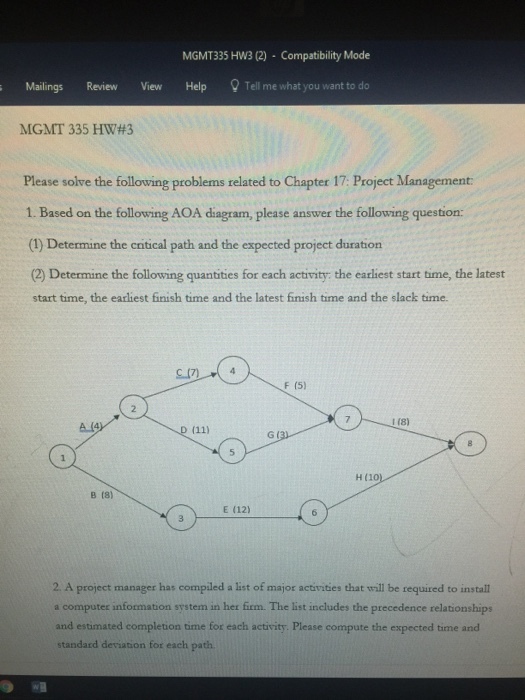

MGMT335 HW3 (2) Compatibility Mode Mailings Review View Help Tell me what you want to do MGMT 335 HW#3 Please solve the folloving problems related to Chapter 17: Project Management 1. Based on the following AOA diagram, please answer the following question: (1) Determine the cntical path and the expected project duration (2) Determine the following quantities for each activity: the earliest start time, the latest start time, the earliest finish time and the latest finish time and the slack time. F (5) 1 (8) G ( B (8) E (12) 2 A project manager has compiled a list of major activities that will be required to install a computer information system in her firm. The list includes the precedence relationships and estimated completion time for each activity. Please compute the expected time and standard deviation for each path
media%2Fb81%2Fb81cfc9b-0a9b-4c63-aecd-1f
0 0
Add a comment Improve this question Transcribed image text
Answer #1

Different paths are as below: A-C-F-l-4+7+5+8-24 A-D-G-4+11+3+8 -26 B-E-H -8+12+10 30 4 10 17 s) 26 0 4 n 15 15 G ( 19 19 22

Activity

Duration

EST

LST

EFT

LFT

SLACK

A

4

0

4

4

8

4

B

8

0

8

0

8

0

C

7

4

11

10

17

7

D

11

4

15

8

19

11

E

12

8

20

8

20

0

F

5

11

16

17

22

5

G

3

15

18

19

22

3

H

10

20

30

20

30

0

I

8

18

26

22

30

8

Answer 2:-

Activity Optimistic Most Probable Pessimistic Expected completion time Expected compleetion time Standard deviation
A 5 9 10 (5+4*9+105)/6 8.50 0.83
B 6 7 10 (6+4*7+10)/6 7.33 0.67
C 4 5 6 (4+4*5+6)/6 5.00 0.33
D 4 5 7 (4+4*5+7)/6 5.17 0.50
E 7 9 11 (7+4*9+11)/6 9.00 0.67
F 4 5 8 (4+4*5+8)/6 5.33 0.67
G 6 8 10 (6+4*8+10)/6 8.00 0.67
I 5 6 9 (5+4*6+9)/6 6.33 0.67
Formula for Expected completion time = (O+4M+P)/6
Std.Deviation = ((P-O)/6)

PLEASE RATE THE ANSWER AS THUMBS UP. THANKS A LOT.

Add a comment
Know the answer?
Add Answer to:
MGMT335 HW3 (2) Compatibility Mode Mailings Review View Help Tell me what you want to do...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • Please solve the following problems related to Chapter 17: Project Management: 1. Based on the following...

    Please solve the following problems related to Chapter 17: Project Management: 1. Based on the following AOA diagram, please answer the following question: (1) Determine the critical path and the expected project duration (2) Determine the following quantities for each activity: the earliest start time, the latest start time, the earliest finish time and the latest finish time and the slack time. C17) F (5) 1 (61 A(4) D (11) G (3) H(101 B (10) E (12)

  • Consider a project having the following six activities:

    Consider a project having the following six activities:                                                      Immediate                                                  Max        Crash cost             Activity                           Predecessors           Time (weeks)             Crash*    per week                   A                                none                                    6                          6                N/A                   B                                none                                    5                          2               $500                   C                                A                                       3                          2             $1000                   D                                A, B                                    4                          2             $2000                   E                                 C, D                                    5                          2             $1250                   F                                D                                       6                          2             $1000                                                                                                 *Shortest possible time for the task 1. Draw the project network and list...

  • Consider a project having the following six activities:

    Consider a project having the following six activities:                                                      Immediate                                                  Max            Crash cost             Activity                           Predecessors          Time (weeks)             Crash*    per week                   A                                none                                    7                          7         N/A                   B                                none                                    3                          2        $500                   C                                A                                       5                          3      $1000                   D                                A, B                                    6                          4      $2000                   E                                 C, D                                    4                          3      $1250                   F                                D                                       3                          2      $1000                                                                                                 *Shortest possible time for the task 1. Draw the project network and list...

  • Provide step by step please thank you, no exce Assume you have a project with ten...

    Provide step by step please thank you, no exce Assume you have a project with ten activities labeled A-J, as shown. Derive the earliest completion time (or early finish-EF), latest completion time (or late finish-LF), and slack for each of the following tasks (begin at time 0) the critical path on your network diagram. . Which tasks are on the critical path? Highligh Preceding Expected Critical Path? Activity Event Duration EF LF Slack A, D C,E D, E F, G...

  • 622 HW 4 MC Simulation-190212 (1) -Compatibility Mode Mailings Review View Help Tell me what you...

    622 HW 4 MC Simulation-190212 (1) -Compatibility Mode Mailings Review View Help Tell me what you want to do 1 Normal Heading 1 ieSubtitle Emphasis Strong List Par Static MC Project Cost Simulation: Consider the Project described that was characterized by the following activity edge table in which two people were required to complete each task (each working 8 hours a day). Activity Nodes Labor Cost (S/h) Min Max Likely S 10 S 150 S 120 S 100 $ 150...

  • 1. State whether each of the following statement is true or false. a) The sequence of...

    1. State whether each of the following statement is true or false. a) The sequence of activities in a project is depicted by the precedence (0.5 mark) (0.5 mark) relationships. The critical path is the shortest path through the project network. Slack is the amount of time an activity can be delayed without delaying the project. In PERT, three time estimates (optimistic, most likely and pessimistic) provide an estimate of the mean and variance for each activity based on the...

  • What is the critical path? Start-A-D-G-End O Start-A-D-F-End Start-A-E-G-End O Start-B-E-G-End What is the EF (earliest...

    What is the critical path? Start-A-D-G-End O Start-A-D-F-End Start-A-E-G-End O Start-B-E-G-End What is the EF (earliest finish) of activity E? o o ООООО < N N What is the LS (latest start) of activity E? ООООО The list of activities, their times (in weeks), and precedence relationships for a new project are given below. Activity Immediate Predecessor Activity Time A L - L 4 B - 1 2 C - A, B F DL 4 G C, D, E What...

  • The ABC Manufacturing Co. has made a decision to replace an existing production line with new...

    The ABC Manufacturing Co. has made a decision to replace an existing production line with new equipment. This project will require several tasks (jobs) with precedence relationships and duration (days) as shown in the following table. The project will be finished when activities A-J are all finished. Activity predecessor Optimistic Most likely Pessimistic Expected A - 4 5 12 B A 3 4.5 15 C A 2 3 4 D C 6 8 22 E B 4 6 8 F...

  • Review Test Submission7 Compatibility Mode A hetham al-mehmadi Mailings Review View Help Tell me what you...

    Review Test Submission7 Compatibility Mode A hetham al-mehmadi Mailings Review View Help Tell me what you want to do Share The concept of urban and suburban areas where there is a higher probability of increased income. occurred because physicians prefer to practice in physician maximization C geographic maldistribution C incentives and profit maximization C None of the answers are correct. Licensed vocation nurses/licensed practical nurses responsibilities include patient observation, takes vital signs, keeps records, assists patients with personal hygiene, feeding...

  • Statistics Exam 2 (1) Compatibility Mode out References Mailings Review View Help Tell me what you...

    Statistics Exam 2 (1) Compatibility Mode out References Mailings Review View Help Tell me what you want to do -- E- -B.11Normal No Spac-Heading 1 Heading 2 Title Subtitle Paragraph Styles Show your work 10pts Independent t-test A biopsxchologist studies the role of the brain chemical serotonin in aggression. One sample of rats serves as a control group and receives a placebo. A second sample of rats receive a drug that lowers brain levels of serotonin. The researcher tests the...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
