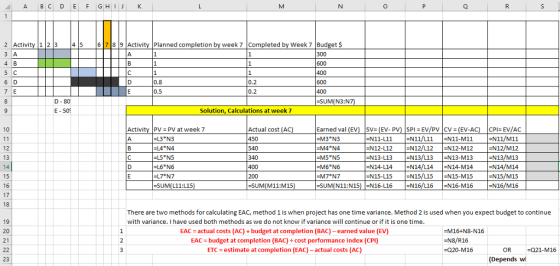

For the following table assume we are at the end of week 7, find the cost...
14. The following project is at the end of its sixth week. Find the cost and schedule variances. Also find the CPI. SPI ETC, and EAC for the project. Duration Budget, Actual Cost, $ 400 180 decessors (weeks) Complete 100 100 100 20 20 250 600 400 200
please answer in details, thank you
The Project below is currently at the end of Week 6. Use the table below to find the PV, EV, CPI, SPI, and CSI. Use the % Complete column where applicable for these calculations. What conclusions can you make on the project given your calculated CPI, SPI, and CSI values? Activity Predecessors Duration (weeks) Budget, $ $350 $550 $250 $400 $450 $600 Actual Cost, $ $400 $550 $200 $300 $150 А % Complete 100%...
PLEASE SHOW ALL CALCULATIONS. PLEASE DRAW A NETWORK DIAGRAM AS WELL. The following project is at the end of its 6th week. Find the cost and schedule variances. Also find the CPI and SPI. Then find the critical ratio of the project using earned value calculations. Finally, calculate the EAC for the project by at least two different methods. Activity Predecessor Duration (wks) Budget ($) Actual Cost ($) %Complete a - 2 600 400 100 b - 3 150 180...
#1. A project in its 26th week has an actual cost of $270,000. It was scheduled to have spent $261,000. For the work performed to date, the budgeted value is $272,000. What are the cost and schedule variances for the project? What are the SPI and CPI? What is your assessment of the project from a cost and schedule perspective? #2. A project has just completed the 87th item in its plan. It was scheduled to have spent $168,000 at...
8. For the following test marketing project at week 6: (a) Ignore the far right .% Complete" column and using the 50-50 percent completion rule for PV and EV calculate the cost, schedule, and time variances. Also calculate the CPI, SPI, CSI, and the ETC and EAC (b) Repeat the calculations in a, but now using the ..% Complete" column. Assume that the PV values are based on time propo values for EV are from the workers actually doing the...
At week 10 of a project below to improve distance learning platform, assume that the planned values (PV) are based on time proportionality but the “% Complete” values for earned values (EV) are from the workers actually doing the tasks. ACTIVITY PRE- DECESSORS DURATION (WEEKS) BUDGET ($) ACTUAL COST ($) % COMPLETE A - 5 500 640 100 B A 3 300 400 100 C B 4 320 310 80 D B 6 600 250 60 E C,D 3 300...
Question 1: The following data and table illustrate a small project: Activity A was completed on schedule • Activity B started as planned but it is expected to take four weeks more Activity C started as planned but finished one week later • %age of completion of activity D is 60% ACWP at the end of week 10 = SR 90400 Activity Original Planned Start Time Original Planned Finish Time Wage Complete Amount Completed BCWP Amount Scheduled BCWS Amount Spent...
Earned value calculation Based on the following Project data, answer the questions a and b. Activity Duration Predecessors Task Budget A 7 days -- $16,850 B 10 days -- $22,500 C 8 days B $16,000 D 10 days A $12,790 E 7 days B $8,500 F 4 days D $10,550 At the end of Day 10, the status of the project is as follows. Activity % Complete Actual Cost A 100% $18,000 B 100% $23,000 C 0% $0 D 10%...
Use a PERT network to establish the expected duration for the project described in the table below: (SHOW the PERT NETWORK) Activity Predecessors Duration a m b Exp. Duration Var. Crash Week 1 Crash Week 2 A - 3 6 9 700 100 B A 6 7 14 600 200 C A 4 6 14 400 600 D B, C 4 6 8 200 600 E B, C 6 9 12 400 300 F C 4 6 14...
Project ABC Scope = 10 chairs @ $10.00 = $100.00 PV = Timeframe = 10 days AC = At the End of the 5th day 4 chairs were EV = Completed at a cost of $11.00 each CV = CPI= SV = SPI= CR = To install a 10,000 feet fence at a cost of $10.00/per foot. It is estimated that 500 feet of fence can be installed per week for a total of 20 weeks. After 12 weeks and...
