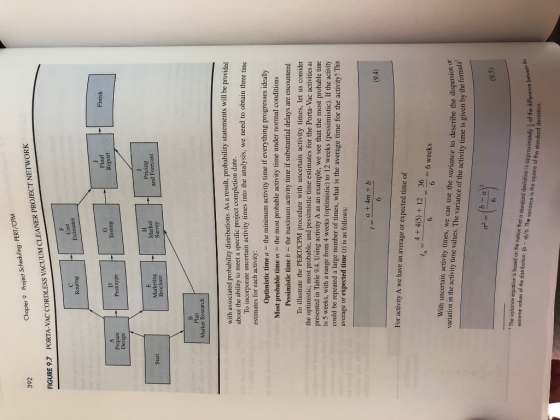

Here are the figures from the book stated in the question to follow:Project Scheduling: PERT/CPM Chapter 9 392 CORDLESS VACUUM CLEANER PROJECT NETWORK FIGURE 9.7 PORTA-VAC Es Routing Finish Fin9.2 Project Scheduling Considering Uncertain Activity PROJECT SCHEDULING CONSIDERING UNCERTAIN 9.2 ACTIVITY TIMES In this sec

0 0
Add a comment Improve this question Transcribed image text
Answer #1

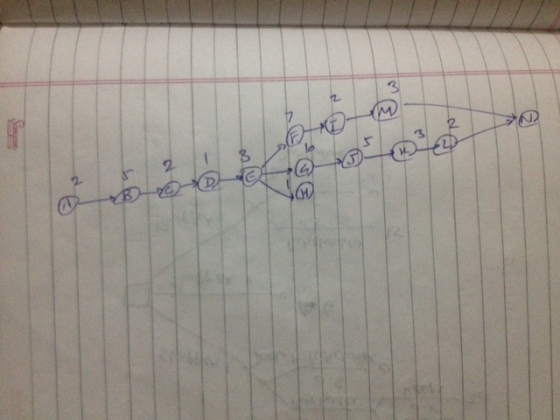

Home renovation project

Activity Description Predecessor activity Duration ( Days)
A Analysis of tasks to be accomplished None 2
B Looking out for options among professional renovation companies A 5
C Select the partners ( Contractors) B 2
D Preparation of budget with the contracting parties C 1
E Removal of old paint, furniture, carpet, kitchen accessories etc D 3
F Completion of construction work of Kitchen E 7
G Completion of construction work of Living room E 10
H Procurement of new accessories, furniture and appliances E 1
I Fitment of kitchen accessories F 2
J Painting, wallwork and interior decoration of the living room G 5
K Installation of new carpet in the living room J 3
L Finishing living room with new furniture K 2
M Complete plumbing work of the kitchen I 3
N Formal inspection and completion of work M,L 1

3
