PLEASE SOLVE FOR ALL :) determine ES, EF, LS, LF, and slack for each Dave Fletcher...
also needs daves latest start and latest finish:
Dave Fletcher was able to determine the activity times for constructing his laser scanning machine. Fletcher would like to determine ES, EF, LS, LF, and slack for e activity. The total project completion time and the critical path should also be determined. Here are the activity times: Activity Time (weeks) Immediate Predecessor(s) Activity Time (weeks) Immediate Predecessor(s) C, E D, F Dave's earliest start (ES) and earliest finish (EF) are: Activity ES...
Dave Fletcher was able to determine the activity times for constructing his laser scanning machine. Fletcher would like to determine ES, EF, LS, LF, and slack for each activity. The total project completion time and the critical path should also be determined. Here are the activity times: Time Activity (weeks) А 7 Immediate Predecessor(s) Time Activity (weeks) E 3 F 7 G 11 H 8 Immediate Predecessor(s) B B CE D. B с D 2 3 A A Dave's earliest...
I need Activity A-H

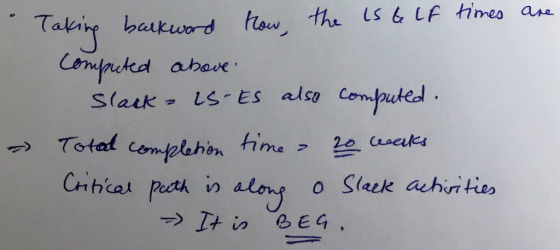

Myo Dave Fletcher was able to determine the activity times for constructing his laser scanning machine. Fletcher would like to determine ES, EF, LS, LF, and slack for each activity. The total project completion time and the critical path should also be determined. Here are the activity times: Time Immediate TimeImmediate Activity (weeks) Predecessorís) Activity (weeks) Predecessors) G 10 C, E D. F Dae'sarlest start (ES) and eariest fnish (EF) are
Based on the following table, calculate the ES, EF, LS, LF and Slack for each activity using an expected completion time of 16 weeks. Please use the table format presented in the text to solve this problem. Please create one table with the original plan and a second table with the updates based on actual performance. What is the critical path for the original project? If the critical path changes as a result of actual progress, identify the new critical...
Question 24 (20 points) Use the following table of related activities with their activity times (weeks). Q24-1) Type your answers by the order of ES, EL, LS, LF, Slack for each activity. For example, A. Х, Х, Х, Х, Х Q24-2) Determine the critical path. Immediate Activity Activity Predecessor Time ESEFLSLqslack (weeks 4 C A DIB E A FIB G C,D H |D,F 7 6 5 4 6 G, H, I J
Question 24 (20 points) Use the following table...
Question 5 For the project depicted below, a) Compute the ES, EF, LS, and LF times for the network. b) Explain how the ES for Activity 3 is obtained. c) Explain how the LF time for Activity 1 is obtained. d) What is the critical path for the project? e) How long do you expect the project to take to complete? Activity 4 Activity 2 ES= EF= wks LSELF ES= EF T=5 wks LSELF= Activity 1 ES= EF= T=6 wks...
The ABC Manufacturing Co. has made a decision to replace an existing production line with new equipment. This project will require several tasks (jobs) with precedence relationships and duration (days) as shown in the following table. The project will be finished when activities A-J are all finished. Activity predecessor Optimistic Most likely Pessimistic Expected A - 4 5 12 B A 3 4.5 15 C A 2 3 4 D C 6 8 22 E B 4 6 8 F...
Consider a project having the following six activities: Immediate Max Crash cost Activity Predecessors Time (weeks) Crash* per week A none 6 6 N/A B none 5 2 $500 C A 3 2 $1000 D A, B 4 2 $2000 E C, D 5 2 $1250 F D 6 2 $1000 *Shortest possible time for the task 1. Draw the project network and list...
(3) Determine the critical path and critical time of the network
shown below. Use the critical path method (the table of ES, EF,
etc.).
(3) Determine the critical path and critical time of the network shown below. Use the critical path method (the table of ES, EF, etc.). po Problem . Example a 100 For all starting activities, ES is taken as 0. Activities 1-2, 1-3 gets ES of O. Find EF-ES +time. Activity Time ES E F LS L...
Consider a project having the following six activities: Immediate Max Crash cost Activity Predecessors Time (weeks) Crash* per week A none 7 7 N/A B none 3 2 $500 C A 5 3 $1000 D A, B 6 4 $2000 E C, D 4 3 $1250 F D 3 2 $1000 *Shortest possible time for the task 1. Draw the project network and list...
