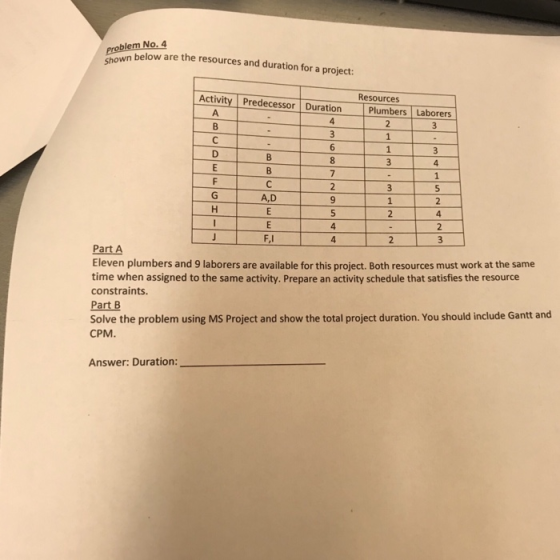

Question

o. 4 below are the resources and duration for a project Resources Activity Predecessor Duration Plumbers Laborers A,D 9 4 F,I Eleven plumbers and 9 laborers are available for this project. Both resources must work at the same time when assigned to the same activity. Prepare an activity schedule that satisfies the resource constraints. Part B Solve the problem using MS Project and show the total project duration. You should include Gantt and CPM Answer: Duration:
0 0
Add a comment Improve this question Transcribed image text
Know the answer?
Add Answer to:
o. 4 below are the resources and duration for a project Resources Activity Predecessor Duration Plumbers...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • 1. Using Microsoft Excel prepare a Gantt Chart for the following project. Predecessor(s) Duration (Days) Activity...

    1. Using Microsoft Excel prepare a Gantt Chart for the following project. Predecessor(s) Duration (Days) Activity 1. Forming the problem statement 2. Identifying functional requirements 3. Identifying constraints and limitations 4. Defining a schedule 5. Defining the design parameters 6. Identifying alternatives 7. Evaluating and analyzing alternatives 8. Select a solution 9. Gather supplies 10. Construct prototype 11. Test performance 12. Redesign 13. Demonstrate solution to class 2,3 2 8 10 11 12

  • From this schedule of activities: Activity Immediate Predecessor Activity Time A --- 4 B A 2...

    From this schedule of activities: Activity Immediate Predecessor Activity Time A --- 4 B A 2 C B 3 D B 5 E A 1 F C, D 3 G E, F 2 a. Draw the PERT/CPM network b. Complete the forward and backward pass c. Determine the critical path d. Determine the total duration of the project.

  • 3- Tables below show activities of a small project, predecessors, duration time, and resources that are...

    3- Tables below show activities of a small project, predecessors, duration time, and resources that are required (machines and workers). There are 3 machines and 4 workers available each day. Please use resource allocation algorithm to optimally allocate the recourses to the activities. Please specifies the project completion time. Table 1: Activities, predecessors and duration time. Activity Predecessor Duration A - 2 B B 2 C A,B 1 D C,D 2 E D 3 Table 2: Activities and their required...

  • 3- Tables below show activities of a small project, predecessors, duration time, and resources that are...

    3- Tables below show activities of a small project, predecessors, duration time, and resources that are required (machines and workers). There are 3 machines and 4 workers available each day. Please use resource allocation algorithm to optimally allocate the recourses to the activities. Please specifies the project completion time. Table 1: Activities, predecessors and duration time. Predecessor Duration 2 Activity A B с D 2 1 B AB C.D D 2 E 3 Table 2: Activities and their required number...

  • Given the following activities and precedents, draw a PERT/CPM diagram. ACTIVITY IMMEDIATE PREDECESSOR DURATION (DAYS) A...

    Given the following activities and precedents, draw a PERT/CPM diagram. ACTIVITY IMMEDIATE PREDECESSOR DURATION (DAYS) A - 10 B - 12 C A 4 D A, B 8 E A, B 9 F C 10 G D, F 12 H E, G 15 Answer the following: What is the critical path? How long will it take to complete this project? Can activity E be delayed without delaying the completion of the project? If so, how many days?

  • Consider a project with the following information: Activity Duration Predecessors A 5 -- B 7 A...

    Consider a project with the following information: Activity Duration Predecessors A 5 -- B 7 A C 9 B D 5 B E 7 C, D F 6 D G 4 C H 7 E, F, G Activity Duration ES EF LS LF Float A 5 0 5 0 5 B 7 5 12 5 12 C 9 12 21 12 21 D 5 12 17 16 21 E 7 21 28 21 28 F 6 17 23 22 28...

  • Part 2 Remember the old saying, “A project plan is not a schedule until resources are...

    Part 2 Remember the old saying, “A project plan is not a schedule until resources are committed.” This exercise illustrates this sometime subtle, but important point. Using your files from Part 1, input resources and their costs if you have not already done so. All information is found in Tables A2.1 and A2.2. Prepare a memo that addresses the following questions: 1. Which if any of the resources are overallocated? 2. Assume that the project is time constrained and try...

  • 1. What may a resource calendar not provide? a. Duration of resource availability b. Which resources...

    1. What may a resource calendar not provide? a. Duration of resource availability b. Which resources are available during a planned activity c. Estimation of resource expenses d. Capabilities and skills of human resources 2. Which analysis can result in preparing contingency and response plans to overcome or mitigate the impact of an unexpected situation? a. Critical Chain Method b. What if Analysis c. Critical Path Method d. Fast Tracking 3. The Control Schedule process involves the following, except? a....

  • The following data were obtained from a project to expand a warehouse: Activity Duration Predecessors Resources/cost...

    The following data were obtained from a project to expand a warehouse: Activity Duration Predecessors Resources/cost A 2 weeks -- 1 Excavator/$800 day B 3 weeks -- 1 Excavator/$800 day C 2 weeks -- 1 Concrete Mixer/$250 day D 3 weeks A 1 Crane/$1,000 day E 2 weeks C 1 High-lift/$500 day F 1 week B,D 1 Crane/$1,000 day The contractor has only one machine of each type available at the above costs, and operations cannot be split. Additional equipment...

  • Activity Duration Precedence Problem# 3 For the project information given below (wecks) information a) Draw the...

    Activity Duration Precedence Problem# 3 For the project information given below (wecks) information a) Draw the network diagram to accurately B must be after C represent the information given C must be after A 10 15 b) Determine the earliest start, earliest D must be after B E must be after C F must be after D and E G must be after F H must be after G 1 must be after F finished, latest start, latest finish for...
