| Duration | Direct Cost | Indirect Cost | Total Cost |
| 11 | 730 | 30 | 760 |
| 12 | 740 | 40 | 780 |
| 13 | 770 | 50 | 820 |
| 14 | 960 | 70 | 1030 |
| 15 | 1160 | 90 | 1250 |

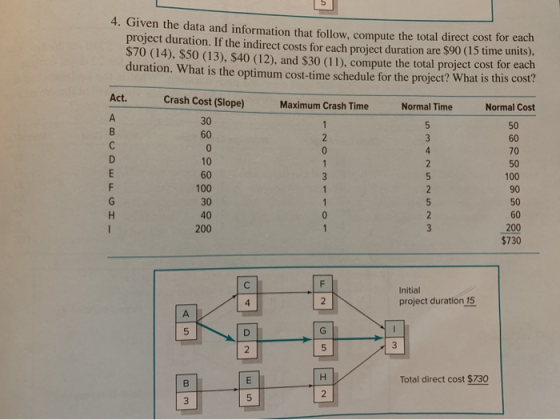

4. Given the data and information that follow, compute the total direct cost for each project...
Q.3. Assume the network and data that follow. Compute the total direct cost for each project duration. If the indirect costs for each project duration are S410 (19 time units), S360 (18), S310 (17), and $260 (16), compute the total project cost for each duration. What is the optimum cost-time schedule for the project? What is this cost? Activity Crash Cost (Slope) Maximum Crash Time Normal Time Normal Cost 20 60 50 60 70 50 100 90 50 S470 10...
Chapter 9 Reducing Project Durarion 327 7. Use the information contained below to compress one time unit per move using the least cost method. Assume the total indirect cost for the project is $2.000 and there is a savings of $100 per time unit reduced. Calculate the total direct, indirect, an graph. What is the optimum cost-time schedule for the project? Note: The correct normal project duration and total direct cost are provi ded. Normal Cost 200 1000 800 1000...
Assume the network and data that follow: ACTIVITY NORMAL TIME (WEEKS) NORMAL COST CRASH TIME (WEEKS) CRASH COST IMMEDIATE PREDECESSORS A 3 $ 60 2 $ 80 — B 5 70 4 110 A C 9 50 6 80 A D 7 100 6 130 A E 8 90 6 100 B F 5 30 3 50 D G 6 110 5 190 C, E, F b. Indicate the critical path when normal activity times are used. A-B-E-G A-C-F-G A-D-E-G...
Megah Holding Sdn. Bhd is in progress to start their housing project. The list of activity and scheduled of the project is proposed as in Table 1. If the indirect costs for each duration is as follows, compute the direct and total cost for each duration. What is the optimum cost-time schedule? Indirect cost 27 weeks – RM 350 26 weeks – RM 270 25 weeks – RM 160 24 weeks – RM 100 12 weeks – RM 70 (12...
Use the information contained
below to compress one time unit per move using the least cost
method. Reduce the schedule until you reach the crash point of the
network. For each move identify what activity(ies) was crashed and
the adjusted total cost. (i.e., Calculate the minimum direct cost
when project is finished in 13 days, 12 days, 11 days, as well as
10 days.)
Note: Choose B instead of C
and E (equal costs) because it is usually smarter to...
62. Task ID Predecessors Normal Time Maximum Crash Time Normal Cost Crash Cost (Slope) 1 - 5 1 50 20 2 - 3 2 60 60 3 1 4 0 70 0 4 1 2 1 50 10 5 2 5 3 100 60 6 3 2 1 90 100 7 4 5 1 50 30 8 5 2 0 60 40 9 6,7,8 3 1 200 200 Consider the project above. If the indirect costs of the project are:...
Cost and schedule data for a small project are given below. Assume an indirect Cost of $ 500/day. Determine the minimum contract duration and project cost. ActivityPreceded by Cost (S) Duration (days) Crash Normal Crash Normal 3900 6500 7200 4900 2200 1700 1200 7200 10000 9450 4700 3600 5500 6350 4700 2050 19 7200 10 4500
The Advanced Tech Company has a project to design an integrated information data base for a major bank. Data for the project are given in the following table. Indirect project costs amount to S150 per day. The company will incur a $100 per day penalty for each day the project lasts beyond day 15. Normal Time Crash Time Crash Cost Immediate Normal Cost ($) Activity (S) (days) (days) Predecessor(s) 6 800 1,200 A 4 6 1,000 2,200 C 600 1...
Also solve for the minimum total cost
associated with finishing the project in 13 weeks and the total
project's duration (and of each activity according to the minimum
cost schedule)
The table below contains data for the installation of new equipment in a manufacturing process at Excello Corporation. Your company is responsible for the installation project. Indirect costs are $10,000 per week, and a penalty cost of $8,000 per week will be incurred by your company for every week the...
Use the information below to compress one-time unit per move using the least cost method. Reduce the schedule until you reach the crash point or the best cost value for this network. For each move identify what activity(s) should be crashed and the adjusted total cost. Total direct cost is $1000, total indirect cost is $800 and each time-unit reduction (cost gain) is $50. Activity Crash Cost per unit-time) Normal Normal Maximum time cost Crash Time 100 150 200 200...
