Question

Use the information below to compress one-time unit per move using the least cost method. Reduce the schedule until you reach
Activity Normal Maximum Normal cost 100 I crash Crash Cost per unit-time) 110 150 200 200 200 190 Total Direct Cost Activitie
0 0
Add a comment Improve this question Transcribed image text
Answer #1

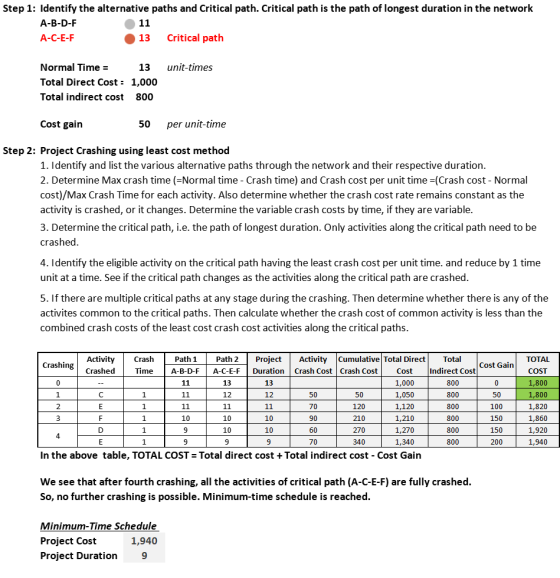

Step 1: Identify the alternative paths and Critical path. Critical path is the path of longest duration in the network A-B-D-

Normal Time = 13

Total Direct Cost =1000

1)

Time = 12

Total Direct Cost =1050

Activities Changed: C

2)

Time = 11

Total Direct Cost =1120

Activities Changed: E

3)

Time = 10

Total Direct Cost =1210

Activities Changed: F

4)

Time = 9

Total Direct Cost =1340

Activities Changed: D, E

Add a comment
