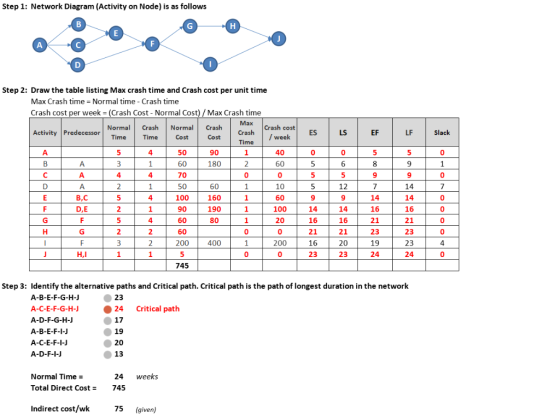

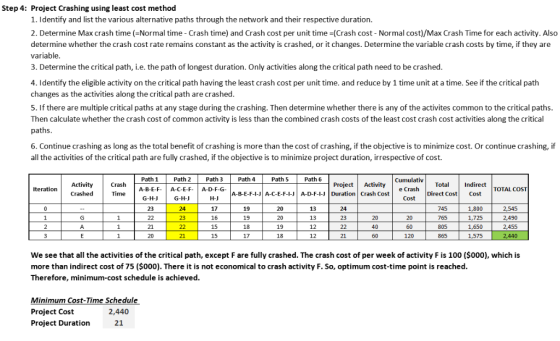

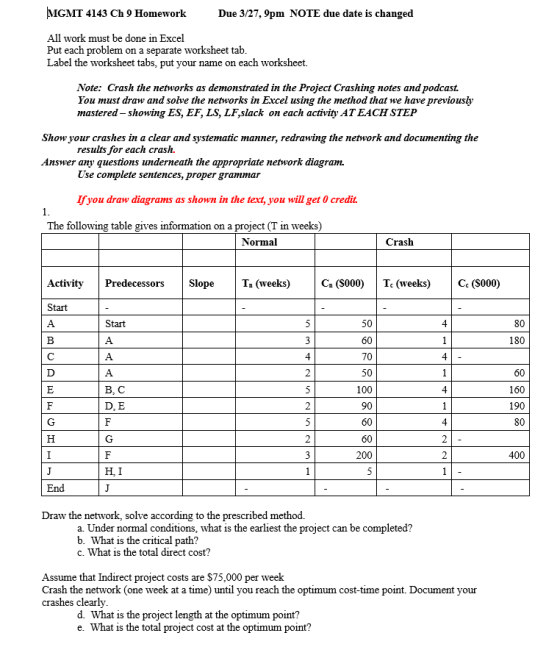

Assume that Indirect project costs are $75,000 per week Crash the network (one week at a time) until you reach the optimum cost-time point. Document your crashes clearly. d. What is the project length at the optimum point?



a) Under normal conditions, earliest project completion time = 24 weeks
b) Critical path is: A-C-E-F-G-H-J
c) Total direct cost = 745 ($000)
d) Project length at optimum point = 21 weeks
e) Total project cost at the optimum point = 2440 ($000) (this is reduced after crashing from original total project cost of 2545)
Assume that Indirect project costs are $75,000 per week Crash the network (one week at a time) un...
Consider the project network information in Table 1 of Case Study A on Page 3 below. Assuming the project starts at time zero and all activity connections are finish-to-start, draw an Activity on the Node (AON) network diagram of the project, determine the expected project completion time, state the critical activities and critical path(s). Crash the project by 1 week and state the total crash cost. (b) (18 narl Case Study A Table 1 below contains activities associated with a...
Consider the project network information in Table 1 of Case Study A on Page 3 below. Assuming the project starts at time zero and all activity connections are finish-to-start, draw an Activity on the Node (AON) network diagram of the project, determine the expected project completion time, state the critical activities and critical path(s). Crash the project by 1 week and state the total crash cost. (b) (18 nar Case Study A Table 1 below contains activities associated with a...
For the project outlined on the following table, (a) draw a
network diagram (arrow or PDM,
as you prefer), and (b) identify the critical path and duration.
(c) Identify the task(s) you
would crash and the incremental cost to reduce project duration by
(i) one week; (ii) a second
week; (iii) a third week.
Duration (Weeks) Cost (Dollars) Task Follows Task(s) Normal Crash Normal Crash (Start) (Start) A, B B C D uun $500 400 600 $600 450 750 550...
Consider a project having the following six activities: Immediate Max Crash cost Activity Predecessors Time (weeks) Crash* per week A none 6 6 N/A B none 5 2 $500 C A 3 2 $1000 D A, B 4 2 $2000 E C, D 5 2 $1250 F D 6 2 $1000 *Shortest possible time for the task 1. Draw the project network and list...
Assume the network and data that follow: ACTIVITY NORMAL TIME (WEEKS) NORMAL COST CRASH TIME (WEEKS) CRASH COST IMMEDIATE PREDECESSORS A 3 $ 60 2 $ 80 — B 5 70 4 110 A C 9 50 6 80 A D 7 100 6 130 A E 8 90 6 100 B F 5 30 3 50 D G 6 110 5 190 C, E, F b. Indicate the critical path when normal activity times are used. A-B-E-G A-C-F-G A-D-E-G...
02:03:17 Question No: 03 If the indirect costs for each duration are $280 for 27 weeks, $240 1or 26 weeks, 5190 tox 25 weeks, 5140 1x 24 weeks 30 ta 7 wees optimum cost-time schedule? The client offers you $10 for every week you shorten the project tom your original network. Wordt you the Crash Time Activity Crush Cost ID (Slopes A 80 B 30 с 40 D 100 F 30 5 11 15 2 50 100 Total Dromid-1300 Time...
Consider a project having the following six activities: Immediate Max Crash cost Activity Predecessors Time (weeks) Crash* per week A none 7 7 N/A B none 3 2 $500 C A 5 3 $1000 D A, B 6 4 $2000 E C, D 4 3 $1250 F D 3 2 $1000 *Shortest possible time for the task 1. Draw the project network and list...
Q.3. Assume the network and data that follow. Compute the total direct cost for each project duration. If the indirect costs for each project duration are S410 (19 time units), S360 (18), S310 (17), and $260 (16), compute the total project cost for each duration. What is the optimum cost-time schedule for the project? What is this cost? Activity Crash Cost (Slope) Maximum Crash Time Normal Time Normal Cost 20 60 50 60 70 50 100 90 50 S470 10...
The table below defines the activities and the normal time duration for each activities within a small project. You can decrease (crash) the durations at an additional expense. Table 1 summarizes the time-cost information for the activities to complete the project. Table 1: The time-cost information for the activities Activity Normal Completion Time (weeks) Immediate Predecessor Crash Time (weeks) Normal cost for activities Crash cost for activities/week A 2 - 1 1200 400 B 3 - 1 1400 500 C...
Megah Holding Sdn. Bhd is in progress to start their housing project. The list of activity and scheduled of the project is proposed as in Table 1. If the indirect costs for each duration is as follows, compute the direct and total cost for each duration. What is the optimum cost-time schedule? Indirect cost 27 weeks – RM 350 26 weeks – RM 270 25 weeks – RM 160 24 weeks – RM 100 12 weeks – RM 70 (12...
