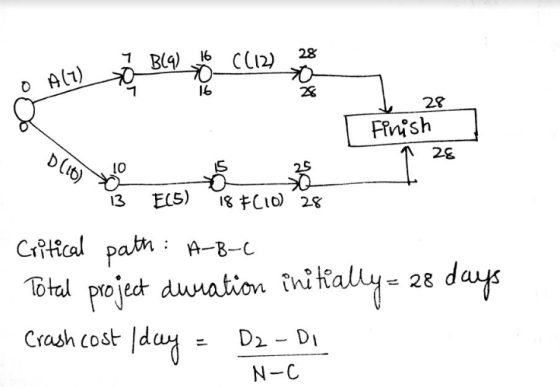

Find the optimal way to achieve a project duration of 27 days? Use the template below to record your steps
InClass – Project Crashing Exercise
Project details:
|
Task |
Predecessor |
N (days) |
C (days) |
D1 ($) |
D2 ($) |
|
A |
start |
7 |
5 |
40 |
80 |
|
B |
A |
9 |
8 |
60 |
70 |
|
C |
B |
12 |
10 |
90 |
150 |
|
D |
start |
10 |
7 |
60 |
120 |
|
E |
D |
5 |
4 |
50 |
60 |
|
F |
E |
10 |
6 |
80 |
140 |
|
Fin |
C, F |
Find the optimal way to achieve a project duration of 27 days? Use the template below to record your steps
Solution
|

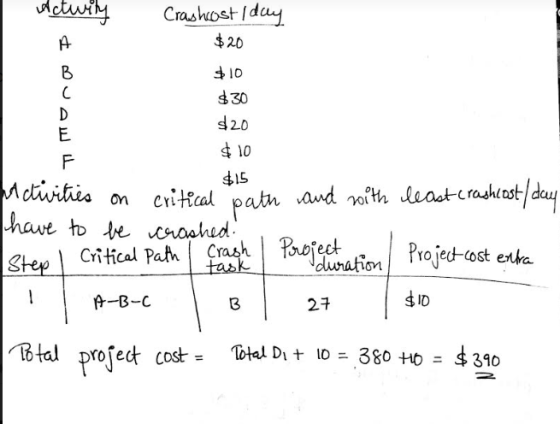

Step |
CP (critical path) |
Crash task |
Project duration |
Project cost |
Find the optimal way to achieve a project duration of 27 days? Use the template below...
Megah Holding Sdn. Bhd is in progress to start their housing project. The list of activity and scheduled of the project is proposed as in Table 1. If the indirect costs for each duration is as follows, compute the direct and total cost for each duration. What is the optimum cost-time schedule? Indirect cost 27 weeks – RM 350 26 weeks – RM 270 25 weeks – RM 160 24 weeks – RM 100 12 weeks – RM 70 (12...
39. Consider the following project, and answer the next 5 questions based on this data: Task ID Duration (Days) Predecessors 2 70 - 3 30 2 4 120 3 5 120 2 6 120 5 7 120 3,6 8 150 3,6 9 115 3,6 10 130 7,9 11 90 7,9 12 30 7,9 13 120 7,9 14 75 10 15 30 14 16 85 6 17 165 16 18 90 16 19 90 17,18 20 20 8,11,13,15,19 What is the...
5.) Consider a project whose activities are listed in the table below. Activity A will have slack time as long as… Activity Immediate Predecessors A None B None C A D B E C, D F E G E a. Duration of A < Duration of B b. Duration of A + Duration of C > Duration of B + Duration of D c. Duration of A + Duration of C < Duration of B + Duration of D...
Q1. (10 marks) Construct an activity on arrow network based on the activity descriptions below. Show all your work. Label activities in the network by their activity letters and node numbers. Remove any redundant dependencies and label dummy activities DUMMY1, DUMMY2, etc. • Activities H, R2, T1 start the project. • Activity T2 can start when Activities H, E1 and S are completed. • Activity E1 also depends on Activity R2. • Activity X follows Activity H and precedes Activity...
You are the project manager for preparing a yacht for the Bond
Blue Water Classic yacht race. Based on your experience and the
data to hand you have prepared the following WBS with its
associated normal and crash costing. Note: Indirect costs are not
to be considered in this problem. The project is proposed to
commence on 1 August 2018. You can ignore the impact of any public
holidays during the project. You are required to: a) Create an AON...
Use the following information for questions 1 to 10. Egon Spengler is planning a charity benefit gala for his “Save the City” campaign. However, because one of his partners, Peter Venkman, has difficulty staying on task, the project is scheduled and they are running out of time. Egon has used project management principles to lay out the task relationships and he finds that if they follow the traditional schedule, as outlined below, they will not have enough time to get...
Case #2 Table 2 Family Planning Research Center Costs Activity A В. Crash Time (days) 3 4 2 1 3 Normal Time (days) 6 8 4 3 7 5 3 6 7 10 10 Dr. John Watage, deputy director of the family planning Research Center in Nigeria's Over-The-River Providence, was assigned the task of organizing and training five teams of field workers to perform educational and outreach activities as part of a large project to demonstrate acceptance of a new...
Question #1: Some of the tasks in this project can be done in
parallel. Prepare a diagram showing the required network of tasks
and define the critical path. What is the length of the project
without crashing? Do not just answer, but show the whole
process.
Question #2: If the critical path is longer than 29 days, what
is the least additional amounting that Dr. Watage can spend and
still achieve this schedule objective (29 days)? Do not just
answer,...
Scenario Operations managers use many techniques to solve problems. Some of these techniques are graphical and can be solved using software tools and programs. Before you start this activity, review the Excel for Operations Management Software page and download Microsoft Excel and the Excel for OM plugin. You will use these tools to solve real-life problems encountered by operations managers. How many times have you waited, not so patiently in the departure area, for your aircraft to be serviced before...
Use this Excel Culminating Project Template (SEE
SCREENSHOT BELOW) to help you get started with your
budget
You are the president of Campus Sweaters, Inc. Campus Sweaters
manufacturers wool pullover v-neck sweaters of various sizes and
colors. You are preparing the budgets for the first quarter of 2016
(January, February, and March). You have the following historical
and projected sales in units:
Actual or Projected
Month
Units
Actual
November
9,000
Actual
December
8,000
Projected
January
11,000
Projected
February
10,000
Projected...
