39.

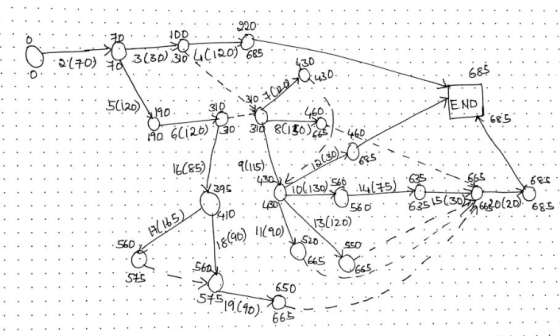

Consider the following project, and answer the next 5 questions based on this data:
| Task ID | Duration (Days) | Predecessors |
| 2 | 70 | - |
| 3 | 30 | 2 |
| 4 | 120 | 3 |
| 5 | 120 | 2 |
| 6 | 120 | 5 |
| 7 | 120 | 3,6 |
| 8 | 150 | 3,6 |
| 9 | 115 | 3,6 |
| 10 | 130 | 7,9 |
| 11 | 90 | 7,9 |
| 12 | 30 | 7,9 |
| 13 | 120 | 7,9 |
| 14 | 75 | 10 |
| 15 | 30 | 14 |
| 16 | 85 | 6 |
| 17 | 165 | 16 |
| 18 | 90 | 16 |
| 19 | 90 | 17,18 |
| 20 | 20 | 8,11,13,15,19 |

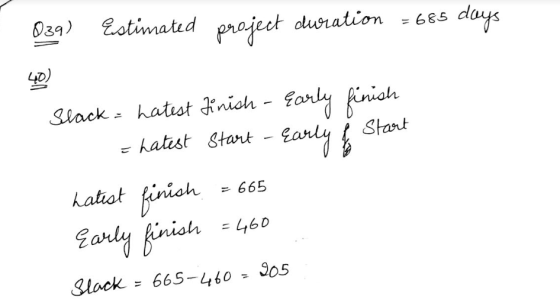

What is the Estimated project duration in days?
|
735 |
||
|
1770 |
||
|
1355 |
||
|
685 |
40.
What is the slack for task 8?
|
205 |
||
|
225 |
||
|
115 |
||
|
145 |
41.

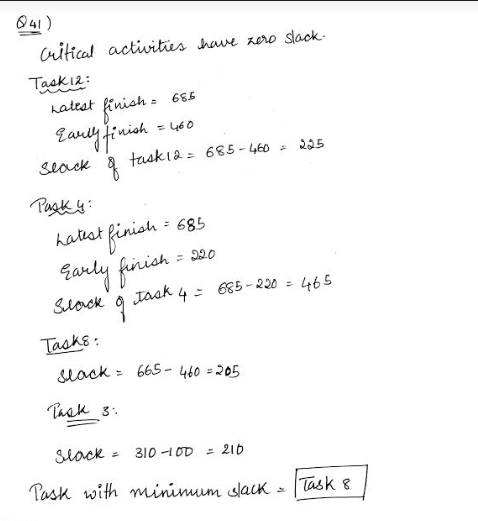

Which is the task with the maximum slack?
|
Task 12 |
||
|
Task 4 |
||
|
Task 8 |
||
|
Task 3 |
42.

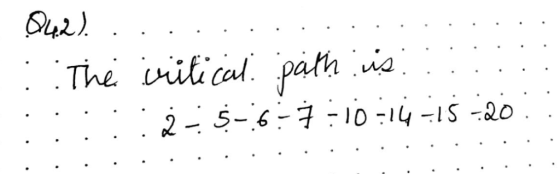

Which is a critical path?
|
2-3-7-10-14-15-20 |
||
|
2-3-7-11-20 |
||
|
2-5-7-10-13-16-19-20 |
||
|
2-5-6-7-10-14-15-20 |
43.
If task 14 takes 15 days longer to complete, the duration of the project would:
|
Stay the same |
||
|
Increase by 15 days |
||
|
Increase by 10 days |
||
|
Cannot say with information provided |
44.
Consider the project below. The earliest start time is 0, and latest finish is 55 days. Answer the next 10 questions based on this data.
Without considering the lag relationships, the duration of the project in days, would be:
|
Task ID |
Duration |
F-to-S Predecessor |
Lag Relationships |
Lag Time |
|
1 |
3 |
- |
- |
|
|
2 |
5 |
1 |
- |
|
|
3 |
6 |
1 |
Finish 3 to Finish 6 |
10 |
|
4 |
9 |
1 |
- |
|
|
5 |
8 |
2,3 |
Finish 5 to Finish 7 |
7 |
|
|
Finish 3 to Start 5 |
9 |
||
|
6 |
6 |
4 |
- |
|
|
7 |
7 |
6 |
Start 7 to Start 8 |
8 |
|
8 |
7 |
- |
- |
|
|
9 |
12 |
5,8 |
Finish 9 to Finish 10 |
5 |
|
10 |
5 |
7,9 |
- |
|
28 |
||
|
20 |
||
|
30 |
||
|
34 |
45.
Without considering the lag relationships, a critical path for the project would be:
|
1-8-9-10 |
||
|
8-9-10 |
||
|
1-3-5-9-10 |
||
|
1-2-5-9-10 |
46.
Without considering the lag relationships, the slack (in days) for any critical task would be:
|
27 |
||
|
20 |
||
|
35 |
||
|
21 |
47.
After considering the lag relationships, the duration of the project in days would be:
|
45 |
||
|
47 |
||
|
49 |
||
|
51 |
48.
After considering the lag relationships, the Earliest Start for Task 5 in days would be:
|
20 |
||
|
23 |
||
|
21 |
||
|
18 |
49.
After considering the lag relationships, the Earliest Finish for Task 6 in days would be:
|
19 |
||
|
18 |
||
|
29 |
||
|
22 |
50.
After considering the lag relationships, the Earliest Finish for Task 7 in days would be:
|
29 |
||
|
38 |
||
|
31 |
||
|
33 |
51.
After considering the lag relationships, the task with the minimum start slack would be Task
|
6 |
||
|
9 |
||
|
5 |
||
|
2 |
52.
After considering the lag relationships, the task with the maximum finish slack would be Task
|
9 |
||
|
5 |
||
|
4 |
||
|
2 |
53.
After considering the lag relationships, the task with the minimum finish slack would be Task:
|
8 |
||
|
2 |
||
|
7 |
||
|
5 |
39. Consider the following project, and answer the next 5 questions based on this data: Task...
Consider the following project: Task ID Duration (Days) Predecessors 2 70 - 3 30 2 4 120 3 5 120 2 6 120 5 7 120 3,6 8 150 3,6 9 115 3,6 10 130 7,9 11 90 7,9 12 30 7,9 13 120 7,9 14 75 10 15 30 14 16 85 6 17 165 16 18 90 16 19 90 17,18 20 20 8,11,13,15,19 What is the slack for task 8?
Given the following information about a small project, Task Duration Immediate Estimates Predecessors A 2 days None B 5 days A C 4 days B D 9 days A E 4 days B & D F 12 days E & C Draw a network diagram. Identify the critical path, earliest start and finish and slack for each task. Using MS Excel, produce a Gantt chart for this project. What would happen if a new estimate for task D increases...
Consider a project having the following six activities: Immediate Max Crash cost Activity Predecessors Time (weeks) Crash* per week A none 6 6 N/A B none 5 2 $500 C A 3 2 $1000 D A, B 4 2 $2000 E C, D 5 2 $1250 F D 6 2 $1000 *Shortest possible time for the task 1. Draw the project network and list...
Consider a project having the following six activities: Immediate Max Crash cost Activity Predecessors Time (weeks) Crash* per week A none 7 7 N/A B none 3 2 $500 C A 5 3 $1000 D A, B 6 4 $2000 E C, D 4 3 $1250 F D 3 2 $1000 *Shortest possible time for the task 1. Draw the project network and list...
Basic Project Management Lesson 6. Exercises 1. The AOA diagram of a project is shown below. The duration of each activity in days is shown by its side. a. Calculate the earliest and latest schedules of each event. b. Show the critical path by thickening the critical arrows. c. Fill in the Slack Table. -- a 15 Start Finish 11 13 Slack Table: Task 1-2 1-3 2-3 2-4 Slack TTT 2-5 3-5 | 3-7 | 4-6 5-6 5-7 5-8 6-8...
1. Consider the following table providing the needed tasks to completing a successful project. The first column provides the name of the task, the second column states the time to complete that task and the third column tells when a task can begin. Task Time to Condition to start task complete #1 #2 #3 #4 #5 #6 #7 #8 #9 #10 #11 #12 #13 #14 #15 #16 #17 #18 #19 7 days None 5 days 8 daysNone 4 days 3...
Assignment for week 5Given the following information, draw the project network. Compute the early, late and slack times for the project network. which activities are on the critical path have only the start or finish of the activity on the critical path?ID duration finish to start finish to start additional lag lag predecessor lag Relationship A 2 none 0 none 0B 4 A 0 none 0C 6 A 0 finish-finish C to F 7D 8 A 0 none 0E 18...
Consider the following information about a small project:
Task
Duration Estimates
ImmediatePredecessors
A
2
days
None
B
3
days
A
C
3
days
B
D
4
days
A
E
1
day
B & D
F
9
days
E & C
b-1. Identify the critical path.
A-B-C-F
A-B-E-F
A-D-E-F
b-2. Identify the earliest start and finish,
and slack for each task. (Leave no cells blank - be certain
to enter "0" wherever required.)
c. Which of these activities should the project...
Please solve the following problems related to Chapter 17: Project Management: 1. Based on the following AOA diagram, please answer the following question: (1) Determine the critical path and the expected project duration (2) Determine the following quantities for each activity: the earliest start time, the latest start time, the earliest finish time and the latest finish time and the slack time. C17) F (5) 1 (61 A(4) D (11) G (3) H(101 B (10) E (12)
Consider the following information about a small project:
b-1.
Identify the critical path.
A. A-D-E-F
b. A-B-C-F
C. A-B-E-F
Identify the earliest
start and finish, and slack for each task. (Leave no cells
blank - be certain to enter "0" wherever required.)
c.
Which of these activities should the project manager track most
closely?
A. A-B-E-F
b. A-D-E-F
c. A-B-C-F
Problem 15.6 Task Duration Estimate (in Days) Immediate Predecessors None А B A B and D E and C Earliest...
