Question

Problem 3.28 - Bookmatch Problem The following is a table of activities associated with a project...

Problem 3.28 - Bookmatch

Problem The following is a table of activities associated with a project at Rafay​ Ishfaq's software firm in​ Chicago, their​ durations, what activities each must precede and the crash cost to reduce duration per​ week:

Activity

Duration​ (weeks)

Precedes

Crash​ Cost/Week

A​ (start)

11

​B, C

$ 400

B

11

E

$ 100

C

44

F

$ 200

E

22

F

$ 300

F​ (end)

22

long dash—

$ 400

Suppose that Rafay is only given 5 weeks​ (instead of7​) to complete the project. By how many weeks should each activity be crashed in order to meet the​deadline? Assume that you can crash an activity down to 0 weeks duration.

Activity

Each Activity Should be Reduced BY

​(days)

A ?
B ?
C ?

E

?
D ?
0 0
Add a comment Improve this question Transcribed image text
Answer #1

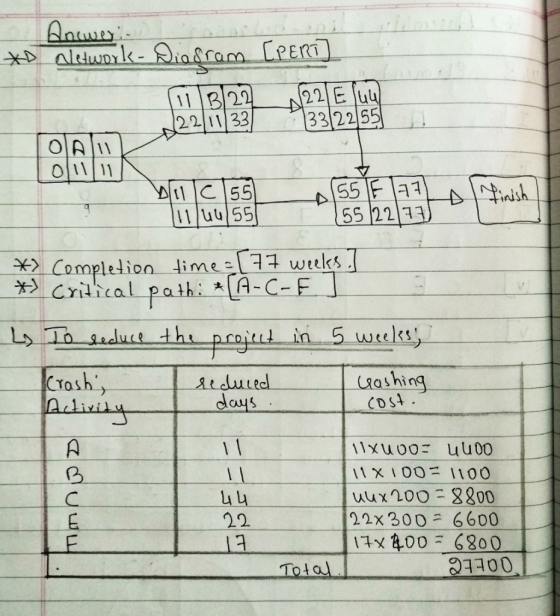

Answer

(Please like the answer it will encourage me.)

Add a comment
Know the answer?
Add Answer to:
Problem 3.28 - Bookmatch Problem The following is a table of activities associated with a project...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • The following is a table of activities associated with a project at Rafay Ishfaq's software firm...

    The following is a table of activities associated with a project at Rafay Ishfaq's software firm in Chicago, their durations, what activities each must precede and the crash cost to reduce duration per week: Duration (weeks) Activity A (start) Precedes B, C Crash Cost/Week $400 $100 $200 $300 $400 F F (end) 2 Suppose that Rafay is only given 5 weeks (instead of 7) to complete the project. By how many weeks should each activity be crashed in order to...

  • The following is a table of activities associated with a project at Rafay​ Ishfaq's software firm...

    The following is a table of activities associated with a project at Rafay​ Ishfaq's software firm in​ Chicago, their​ durations, what activities each must precede and the crash cost to reduce duration per​ week: Activity Duration​ (weeks) Precedes Crash​ Cost/Week A​ (start) 2 ​B, C $ 370 B 2 E $ 130 C 4 F $ 200 E 1 F $ 150 F​ (end) 2 — $ 420 Suppose that Rafay is only given 5 weeks​ (instead of 8​) to...

  • Suppose that Rafay is only given 7 weeks (instead of 10) to complete the project ....

    Suppose that Rafay is only given 7 weeks (instead of 10) to complete the project . By how many weeks should each activity be crashed in order to meet the deadline? Assume that you can crash an activity down to 0 weeks duration. Activity Each Activity Should be Reduced BY (weeks) A (weeks)- ? B (weeks)- ? C (weeks)- ? D (weeks)- ? E (weeks)- ? F (weeks)- ? What is the total crashing cost ? The following is a...

  • The following is a table of activities associated with a project at Rafay Ishfaq's software firm...

    The following is a table of activities associated with a project at Rafay Ishfaq's software firm in Chicago, their durations and what activities each must precede: Duration(Weeks) Activity Precedes 3 A(start) В.С В 2 5 C F E 2 F F(end) b- The activites on the critical path are: A C- F c- The total project completion time for Rafay Ishfaq's software firm is weeks. d- Determine the slack time for each of the activities. e- What is the total...

  • The following is a table of activities associated with a project at Rafay Ishfaq's software firm...

    The following is a table of activities associated with a project at Rafay Ishfaq's software firm in Chicago, their durations and what activities each must precede: Activity A (start) B с E F(end) Duration (weeks) 3 8 3 4 Precedes B, C F E F 2 This exercise contains only parts b, c, and d. b) The activities on the critical path are A-B-F c) The total project completion time for Rafay Ishfaq's software firm is 13 weeks. (Enter your...

  • The following is a table of activities associated with a project at Rafay Ishfaq's software firm...

    The following is a table of activities associated with a project at Rafay Ishfaq's software firm in Chicago, their durations and what adivities each must precede Activity Duration (weeks) Precedes A (start) Fendi This exercise contains only parts and d. b) The activities on the critical path are c) The total project completion time for Rafay Ishlad's software firm is weeks. (Enter your response as a whole number) d) Determine the slack time for each of the activities. (Enter your...

  • The following is a table of activities associated with a project at Rafay​ Ishfaq's software firm...

    The following is a table of activities associated with a project at Rafay​ Ishfaq's software firm in​ Chicago, their durations and what activities each must​ precede: Activity Duration​ (weeks) Precedes A​ (start) 2 ​B, C B 2 E C 6 F E 3 F F​ (end) 4 — This exercise contains only parts​ b, c, and d. ​b) Define the critical​ path, listing all critical activities in chronological order. Critical path activities are the activities that lie on the longest...

  • Consider a project having the following six activities:

    Consider a project having the following six activities:                                                      Immediate                                                  Max        Crash cost             Activity                           Predecessors           Time (weeks)             Crash*    per week                   A                                none                                    6                          6                N/A                   B                                none                                    5                          2               $500                   C                                A                                       3                          2             $1000                   D                                A, B                                    4                          2             $2000                   E                                 C, D                                    5                          2             $1250                   F                                D                                       6                          2             $1000                                                                                                 *Shortest possible time for the task 1. Draw the project network and list...

  • Consider a project having the following six activities:

    Consider a project having the following six activities:                                                      Immediate                                                  Max            Crash cost             Activity                           Predecessors          Time (weeks)             Crash*    per week                   A                                none                                    7                          7         N/A                   B                                none                                    3                          2        $500                   C                                A                                       5                          3      $1000                   D                                A, B                                    6                          4      $2000                   E                                 C, D                                    4                          3      $1250                   F                                D                                       3                          2      $1000                                                                                                 *Shortest possible time for the task 1. Draw the project network and list...

  • Use a PERT network to establish the expected duration for the project described in the table...

    Use a PERT network to establish the expected duration for the project described in the table below:    (SHOW the PERT NETWORK) Activity Predecessors Duration a        m       b Exp. Duration Var. Crash Week 1 Crash Week 2 A - 3 6 9 700 100 B A 6 7 14 600 200 C A 4 6 14 400         600 D B, C 4 6 8 200                             600 E B, C 6 9 12 400 300 F C 4 6 14...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
