Question

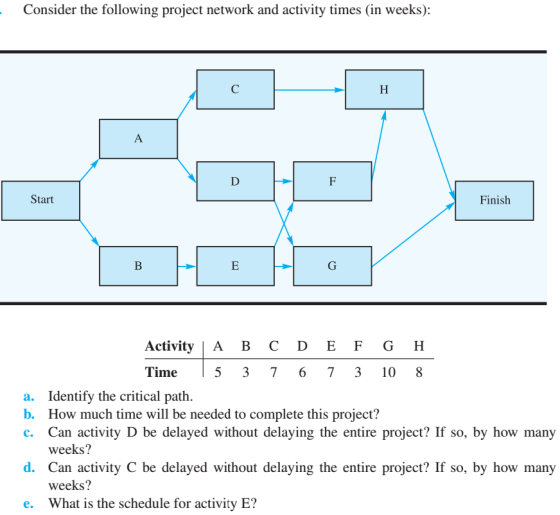

Consider the following project network and activity times (in weeks): Start Finish Activity | A B C D E F G H Time 5 37 6 7 3

0 0
Add a comment Improve this question Transcribed image text
✔ Recommended Answer
Answer #1

1. A - D - F - H

2. 22

3. NO, activity D is on the critical path.

4. YES, slack of C = 2

5. In the table below.

EXPLANATION

To utilize the CPM method, we will make use of a forward and backward pass of the project diagram and the activities to find the ES, EF, LS, and LF values.

The ES, EF values are calculated using a forward pass where the ES of the next activity is the maximum EF of all the predecessor activities.

The LS, LF values are calculated using a backward pass where the LS of the next activity is the minimum LF of all the predecessor activities.


ACTIVITY

TIME

ES

EF

LS

LF

SLACK

A

5

0

5

0

5

0

B

3

0

3

1

4

1

C

7

5

12

7

14

2

D

6

5

11

5

11

0

E

7

3

10

4

11

1

F

3

11

14

11

14

0

G

10

11

21

11

21

0

H

8

14

22

14

22

0


DURATION = CPM = A - D - F - H = 22
